Construction Updates

Nashua - Merrimack - Bedford 13761

>> Click here for latest News Release

Project 13761D

Turnpike Widening near NH 101/I-293 Interchange

Recent Activities – As of mid-September 2023

• Northbound

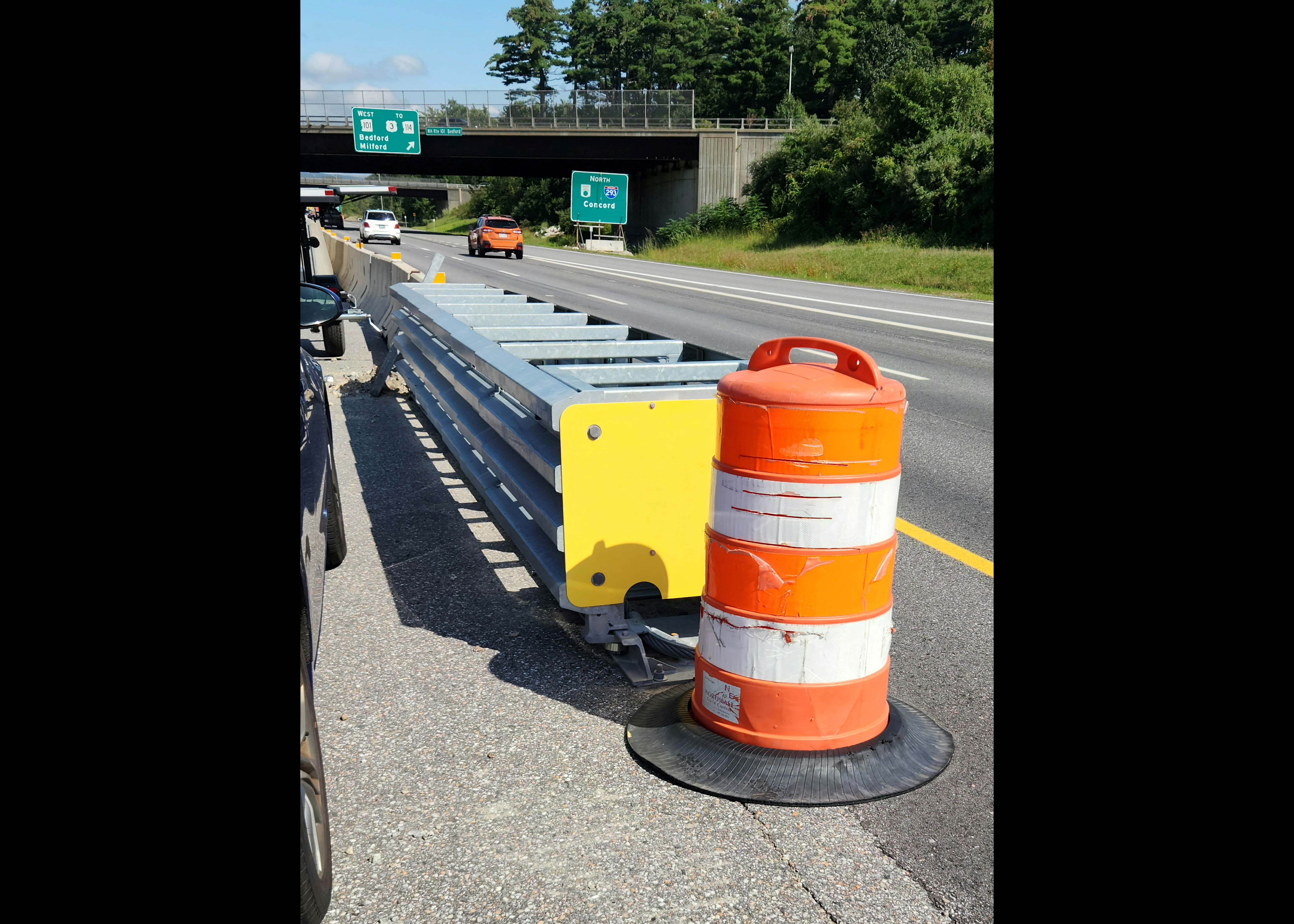

– Placed temporary barrier and attenuators for Phase 2 traffic configuration
– Planted 23 trees along berm near I-293 SB off ramp

• Southbound
– Installed bituminous curb on NH 101 EB ramp to FEET SB
– Fine graded and paved between NH 101 ramps and EB ramp to FEET SB and installed guardrail and end sections

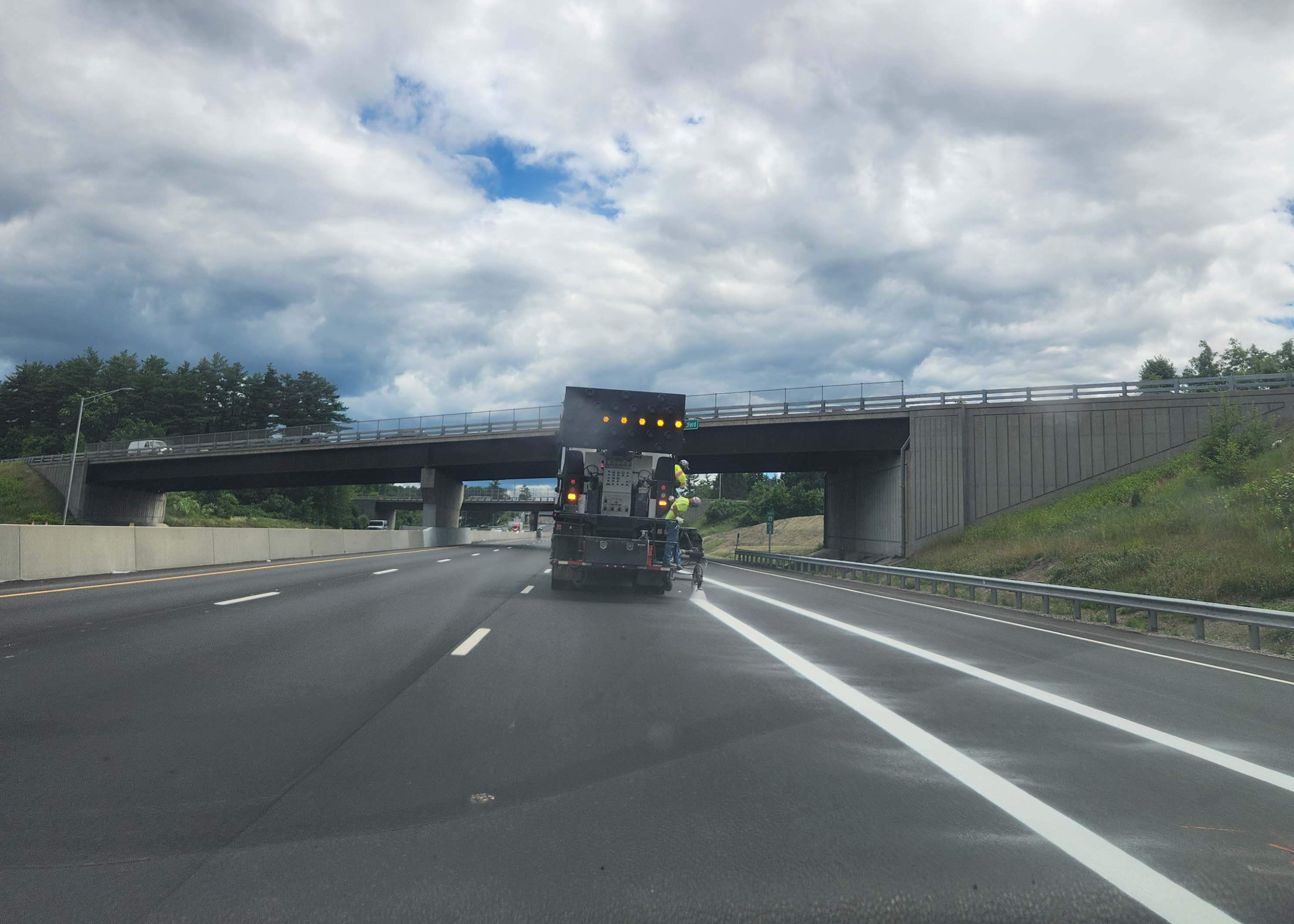

– Installed new pavement and pavement markings for Phase 2 traffic configuration from NH 101 WB to FEET SB on ramp to south end of project

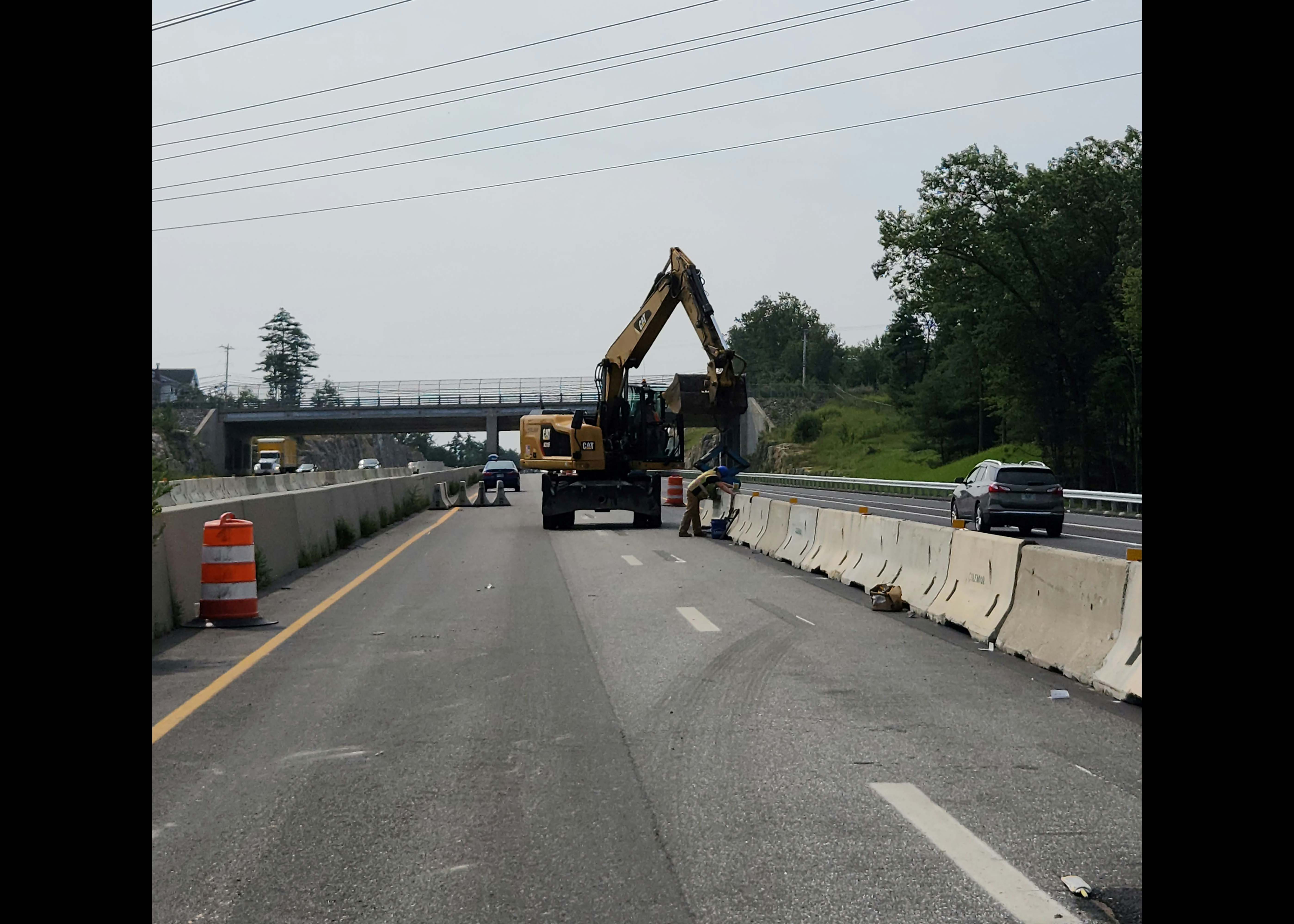

– Placed temporary barriers for Phase 2 traffic configuration and switched traffic
– Removed temporary ramps from Phase 1 traffic configuration

• NB and SB

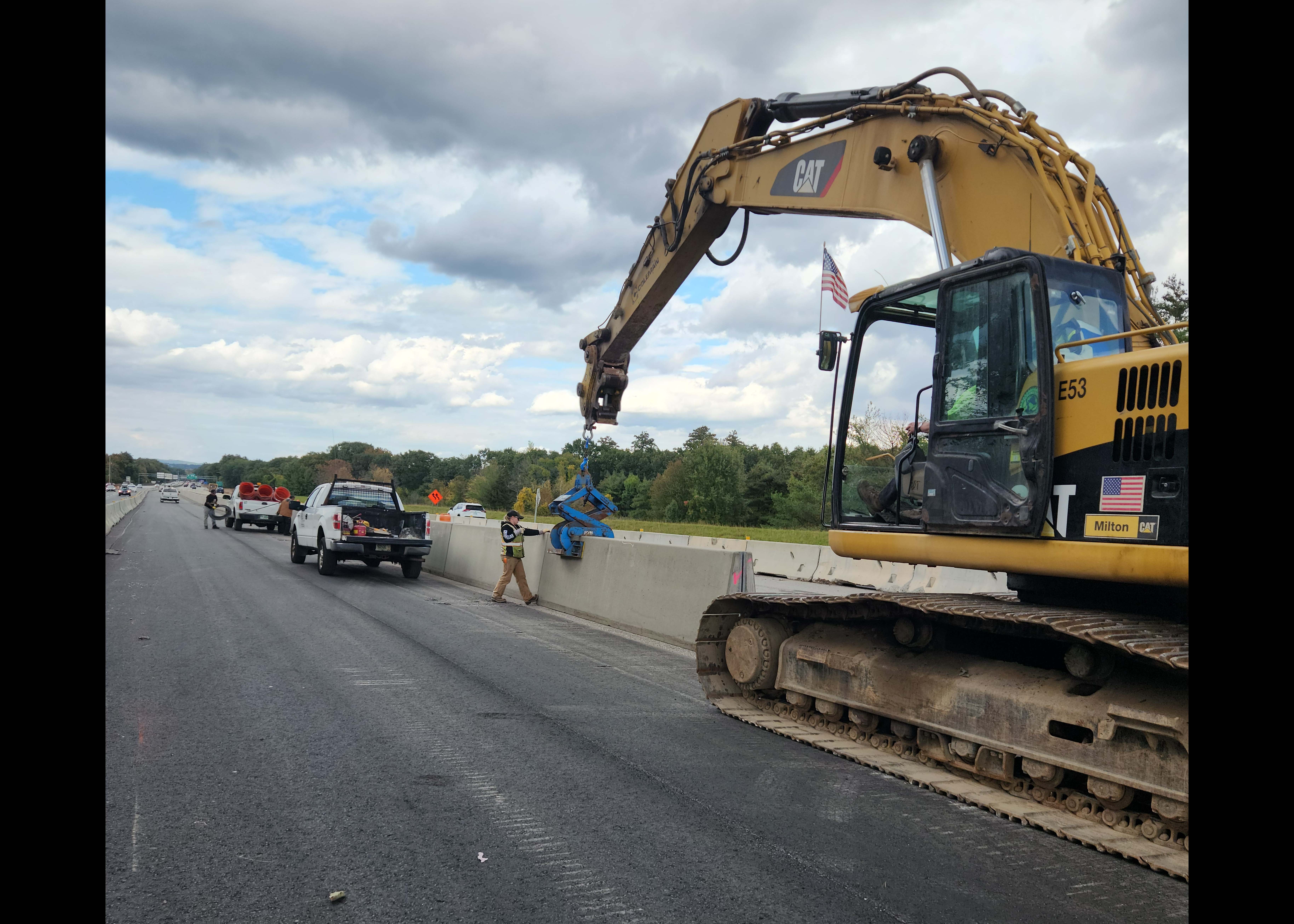

– Began removal of median barriers in preparation for installation of new drainage pipes

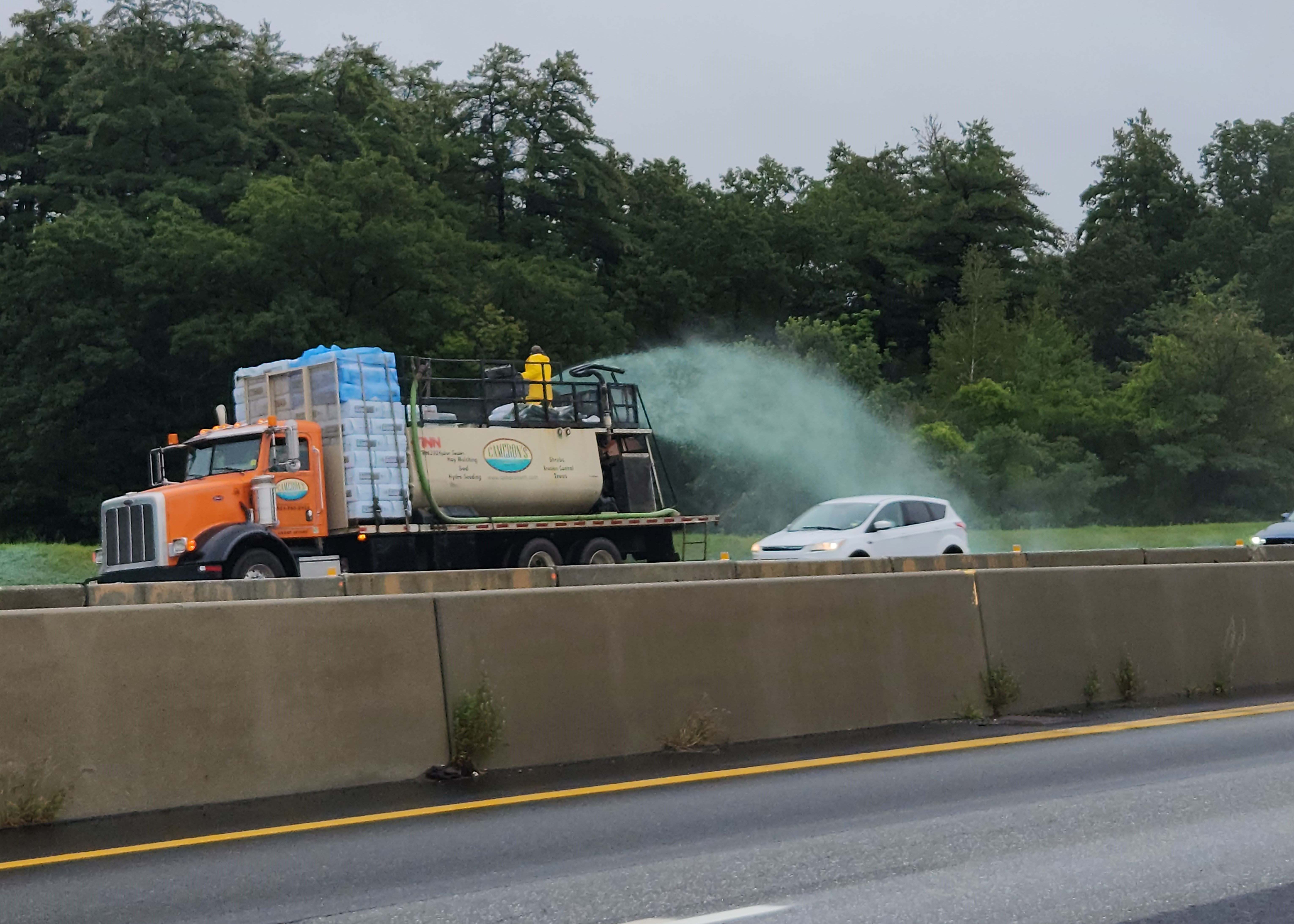

– Continued placement of humus and hydroseeding operations adjacent to both roadways
– Filled existing box culvert (cattle crossing previously abandoned)

Upcoming Work – September 2023 to October 2023

• Northbound
– Continue placing temporary barrier along mainline and switch traffic to Phase 2 traffic configuration – Continue installing new signs and applying humus and seeding – Begin adjusting drainage structures and other drainage work

• Southbound
– Continue placing temporary barrier and temporary striping along mainline for anticipated traffic shift

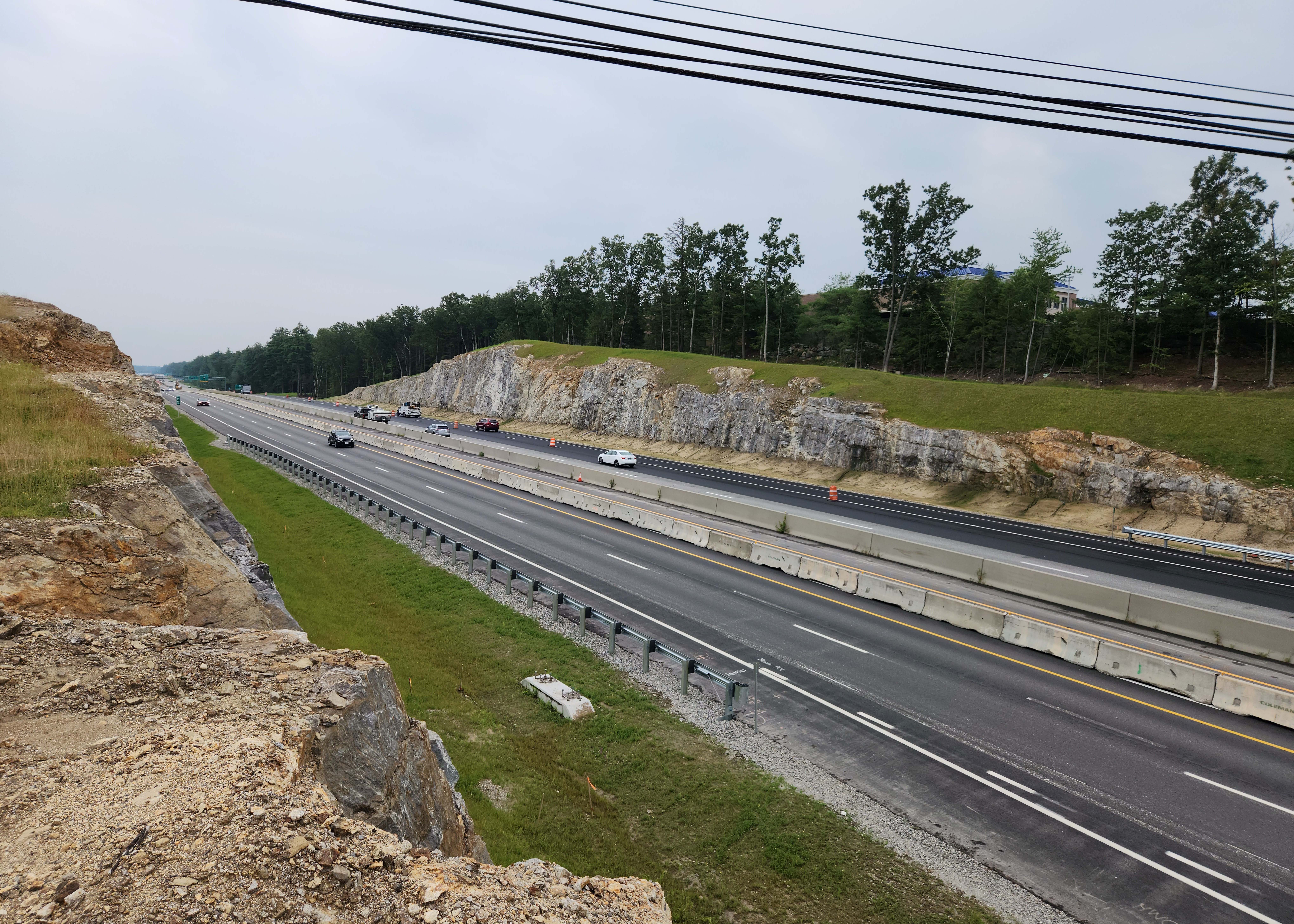

– Switch traffic to Phase 2 traffic configuration

General Traffic Implications

• Fall 2023
– Shoulder and lane closures, as needed, for paving, striping, and Phase 2 construction operations

Recent Photos of Construction

69 / 69
68 / 69
67 / 69
66 / 69
65 / 69
64 / 69
63 / 69
62 / 69
61 / 69
60 / 69
59 / 69
58 / 69
57 / 69
56 / 69
55 / 69
54 / 69
53 / 69
52 / 69
51 / 69
50 / 69
49 / 69
48 / 69
47 / 69
46 / 69
45 / 69
44 / 69
43 / 69
42 / 69
41 / 69
40 / 69
39 / 69
38 / 69
37 / 69
36 / 69
35 / 69
34 / 69
33 / 69
32 / 69
31 / 69
30 / 69
29 / 69
28 / 69
27 / 69
26 / 69
25 / 69
24 / 69
23 / 69
22 / 69
21 / 69
20 / 69
19 / 69
18 / 69
17 / 69
16 / 69
15 / 69
14 / 69
13 / 69
12 / 69
11 / 69
10 / 69
9 / 69
8 / 69
7 / 69
6 / 69
5 / 69
4 / 69
3 / 69
2 / 69
1 / 69

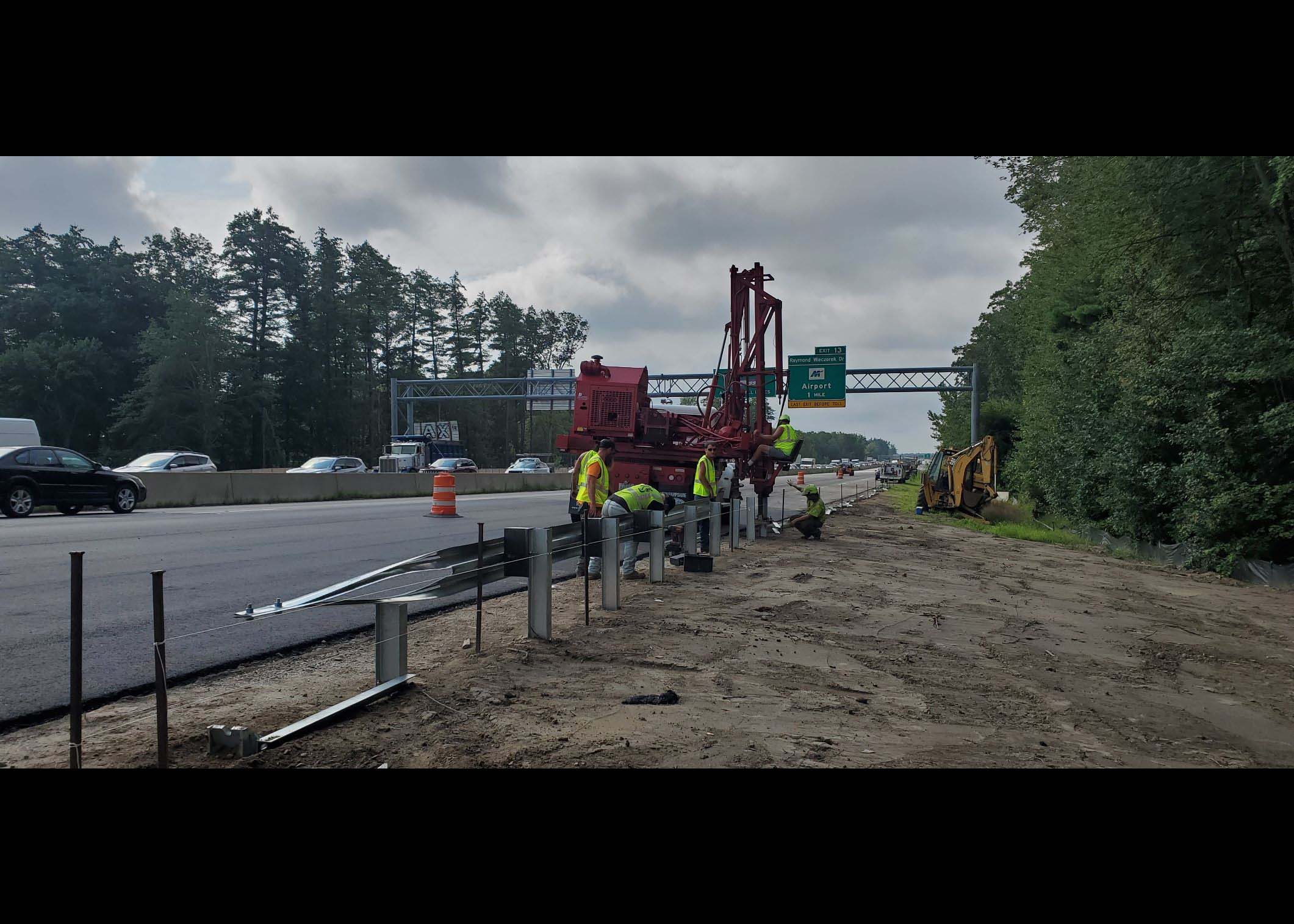

SB Guardrail Installation Work – August 2023

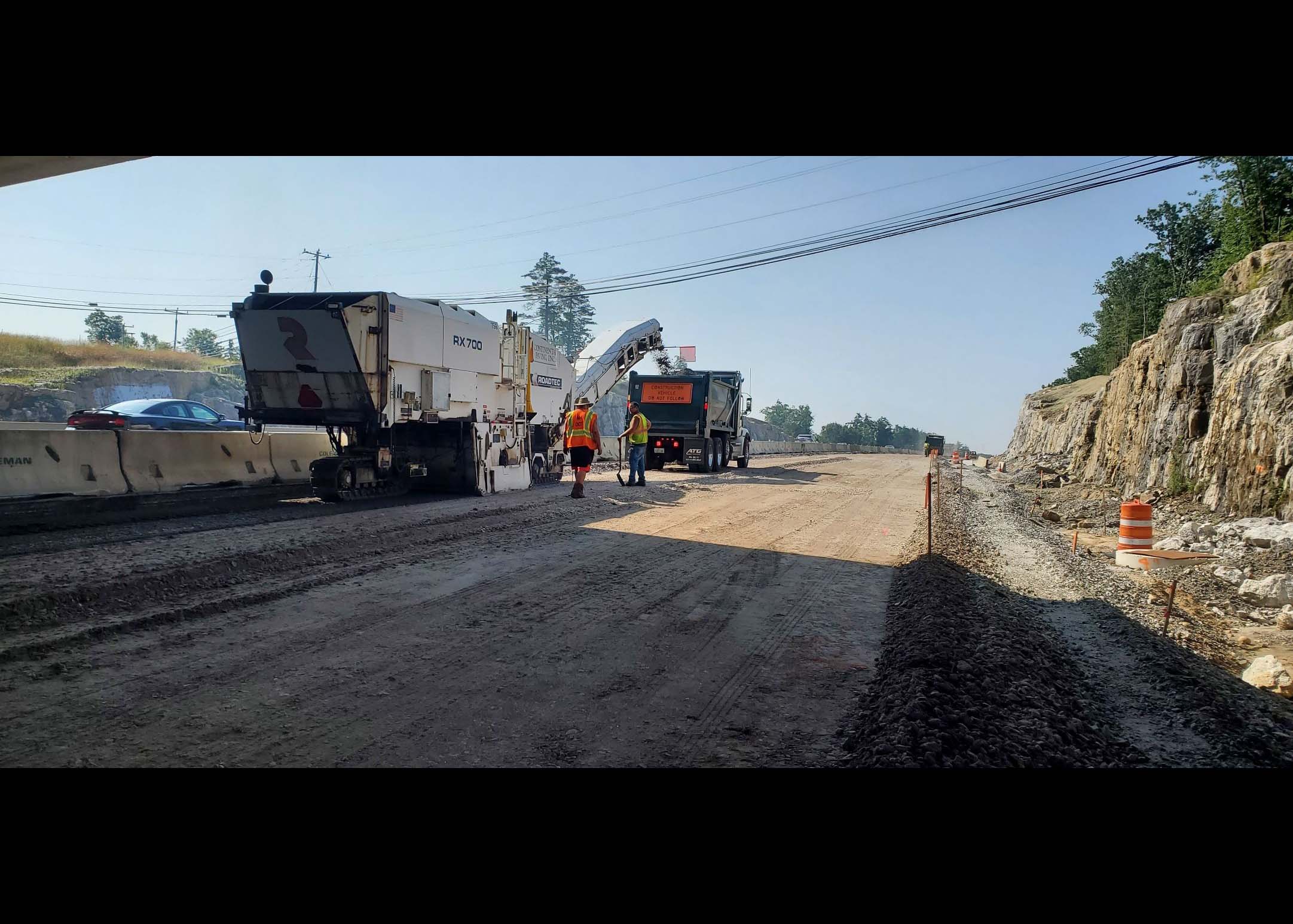

SB Milling Operations – August 2023
Adjusting Drainage Structure Along SB Mainline – August 2023
Temporary Barrier Along NB Mainline – August 2023

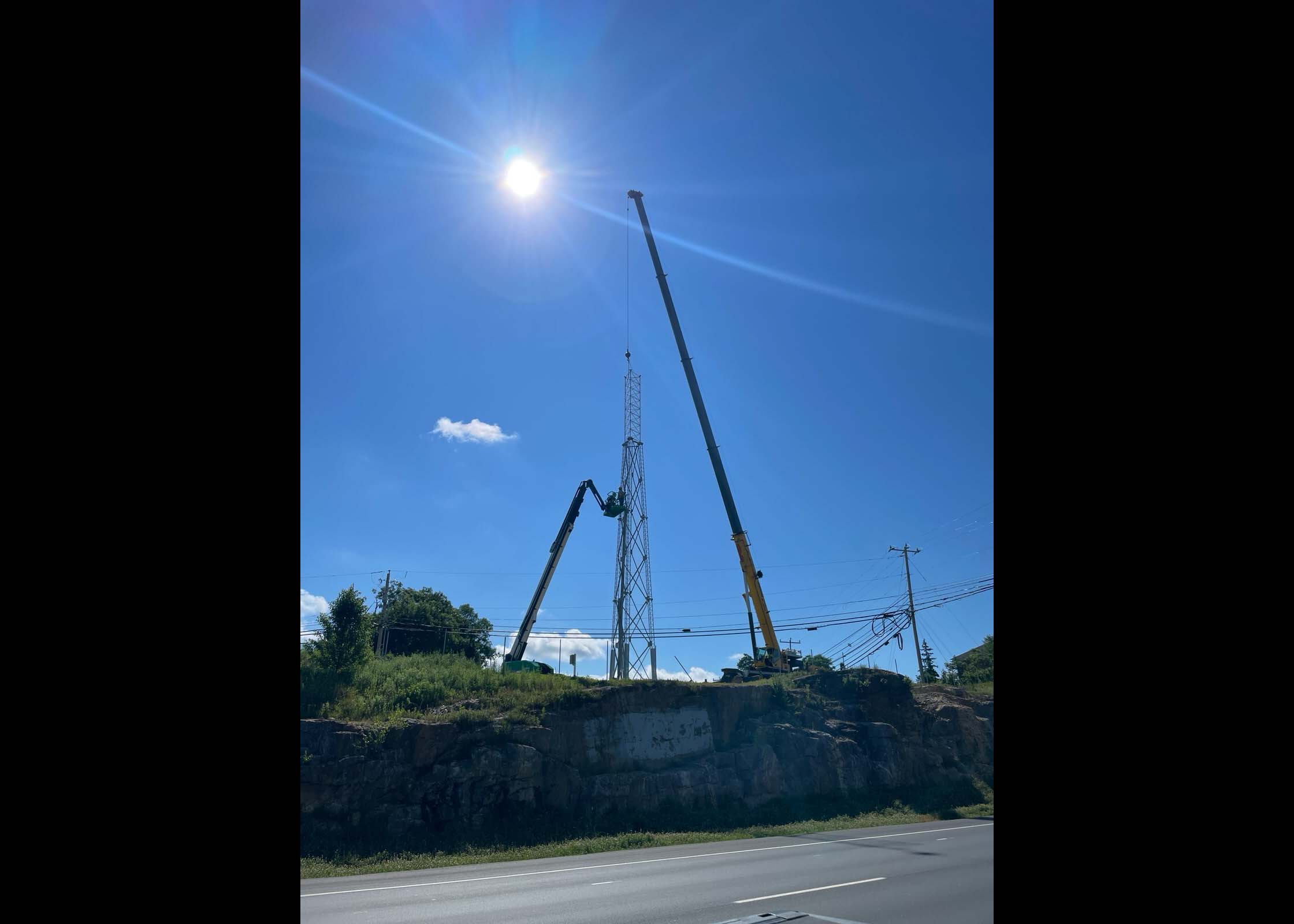

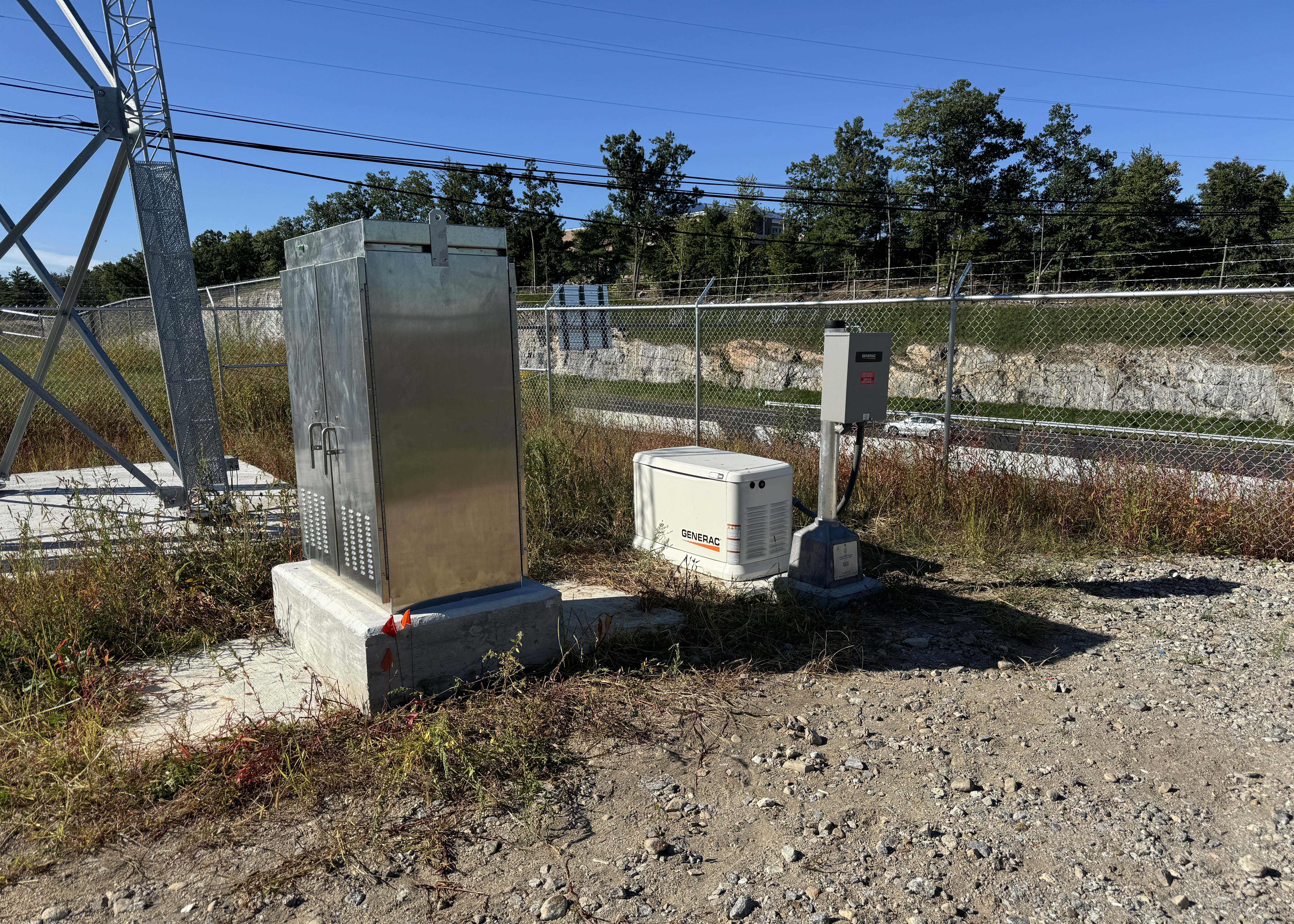

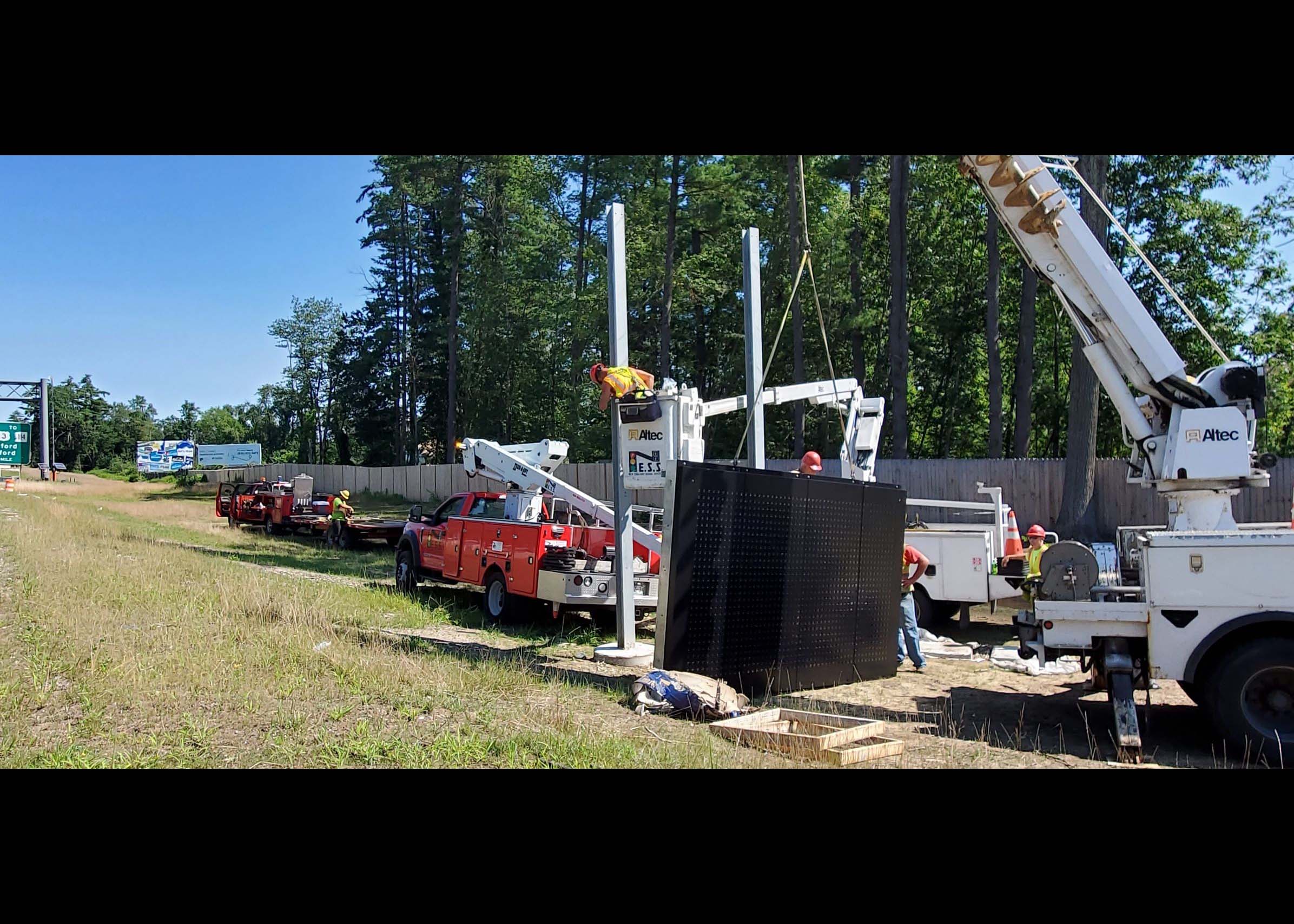

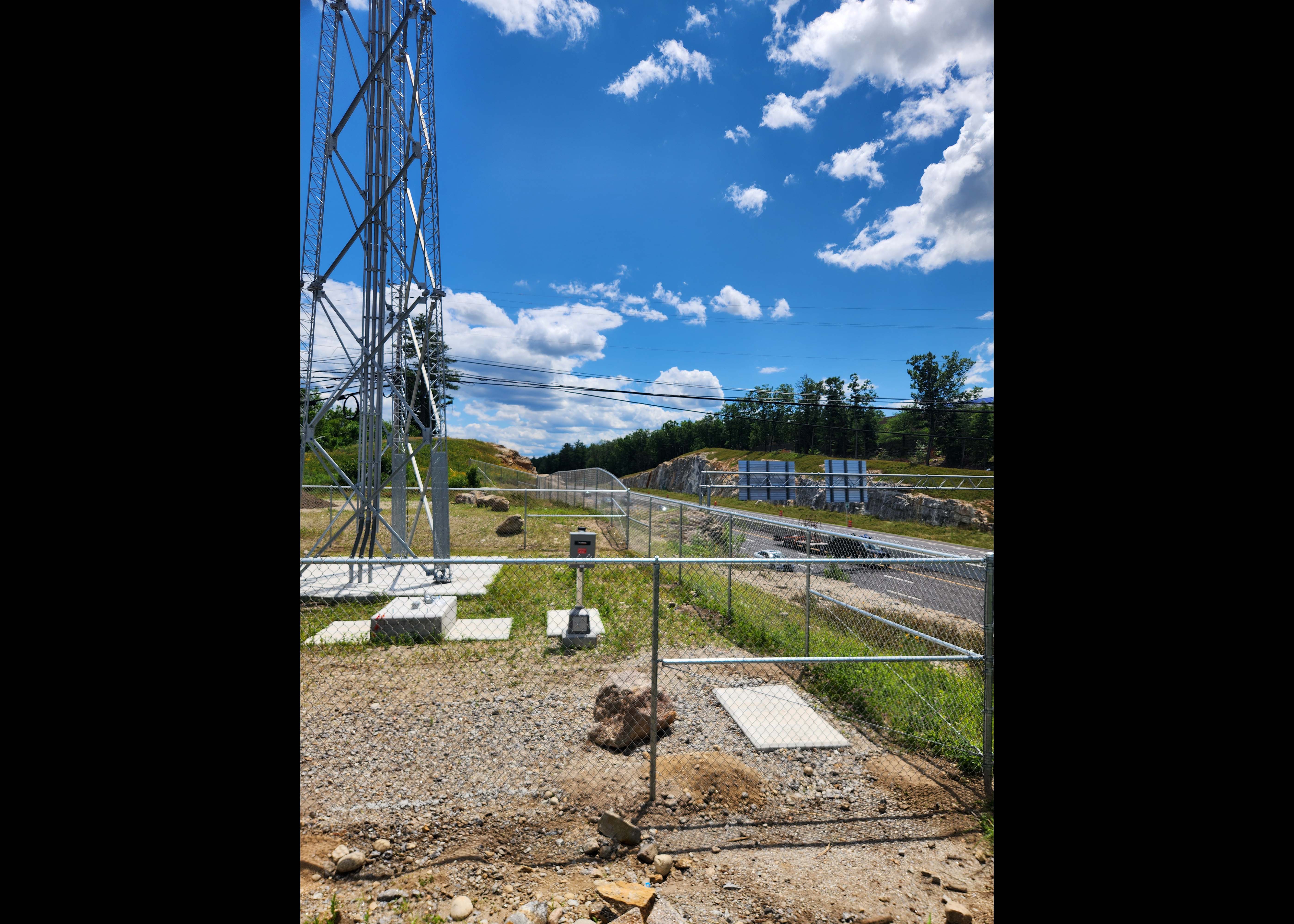

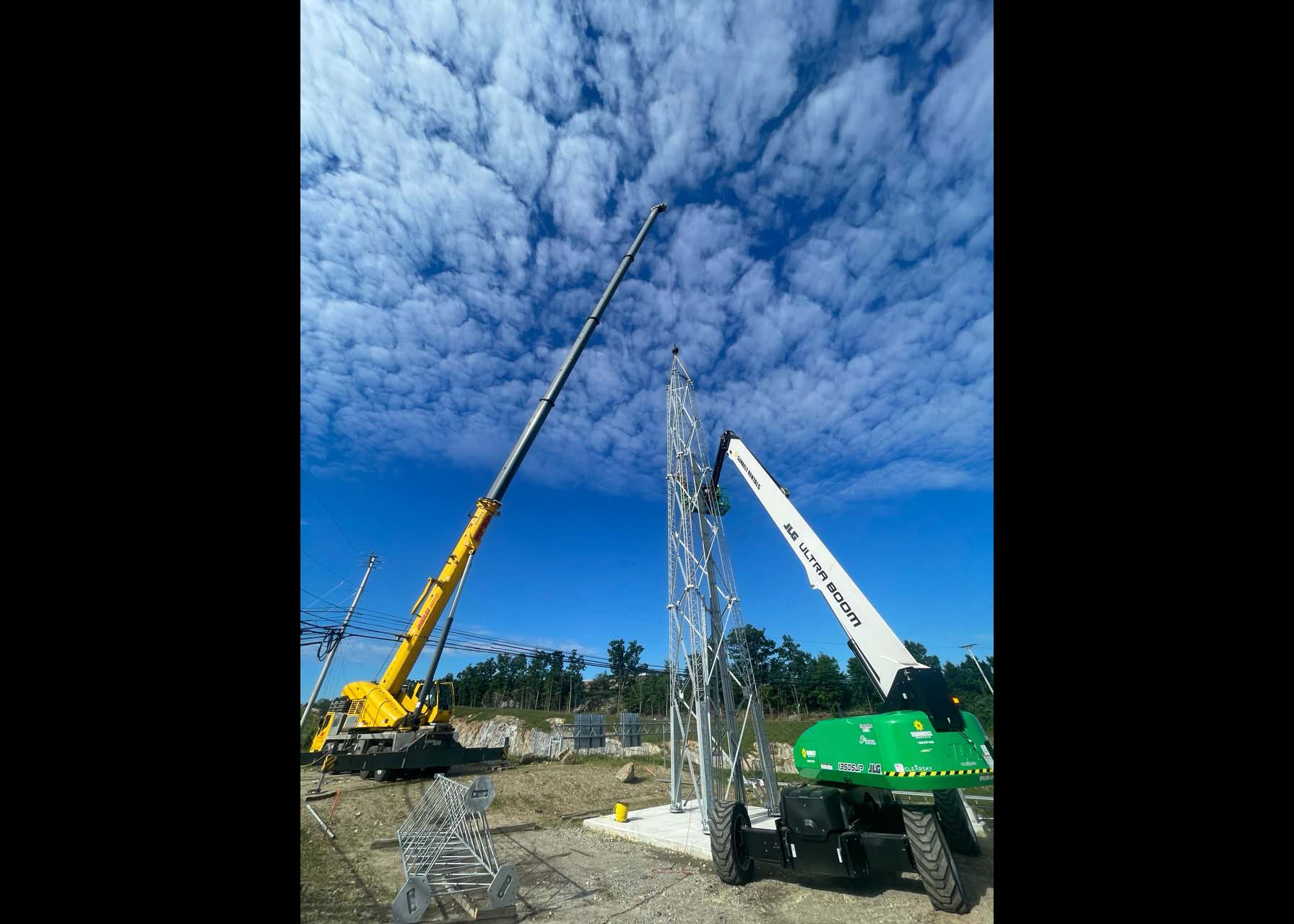

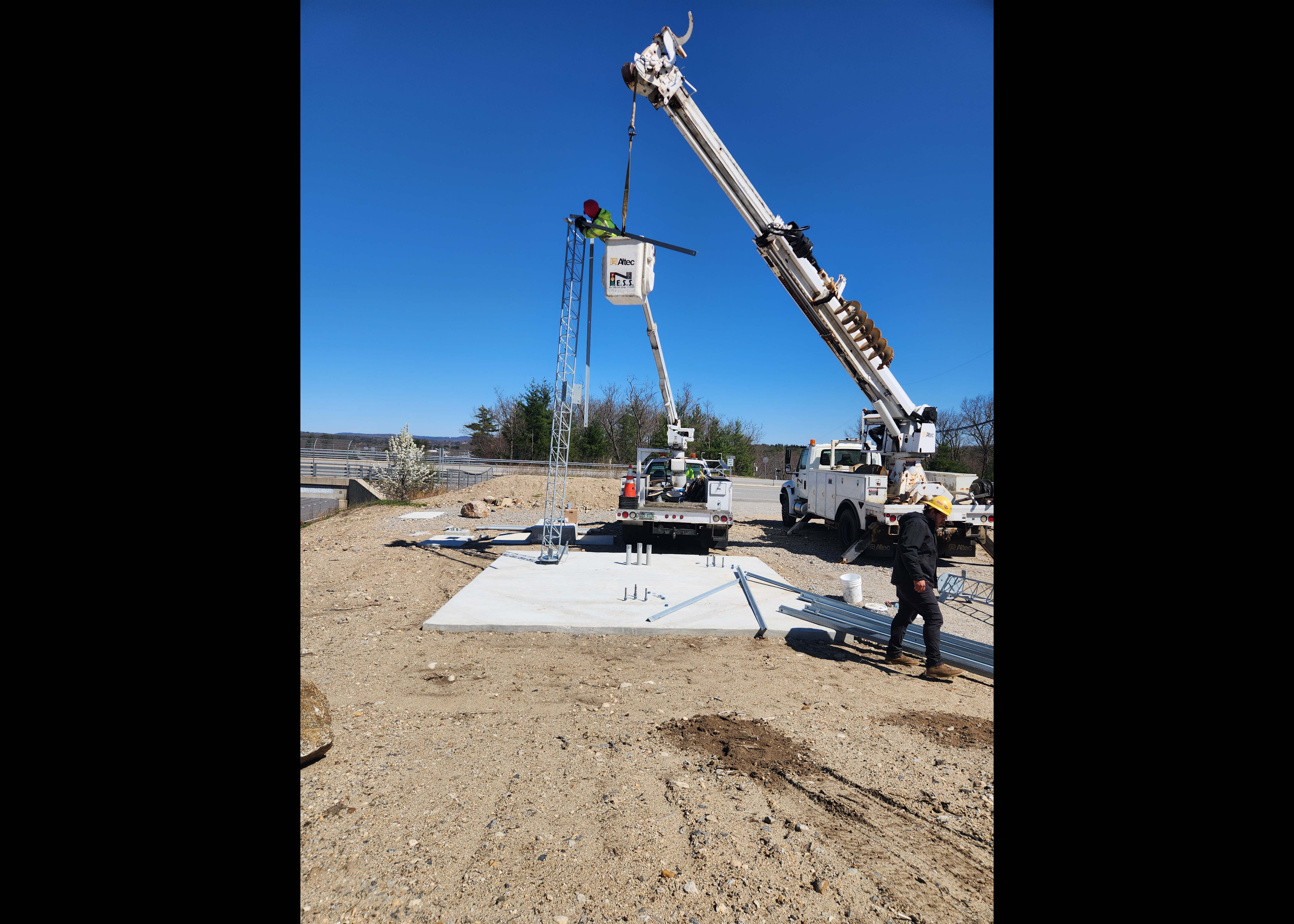

Mounting Equipment on NB ITS Tower – August 2023
Seeded Area Along SB Mainline – August 2023

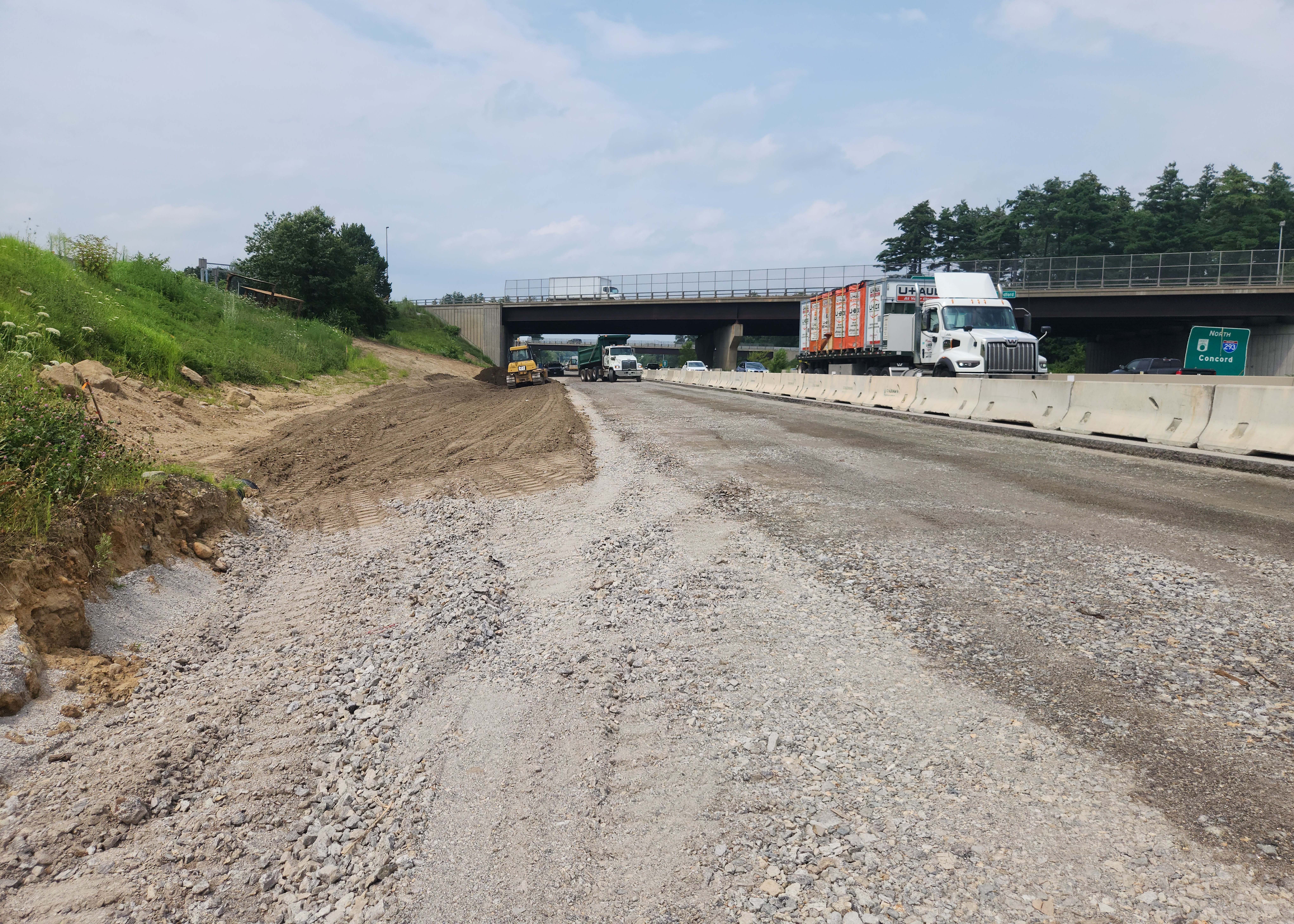

Roadway Select Materials Along SB Mainline – August 2023

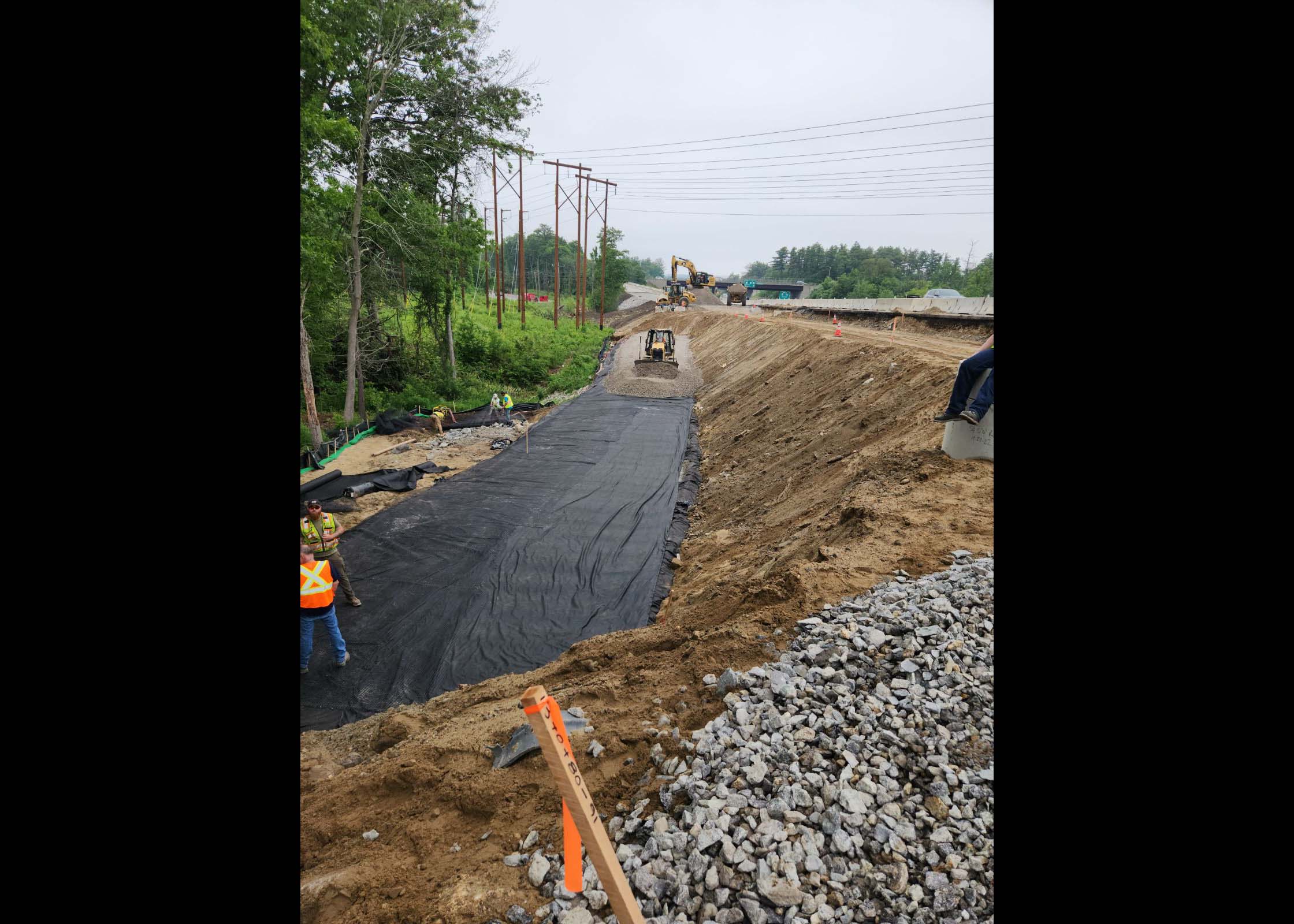

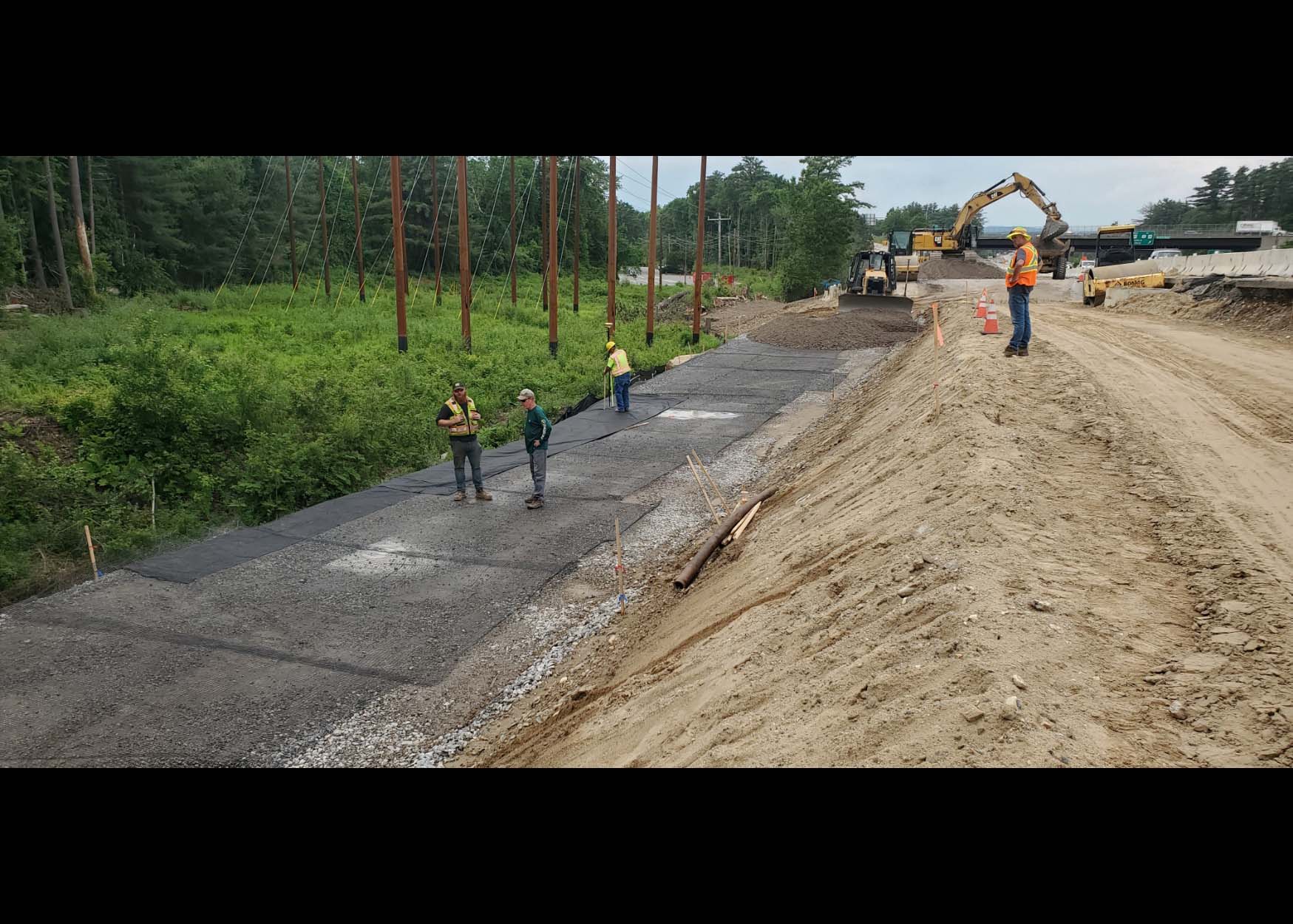

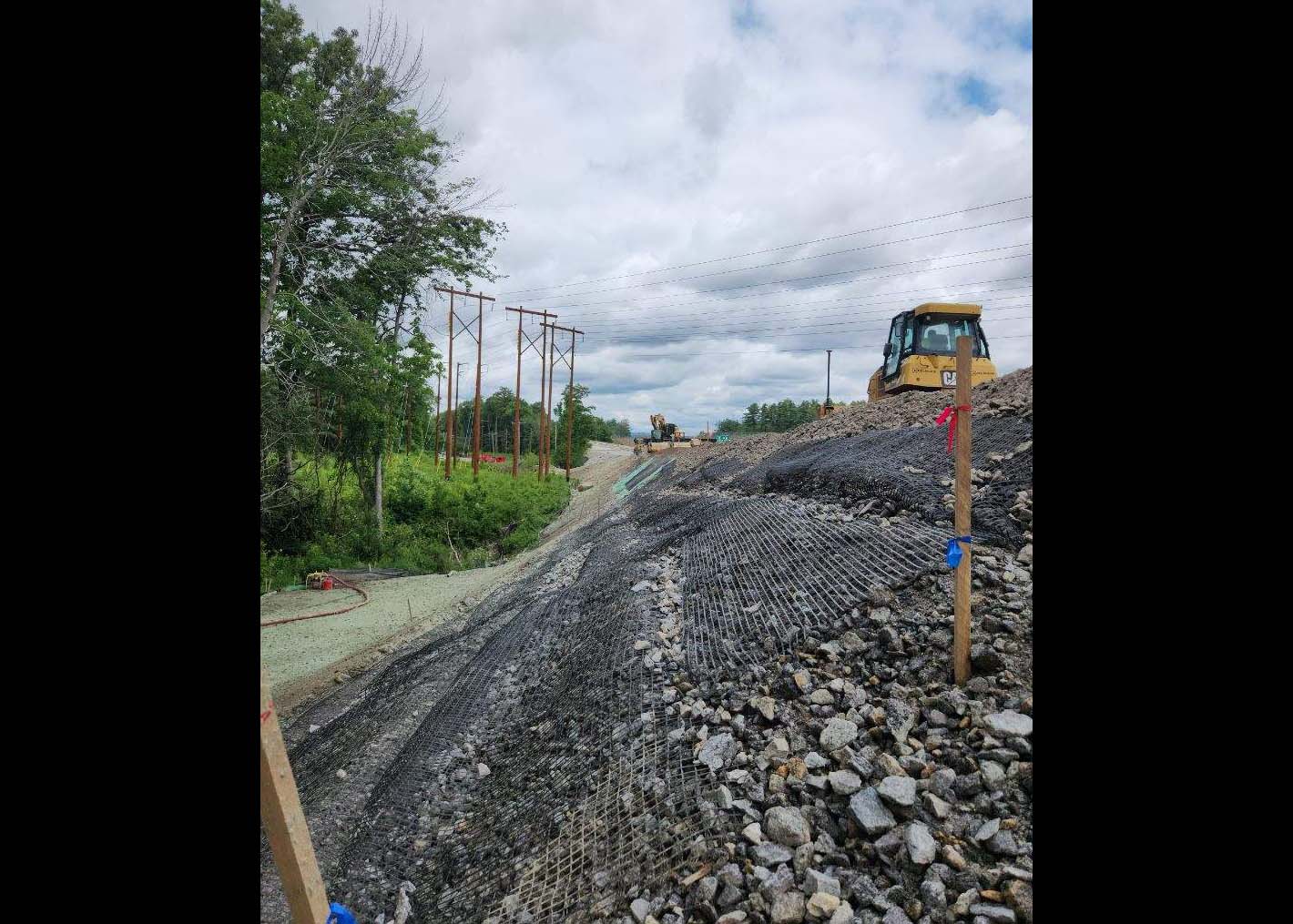

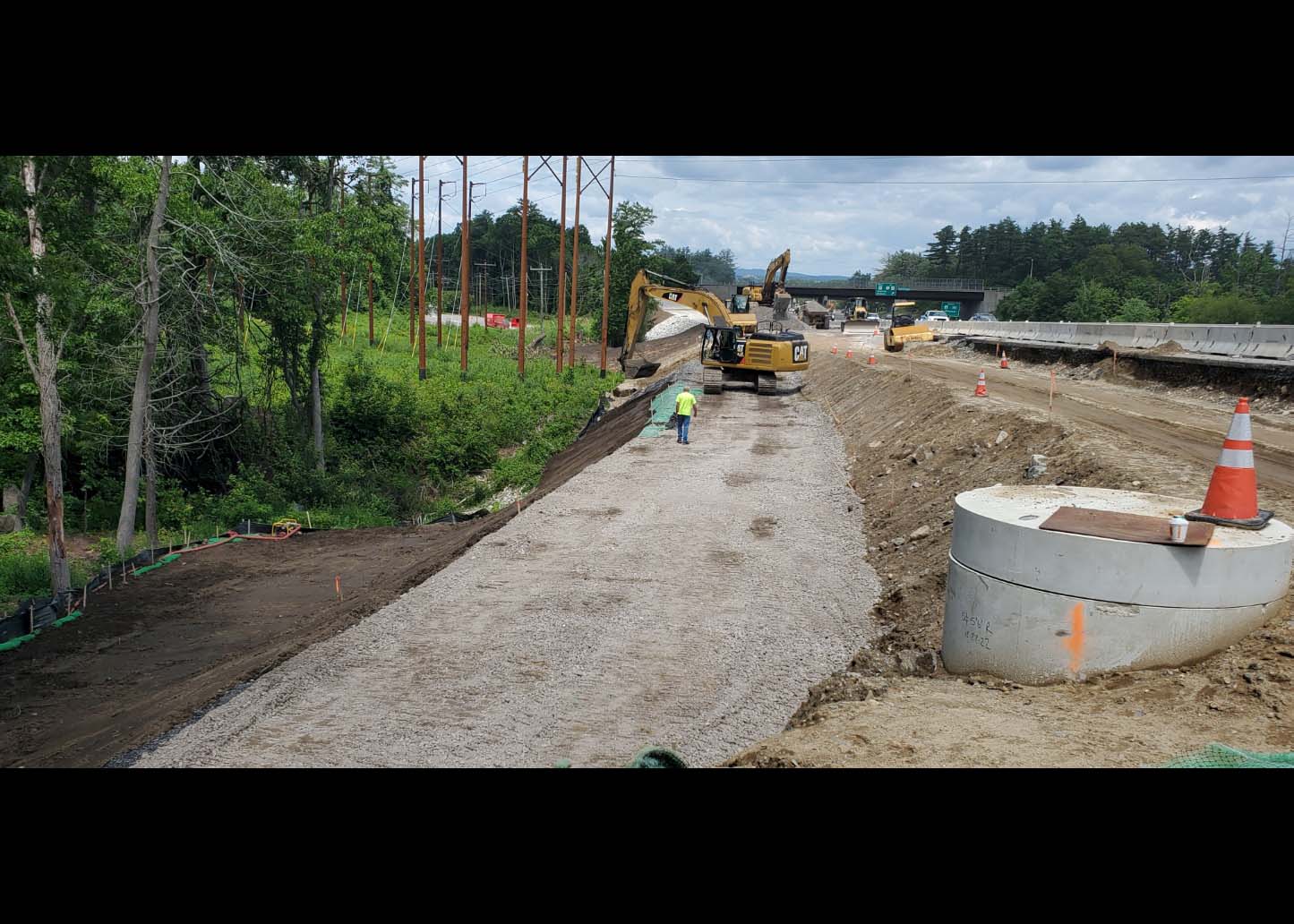

SB Geogrid Installation Work – July 2023
SB Geogrid Installation Work – July 2023
SB Geogrid Installation Work – July 2023
SB Geogrid Installation Work – July 2023

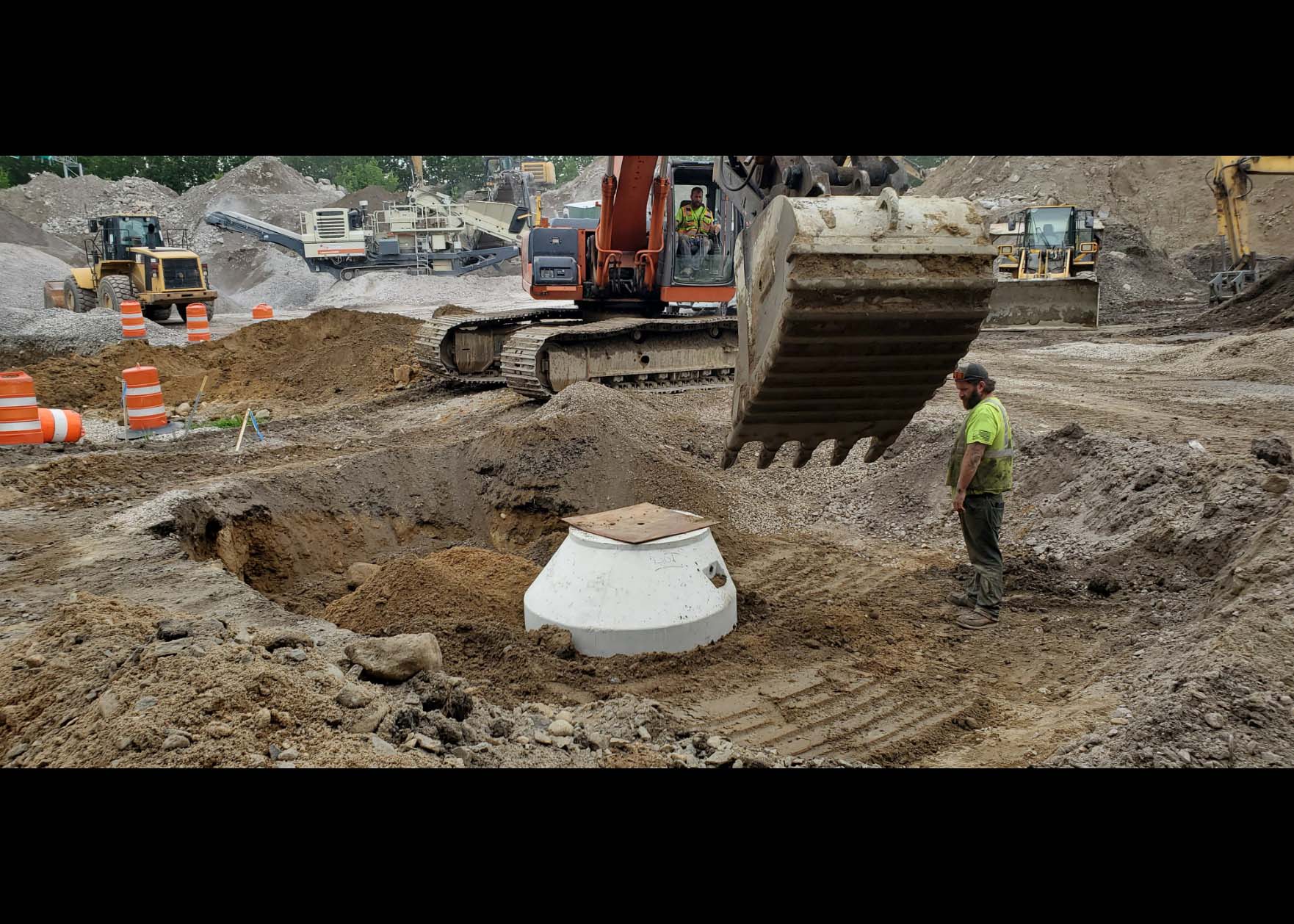

SB Drainage Work – July 2023

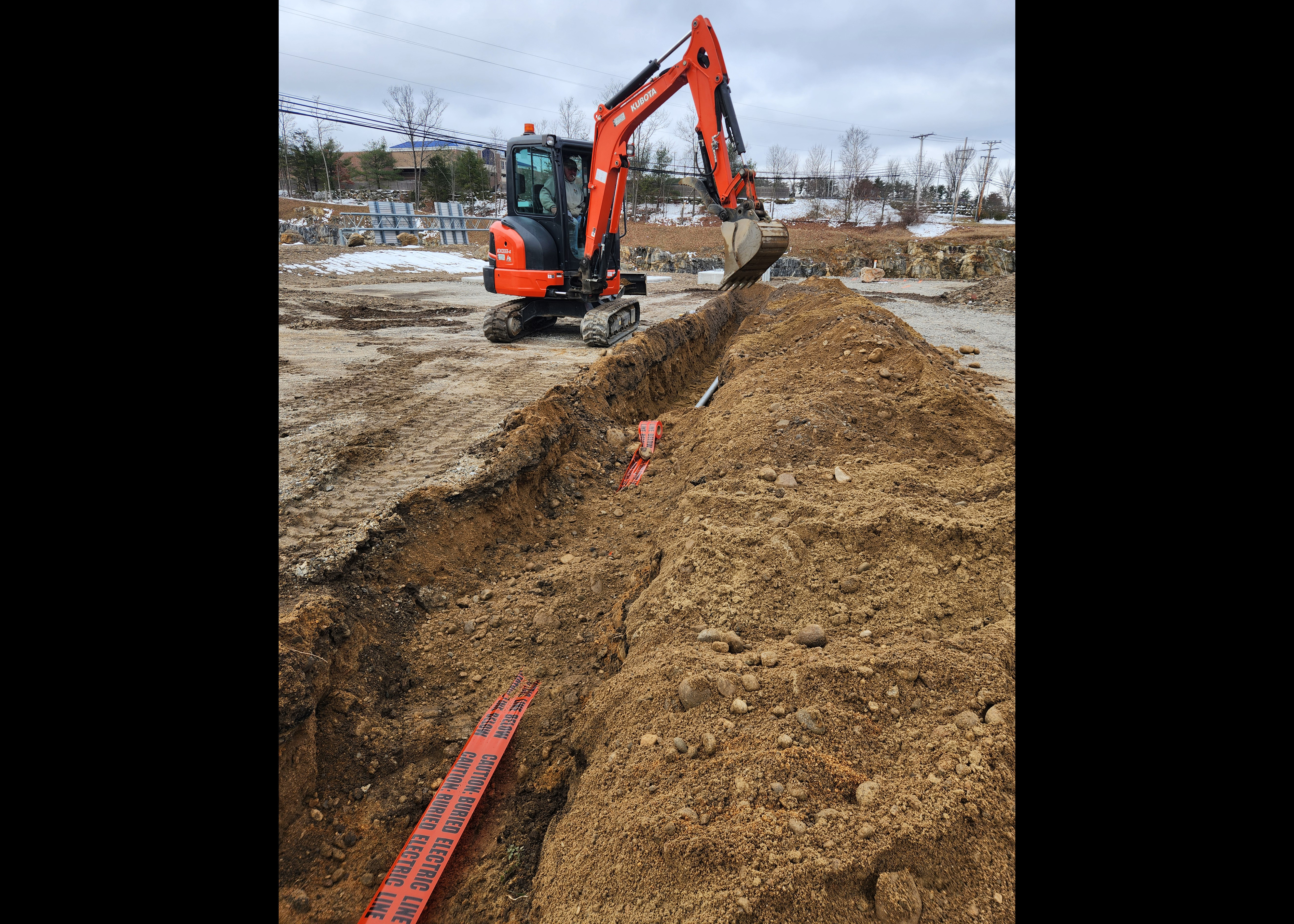

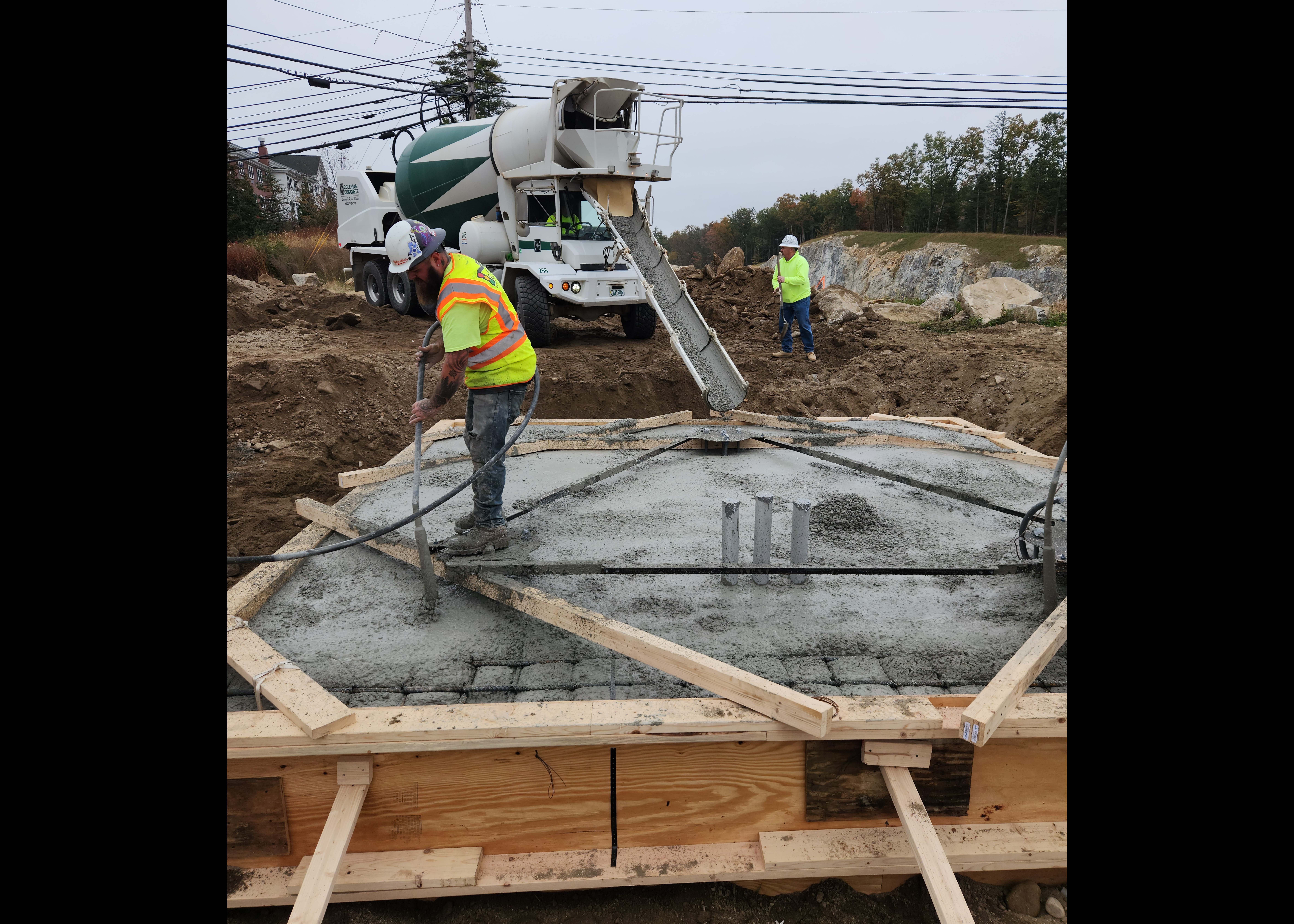

Construction of Foundation for NB ITS Tower – July 2023

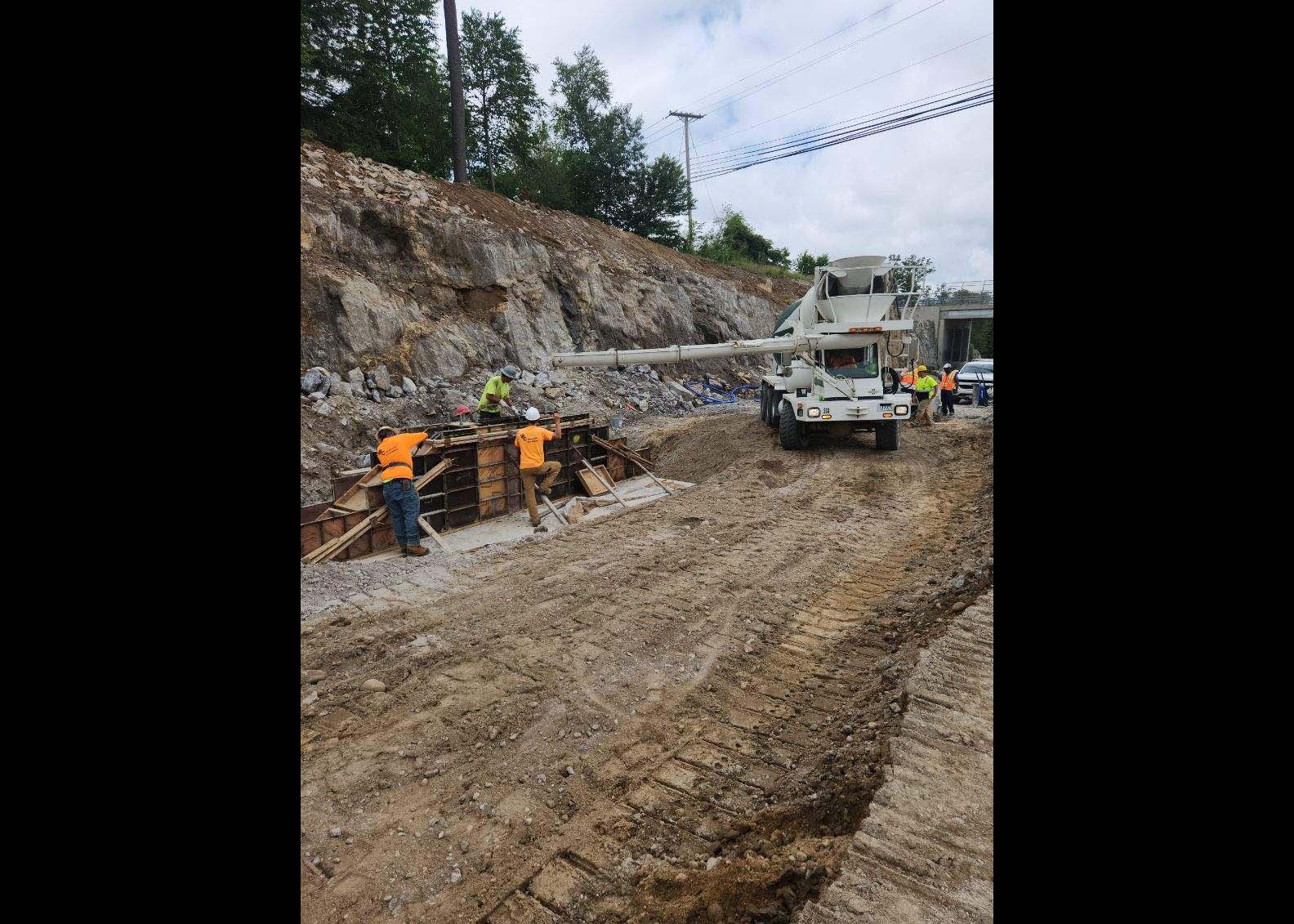

Construction of Foundation for SB Overhead Sign Structure – July 2023

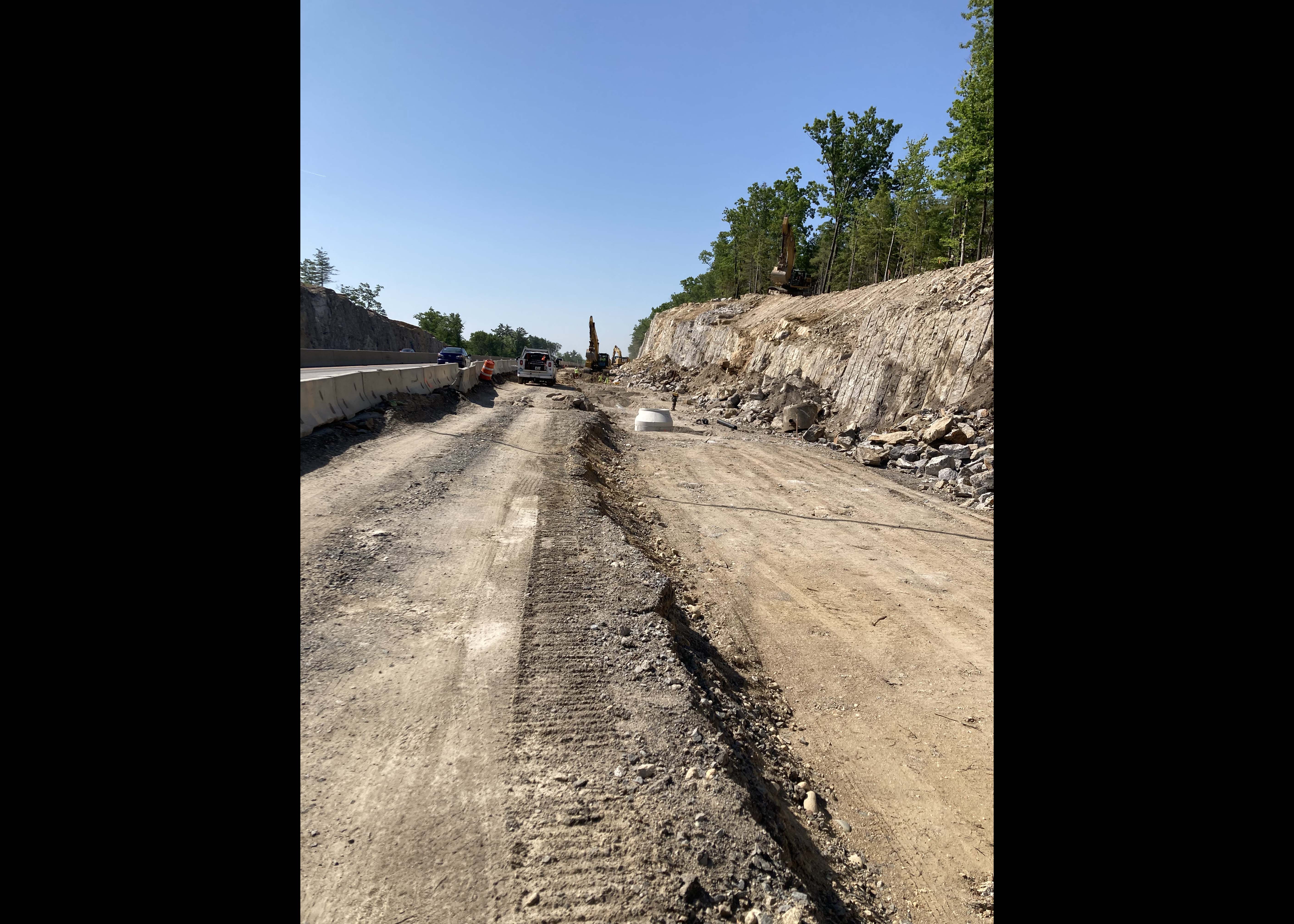

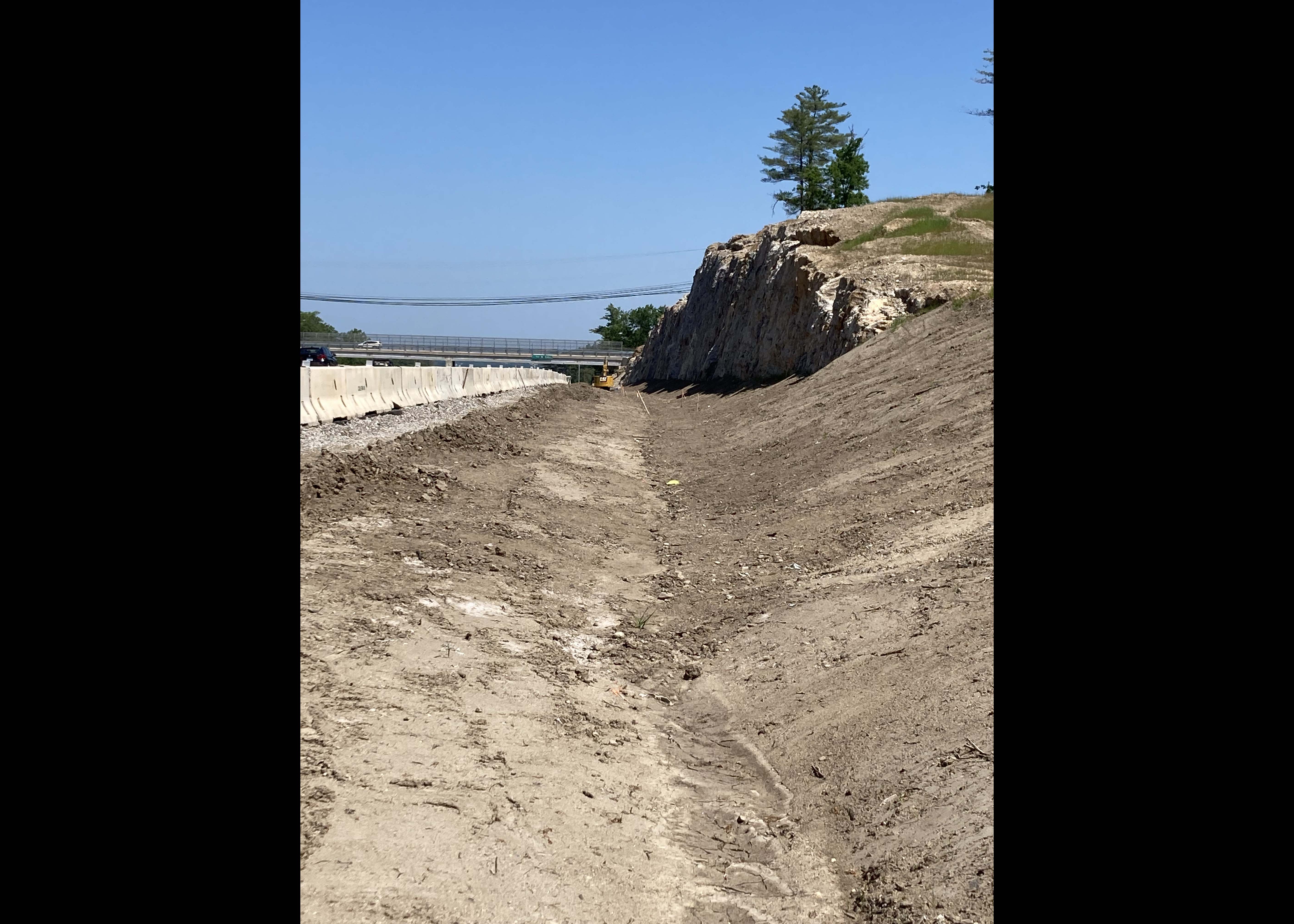

Finished NB Ledge Work – June 2023

Pavement Patch Work – June 2023

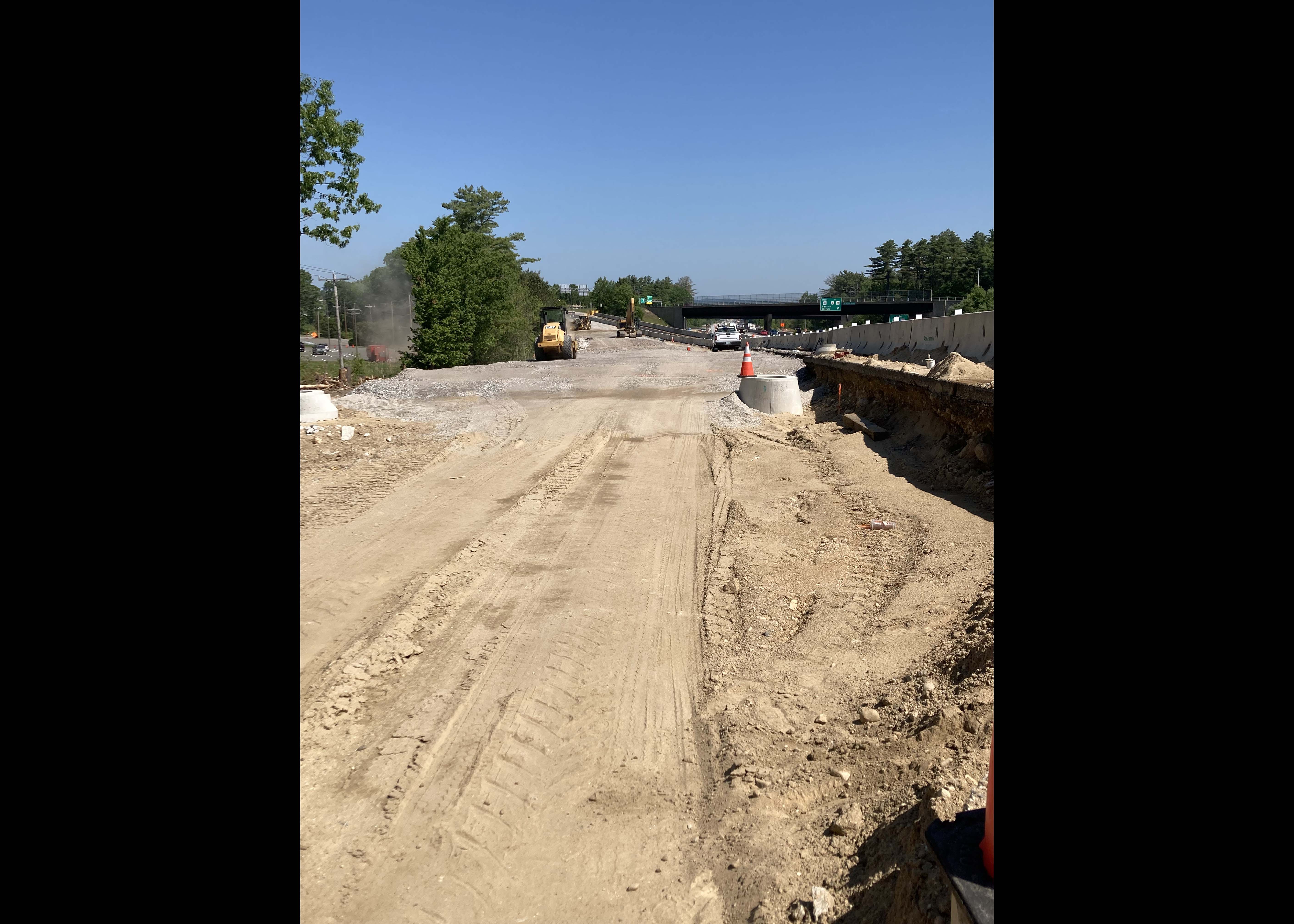

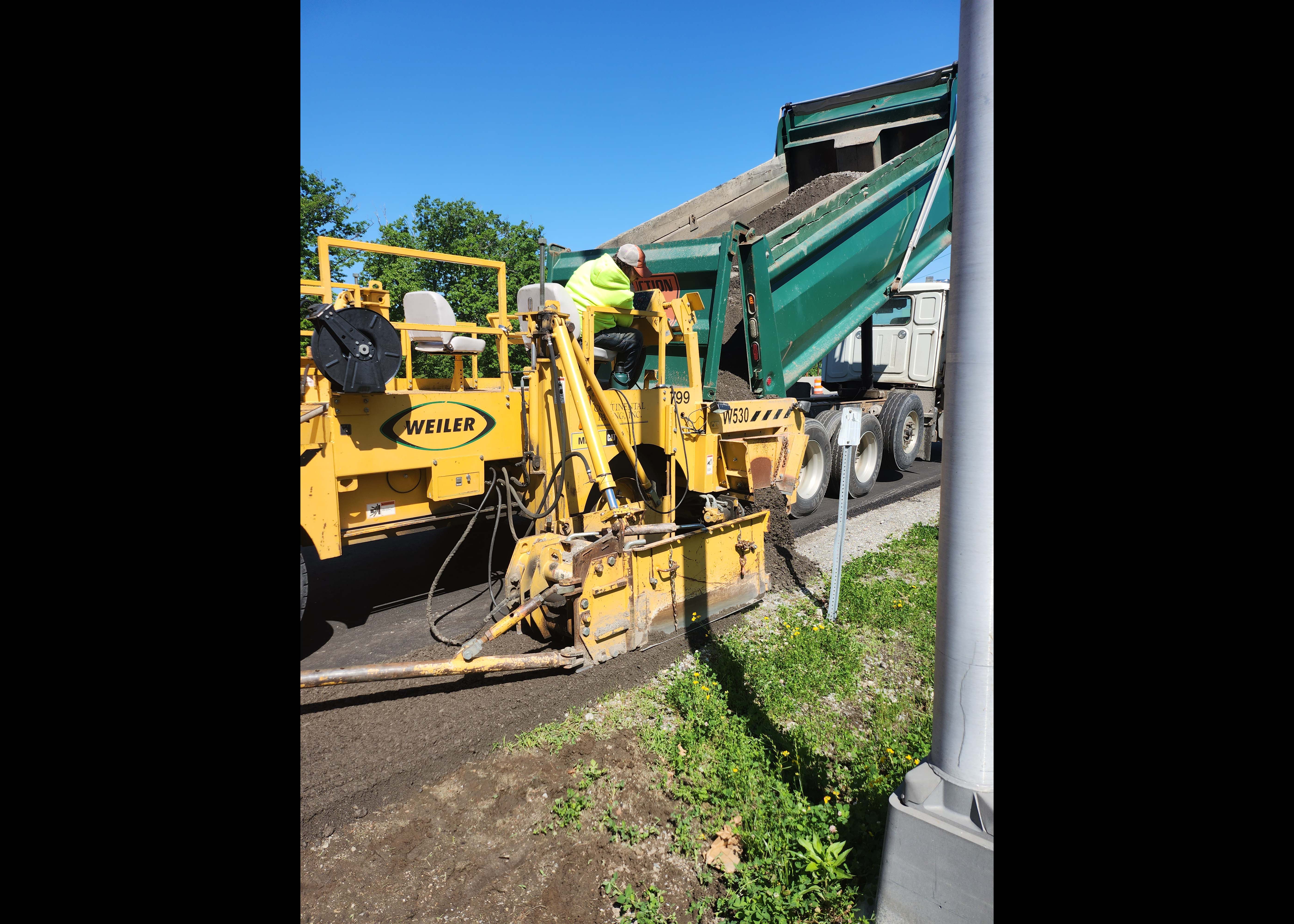

Placing Roadway Select Materials Along NH 101 EB On-Ramp – June 2023

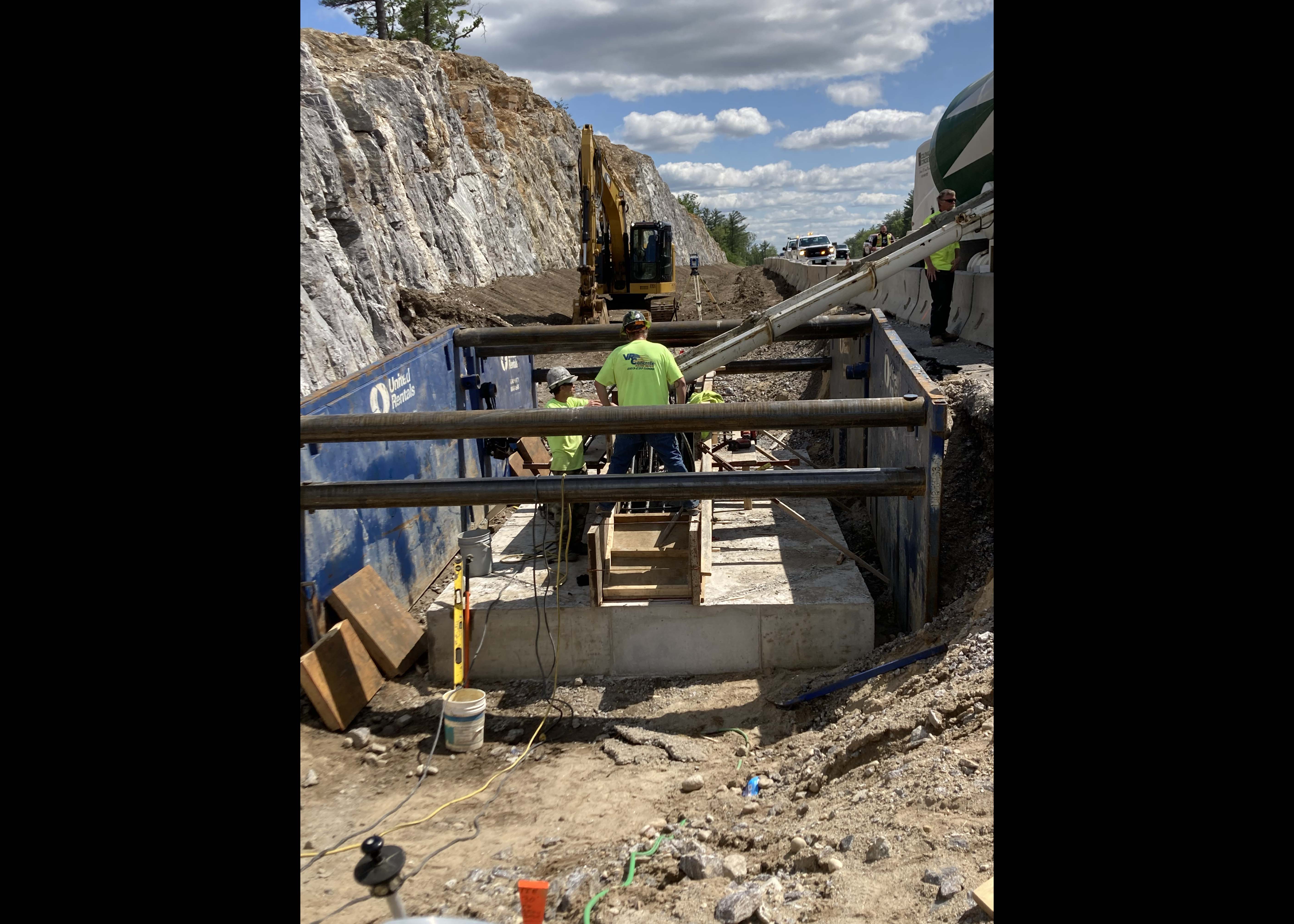

Constructing NB Overhead Sign Structure Foundation – June 2023
SB Ledge Excavation and Drainage Work – June 2023

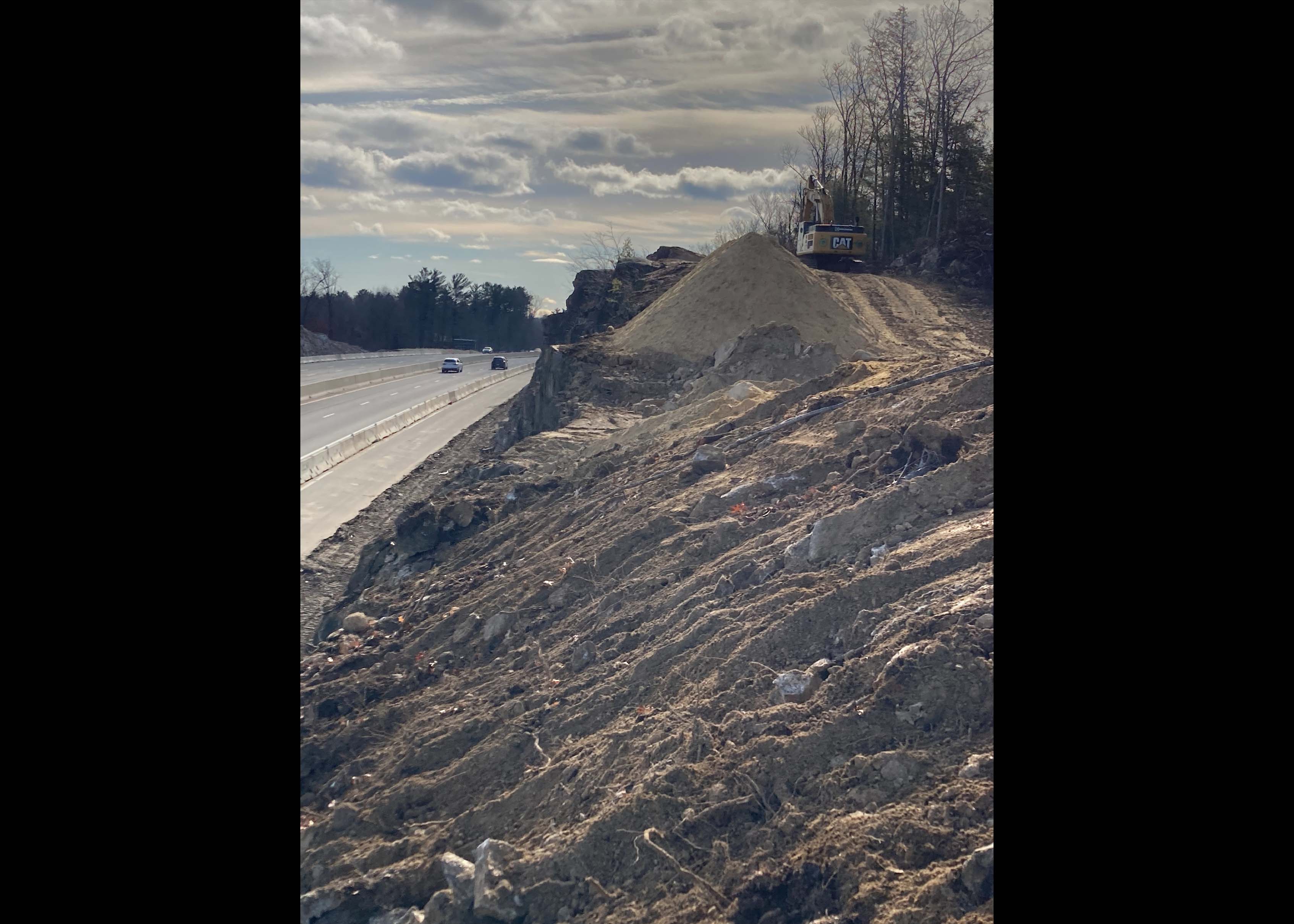

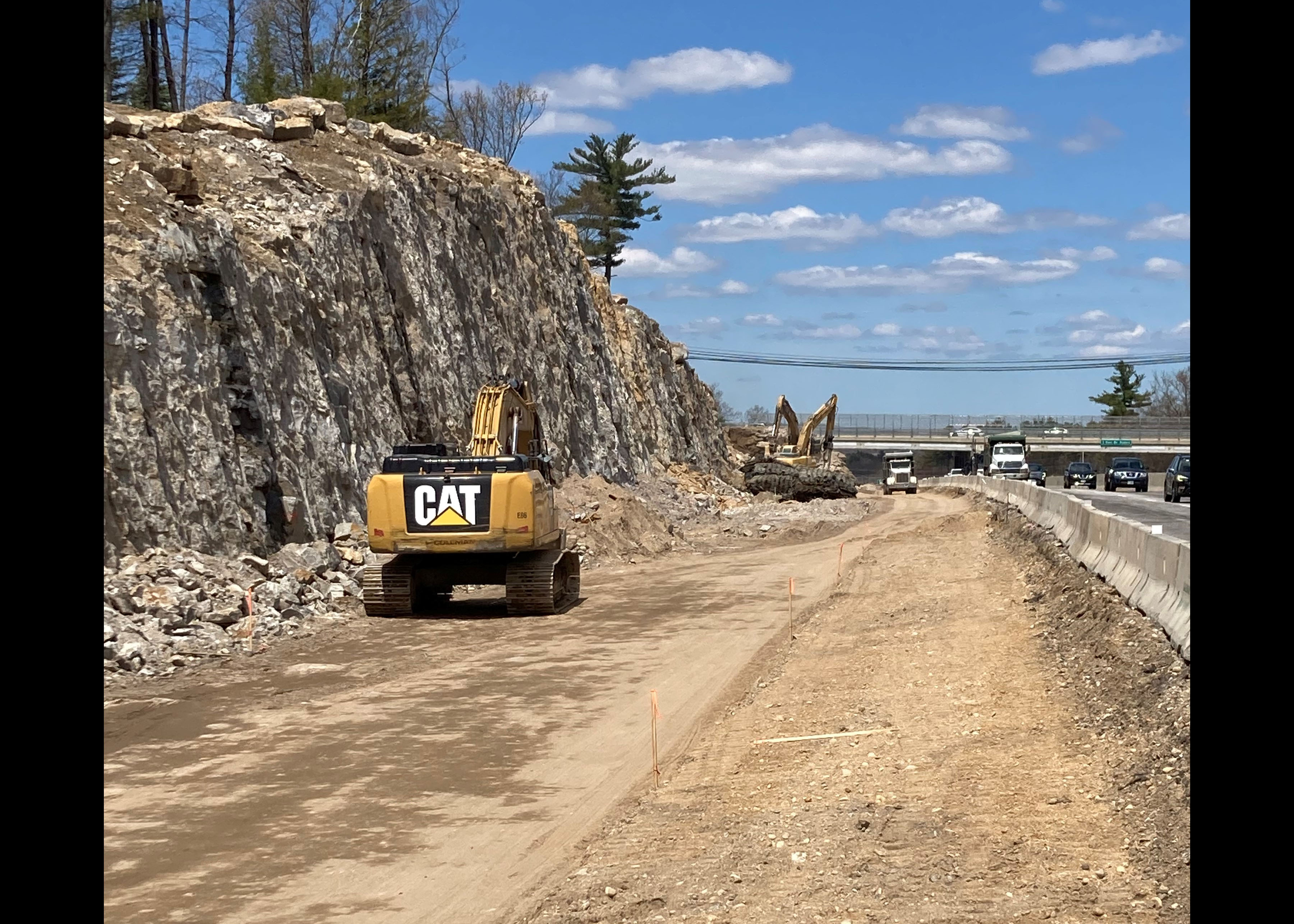

SB Ledge Excavation Work – May 2023

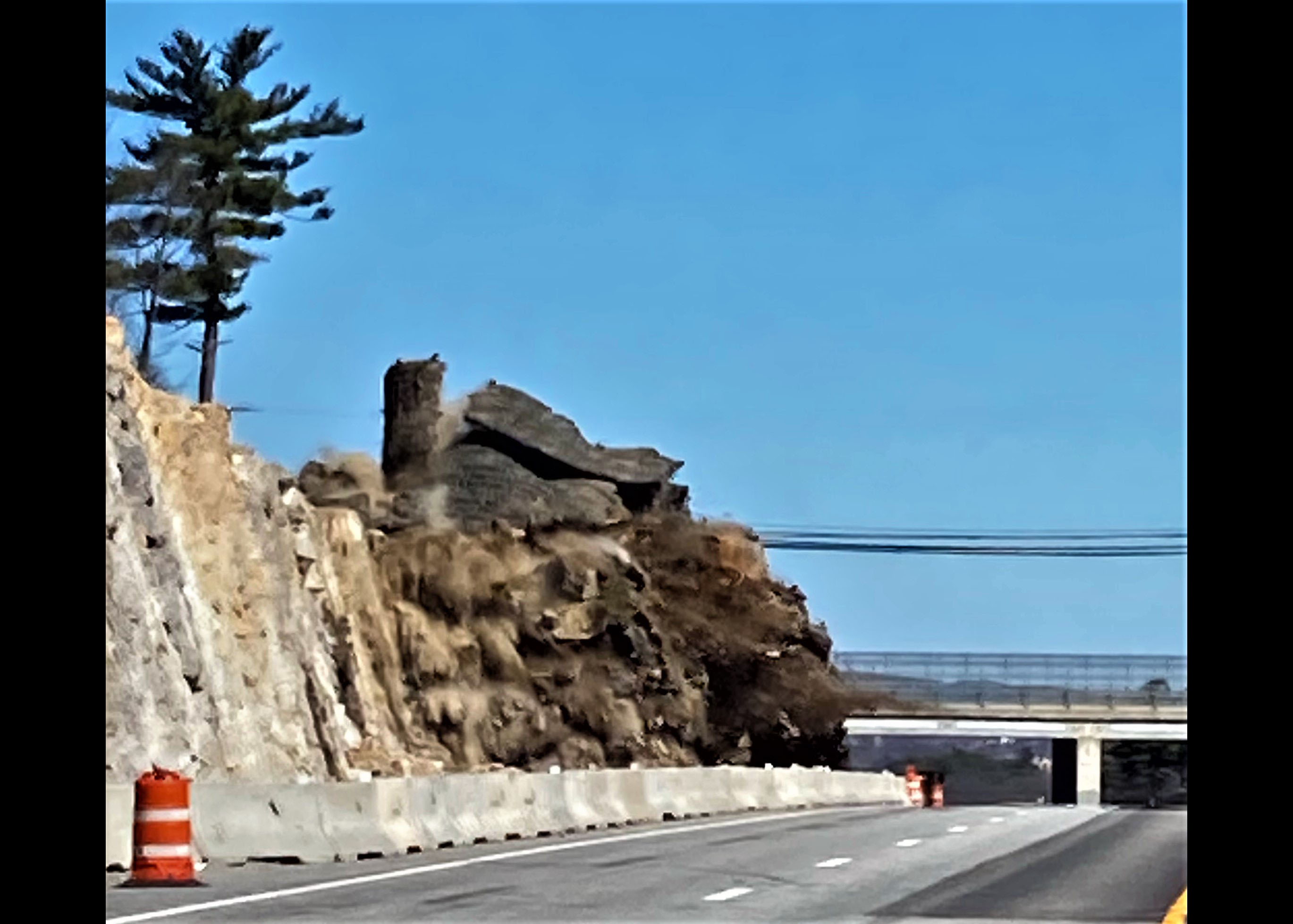

SB Blasting Operations – May 2023

Temporary NH 101 EB On-Ramp – May 2023
SB Drainage Work – May 2023
SB Ledge Excavation Work – May 2023

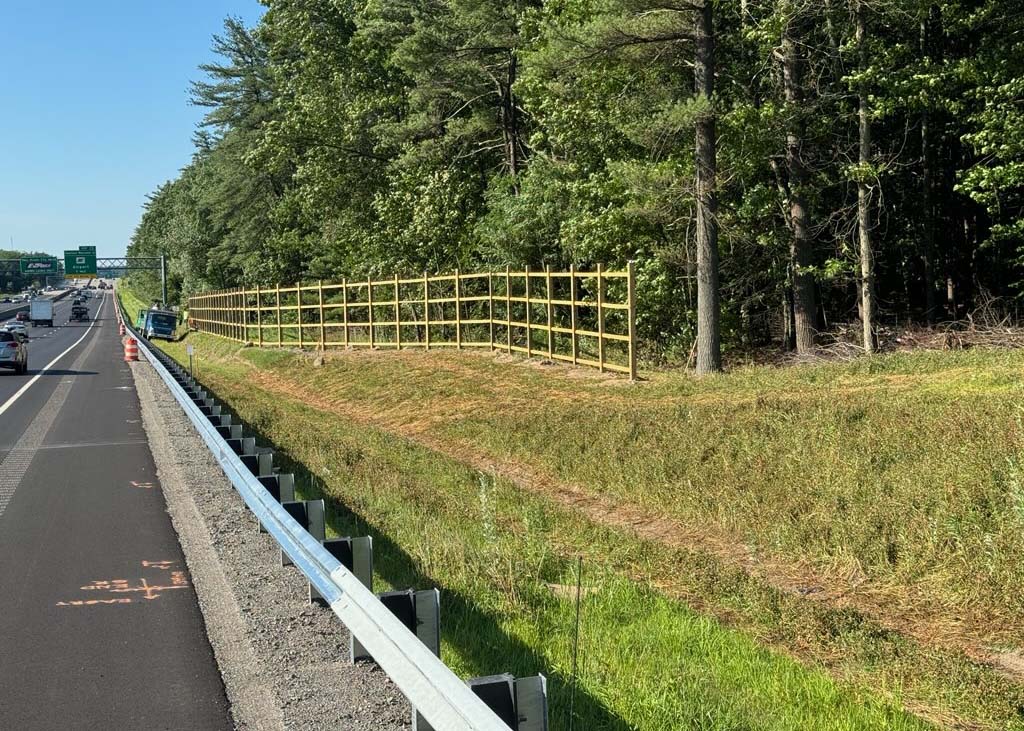

Right-of-Way Fence Along NB Mainline – May 2023
Making Roadway Select Materials Adjacent to SB Travel Lanes – April 2023

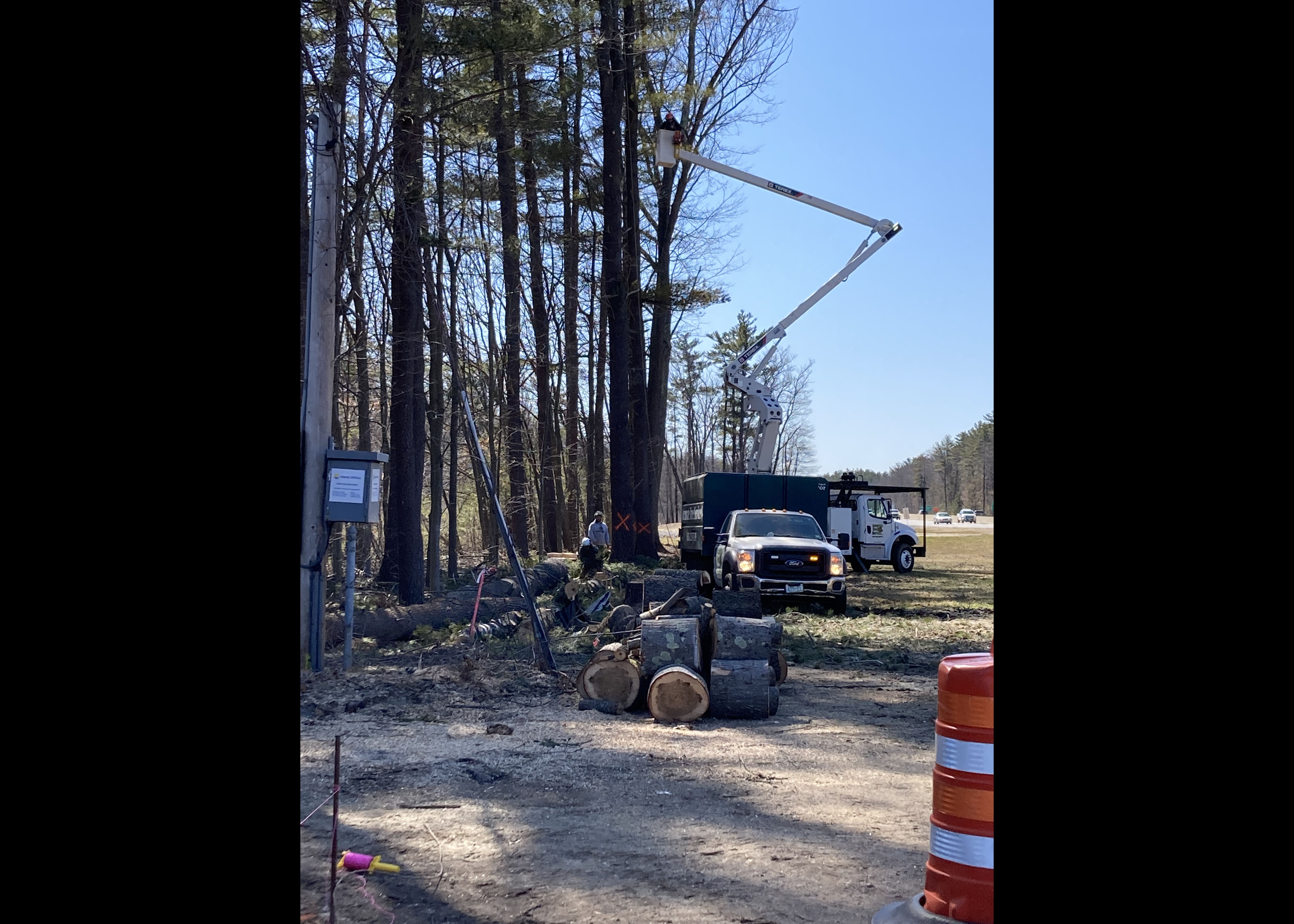

Tree Clearing for Placing Right-of-Way Fence Along NB Mainline – April 2023

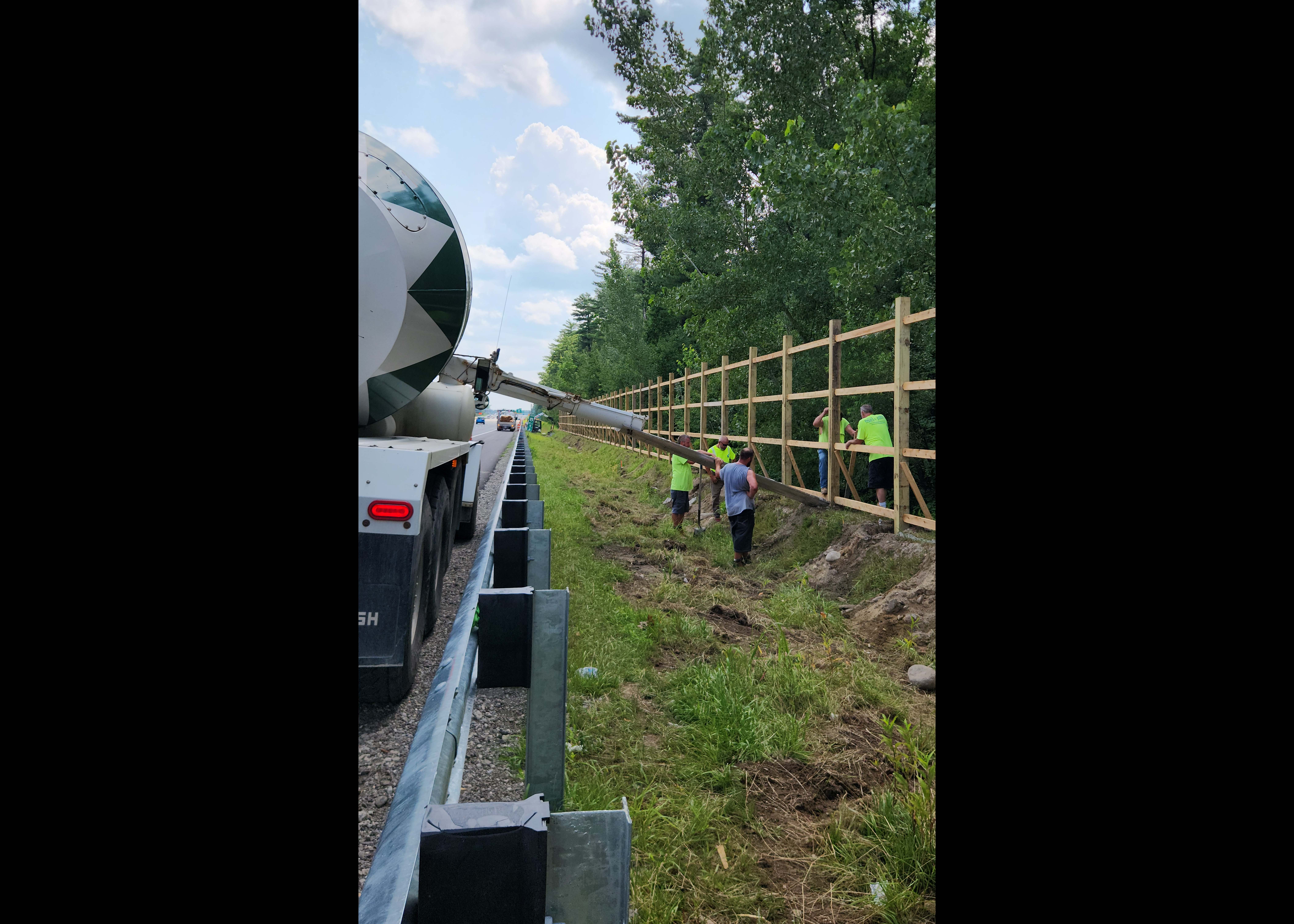

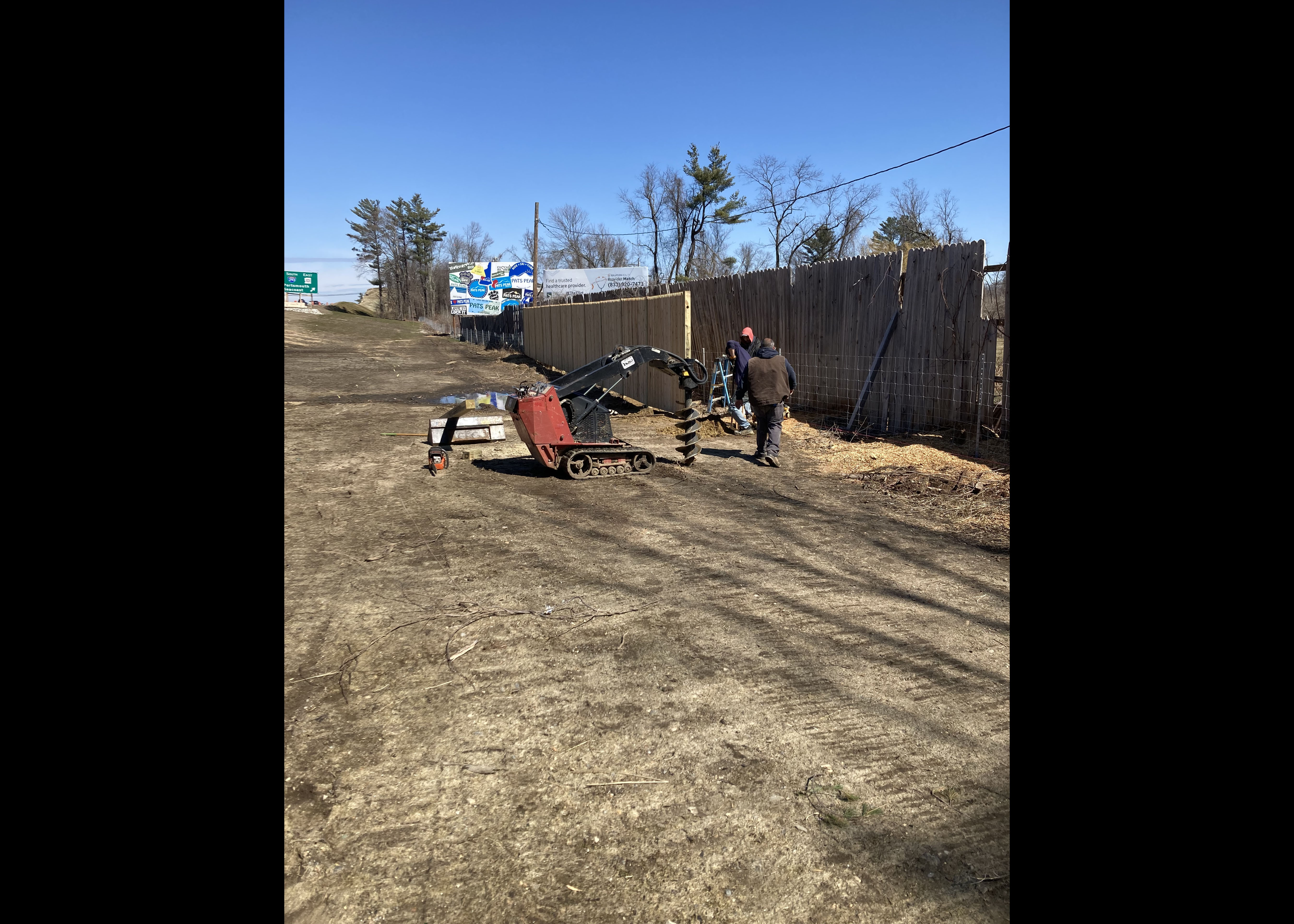

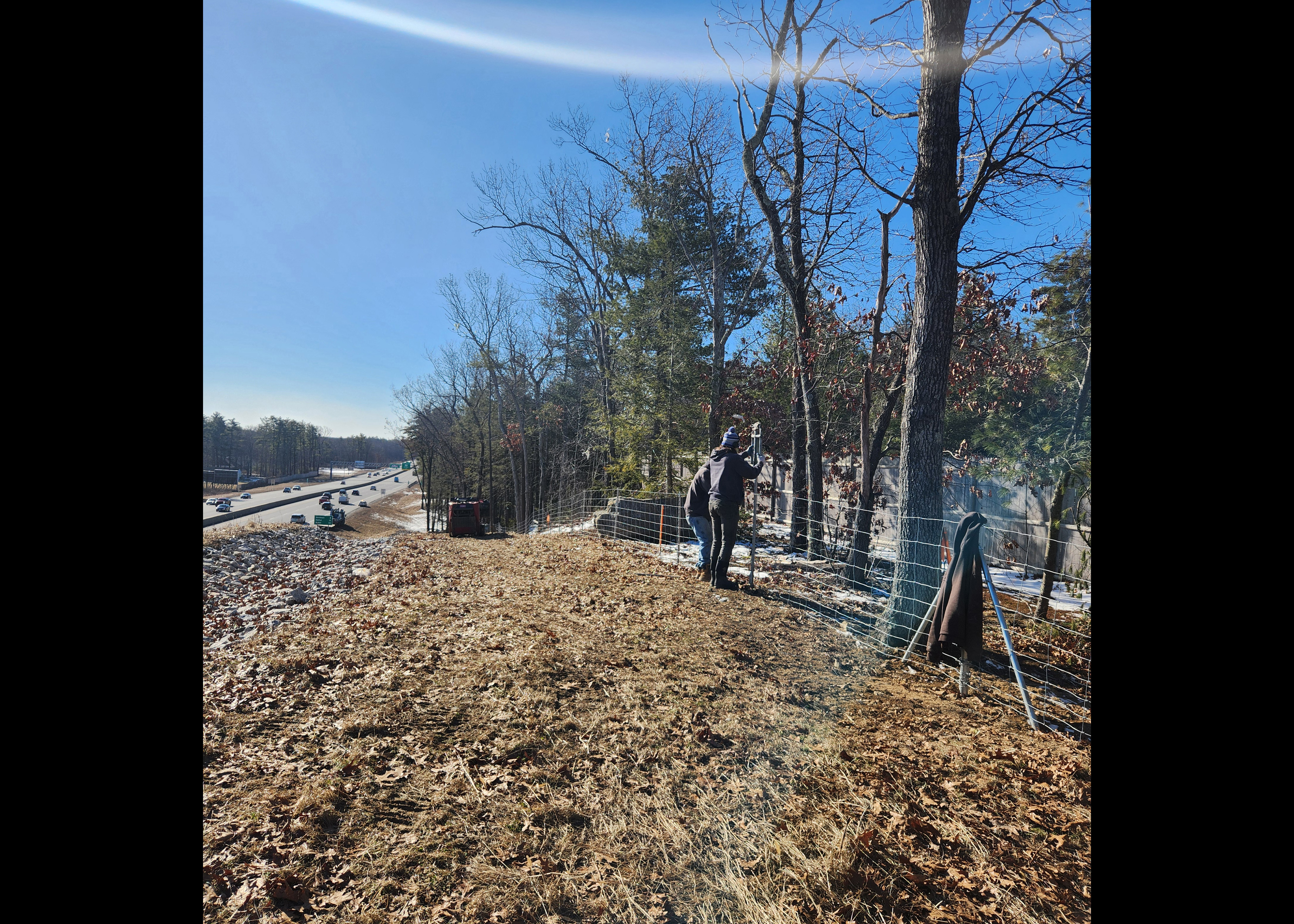

Installing Right-of-Way Fence Along NB Mainline – April 2023

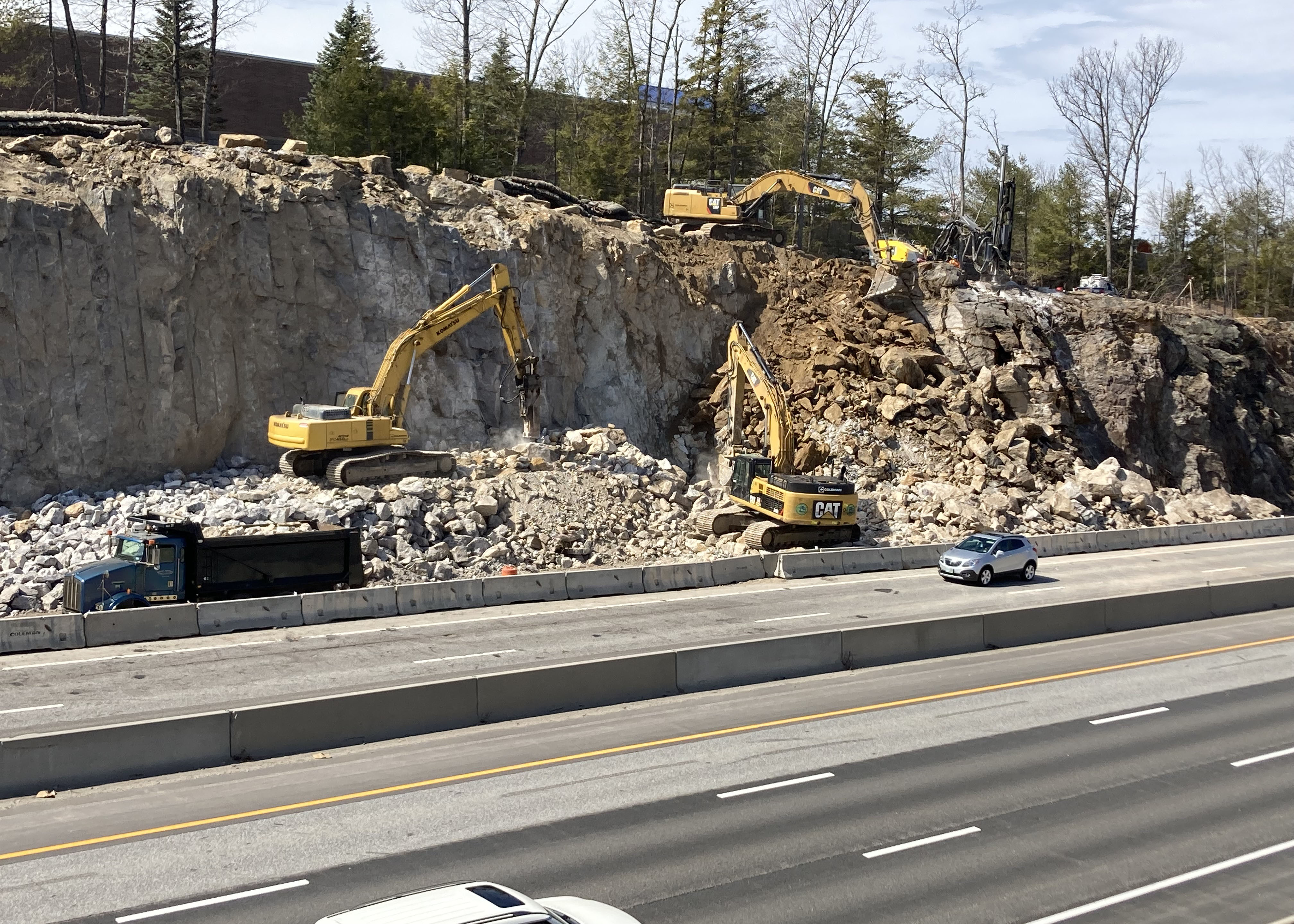

SB Ledge Excavation Work – April 2023

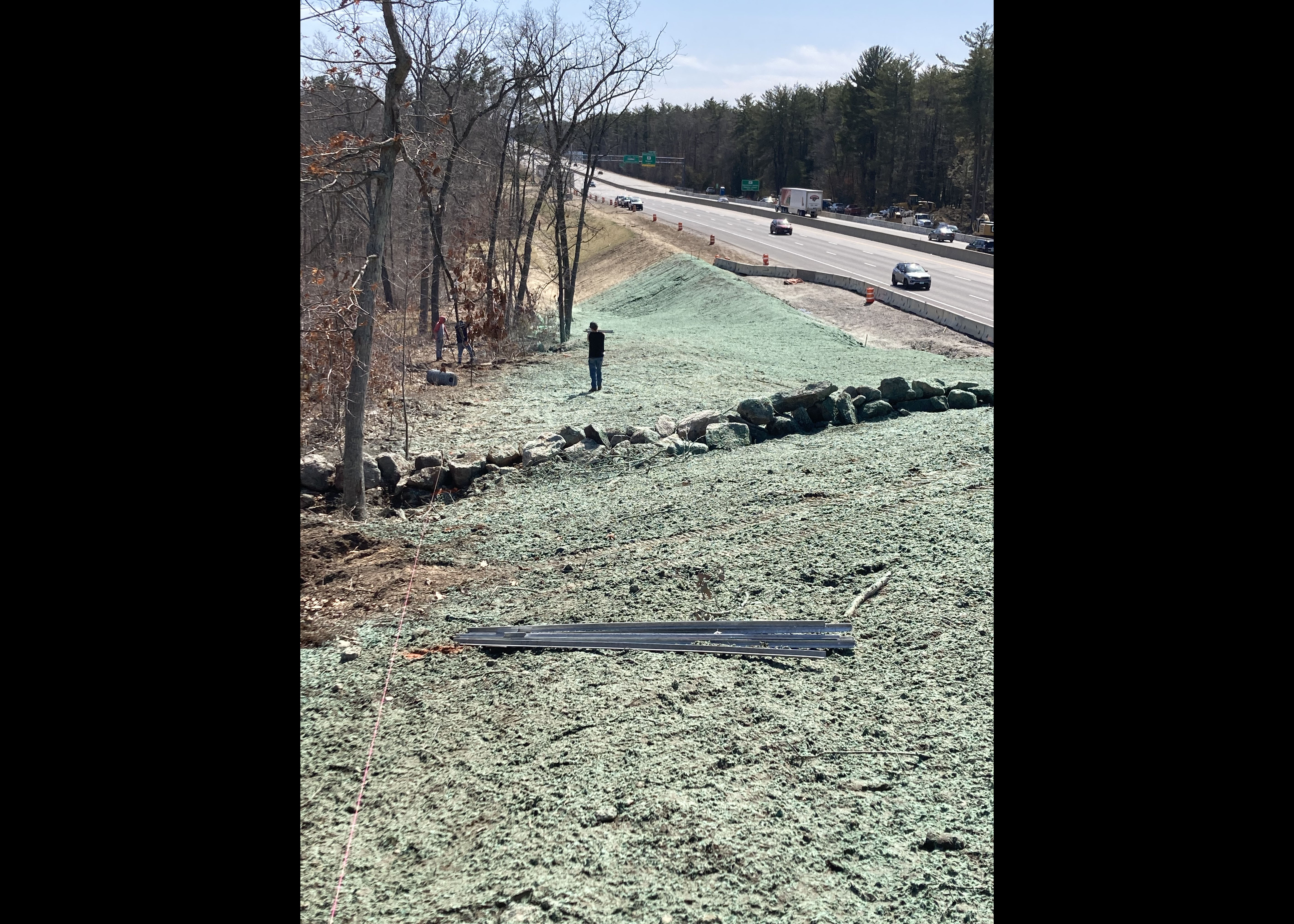

NB Grass Establishment – April 2023

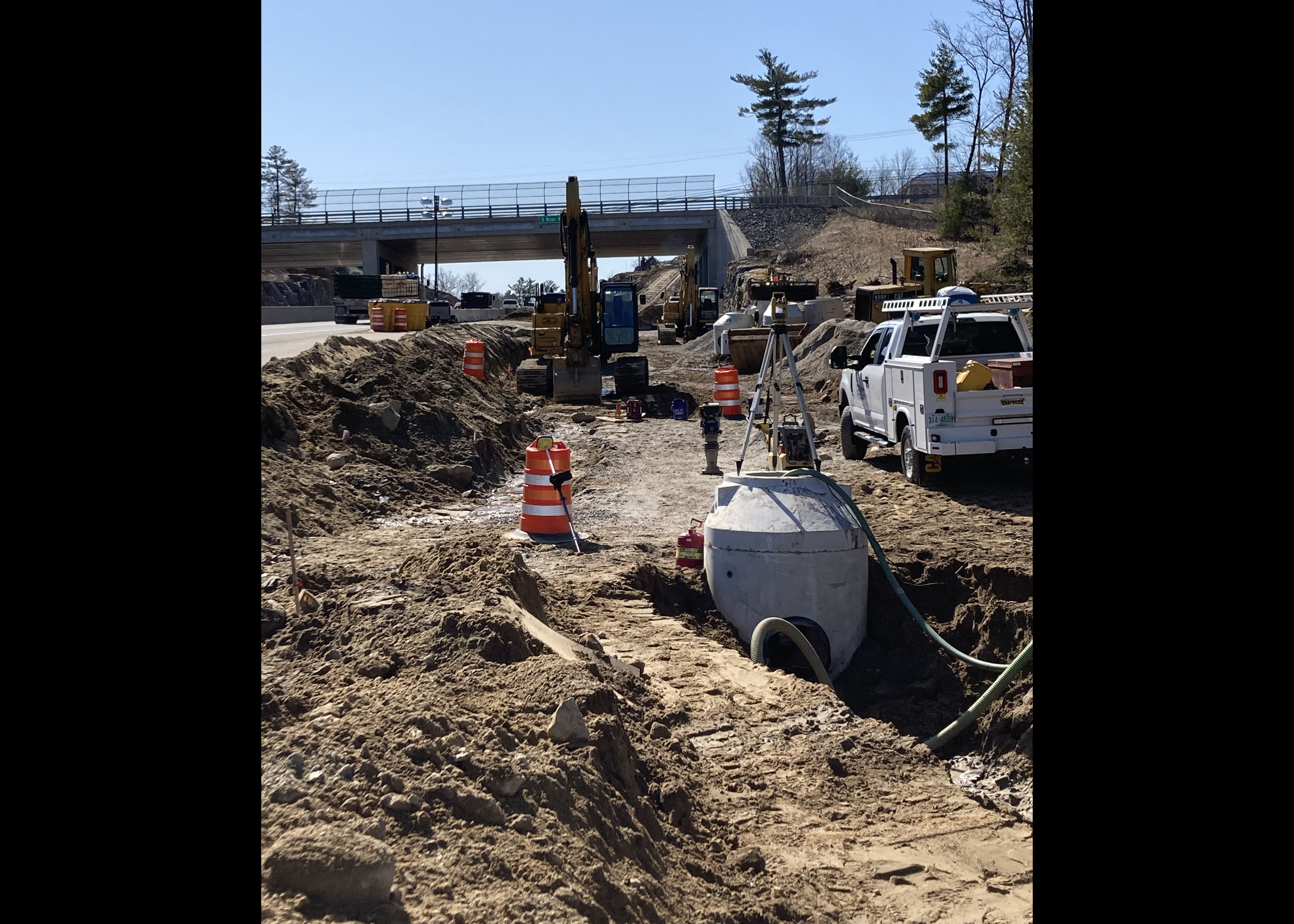

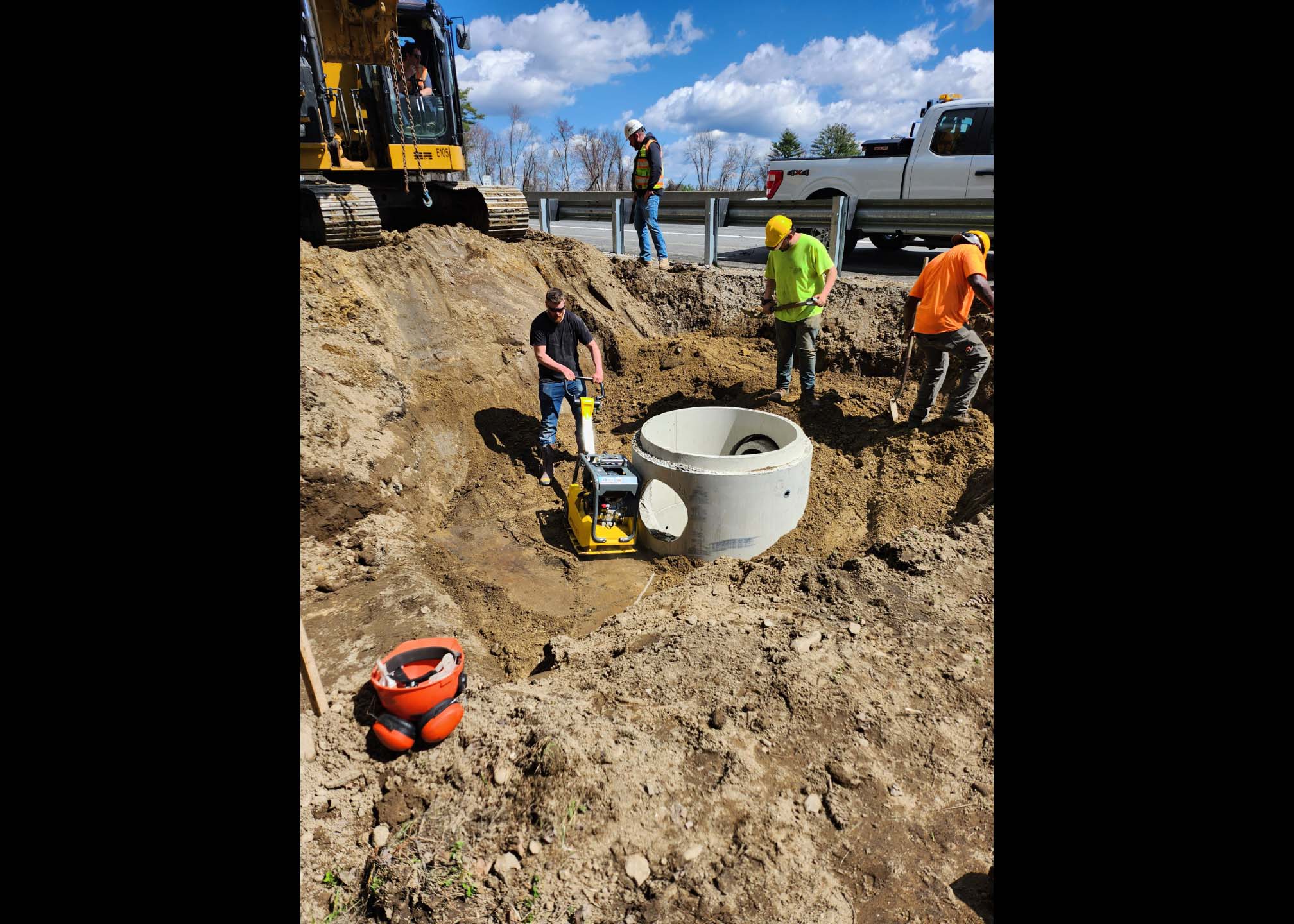

SB Drainage Work – April 2023

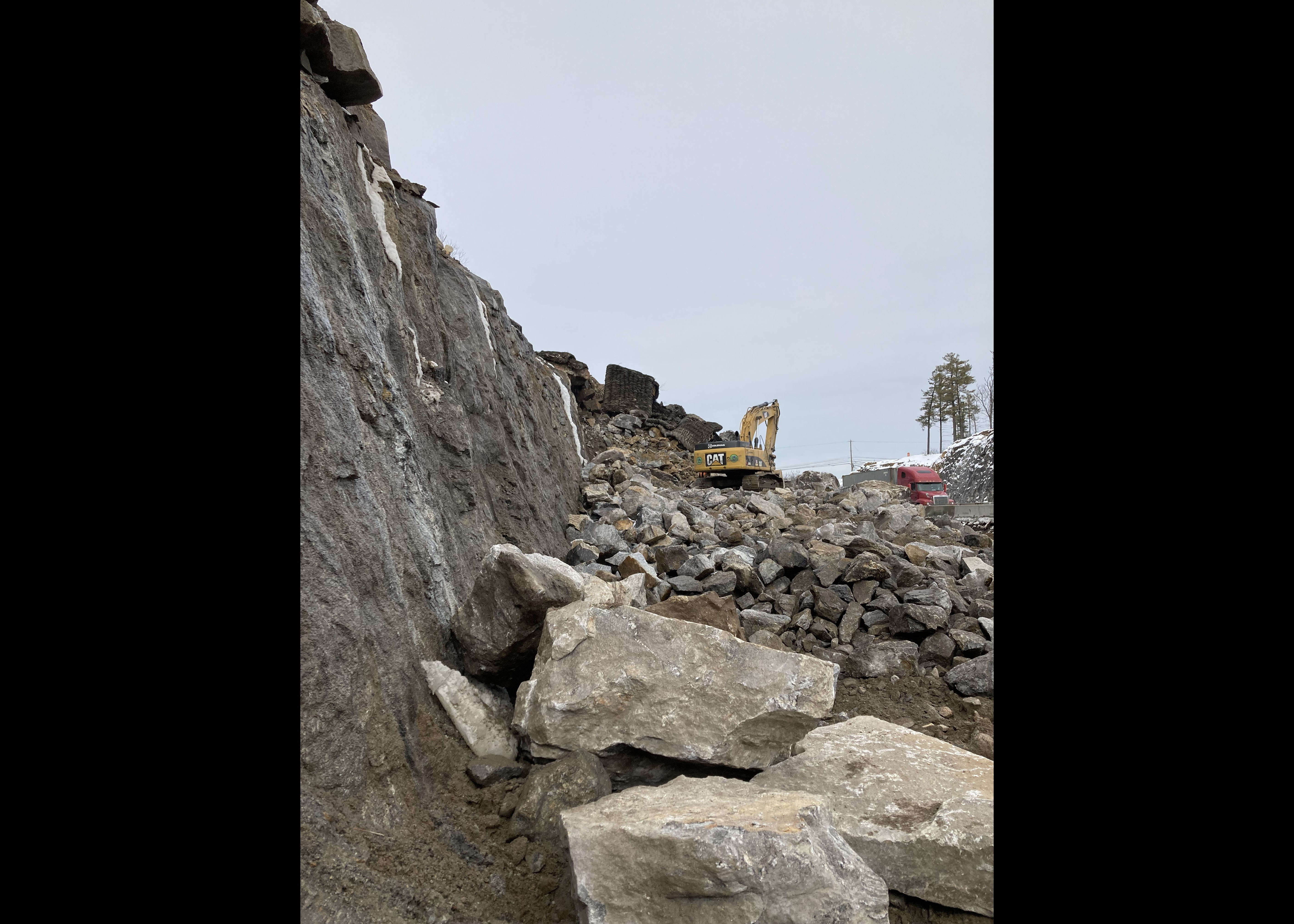

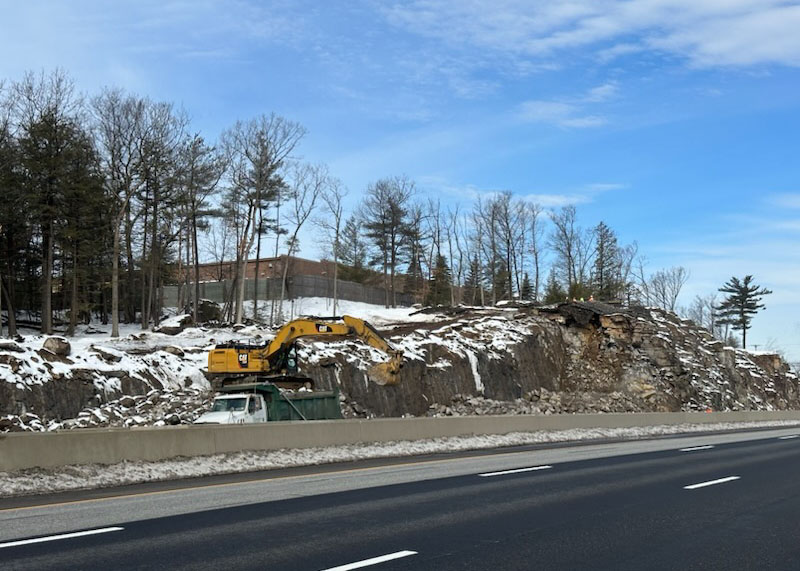

SB Ledge Excavation Work – March 2023
SB Ledge Excavation Work – March 2023
SB Ledge Excavation Work – March 2023

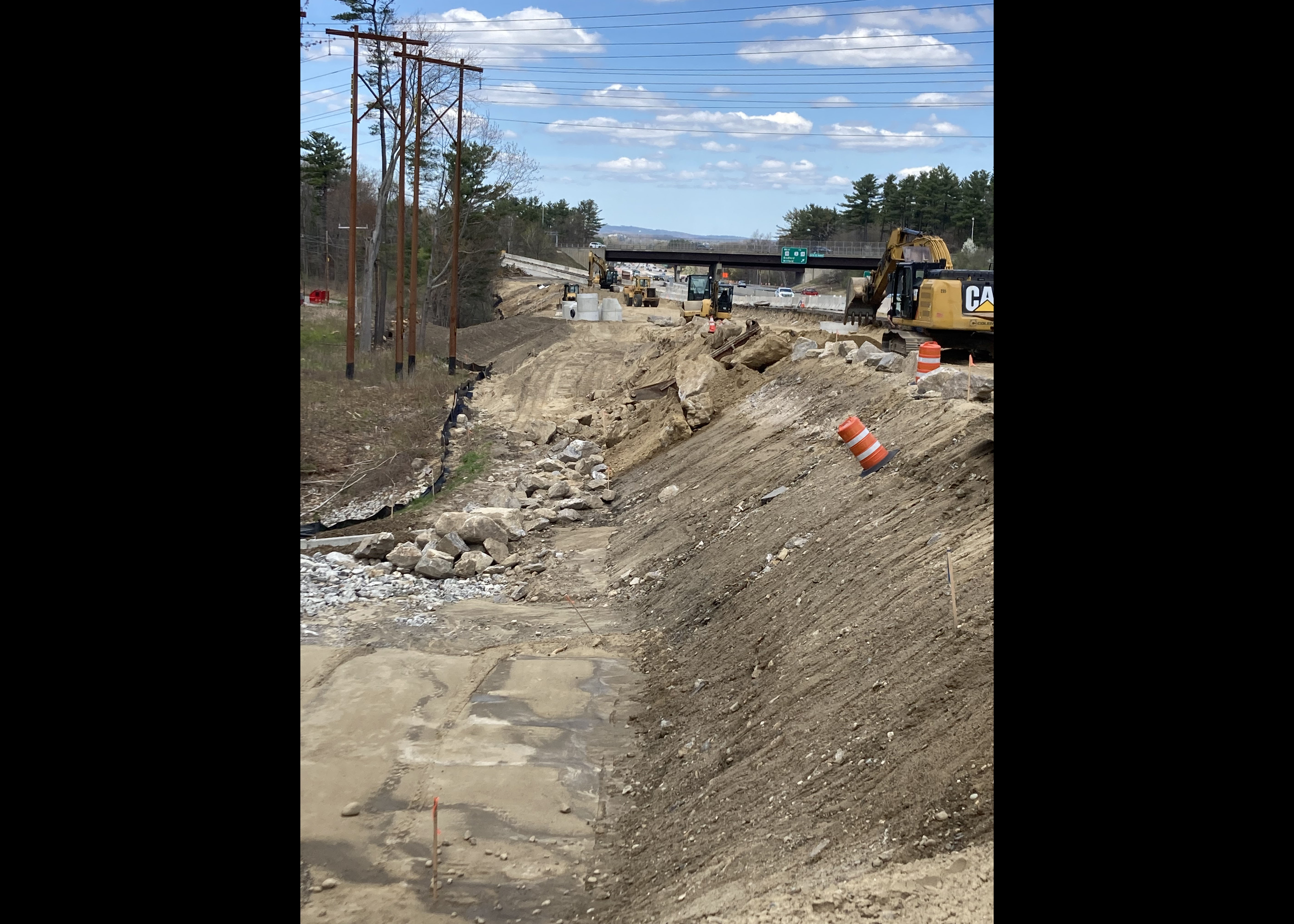

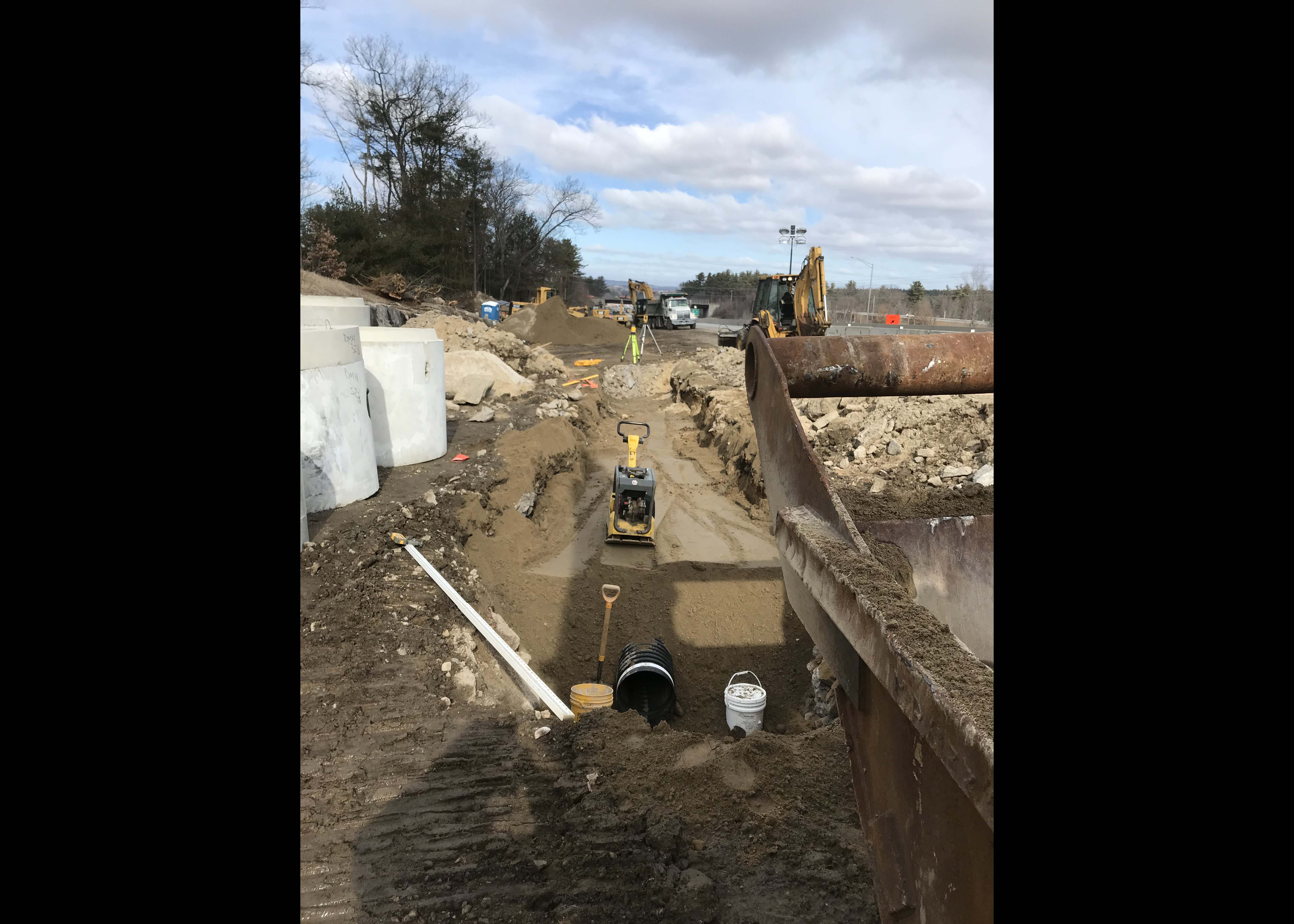

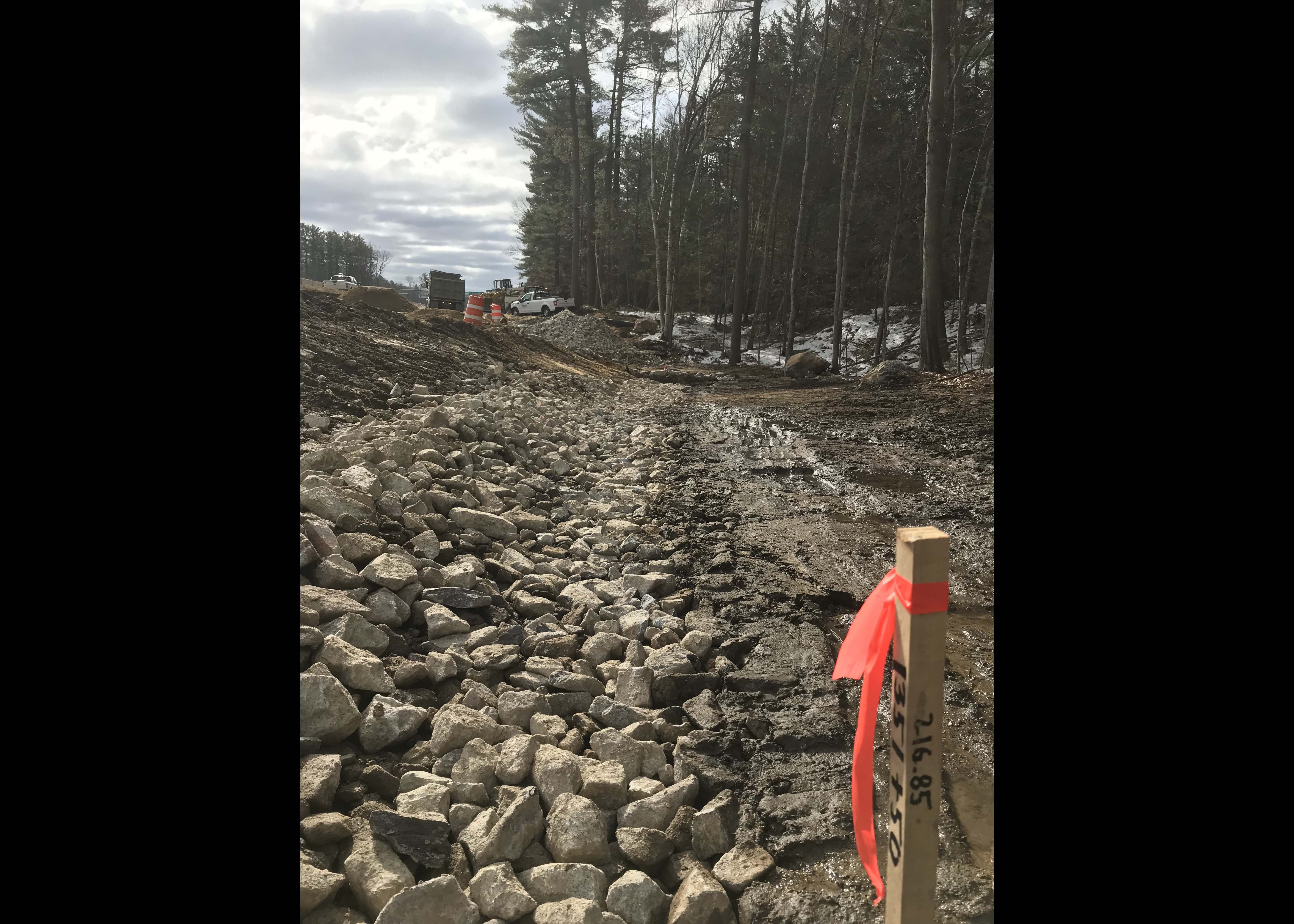

SB Drainage Work – February 2023

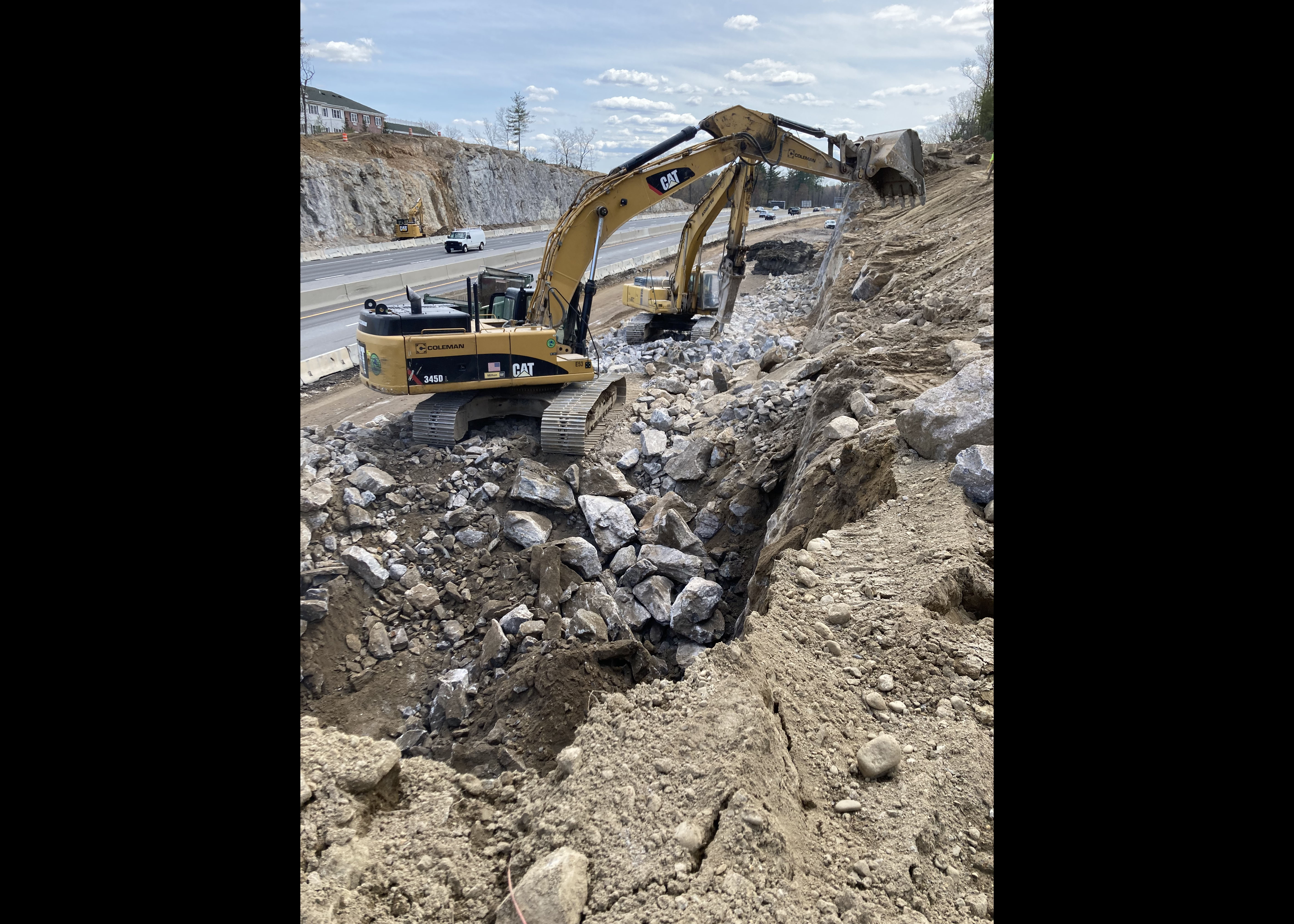

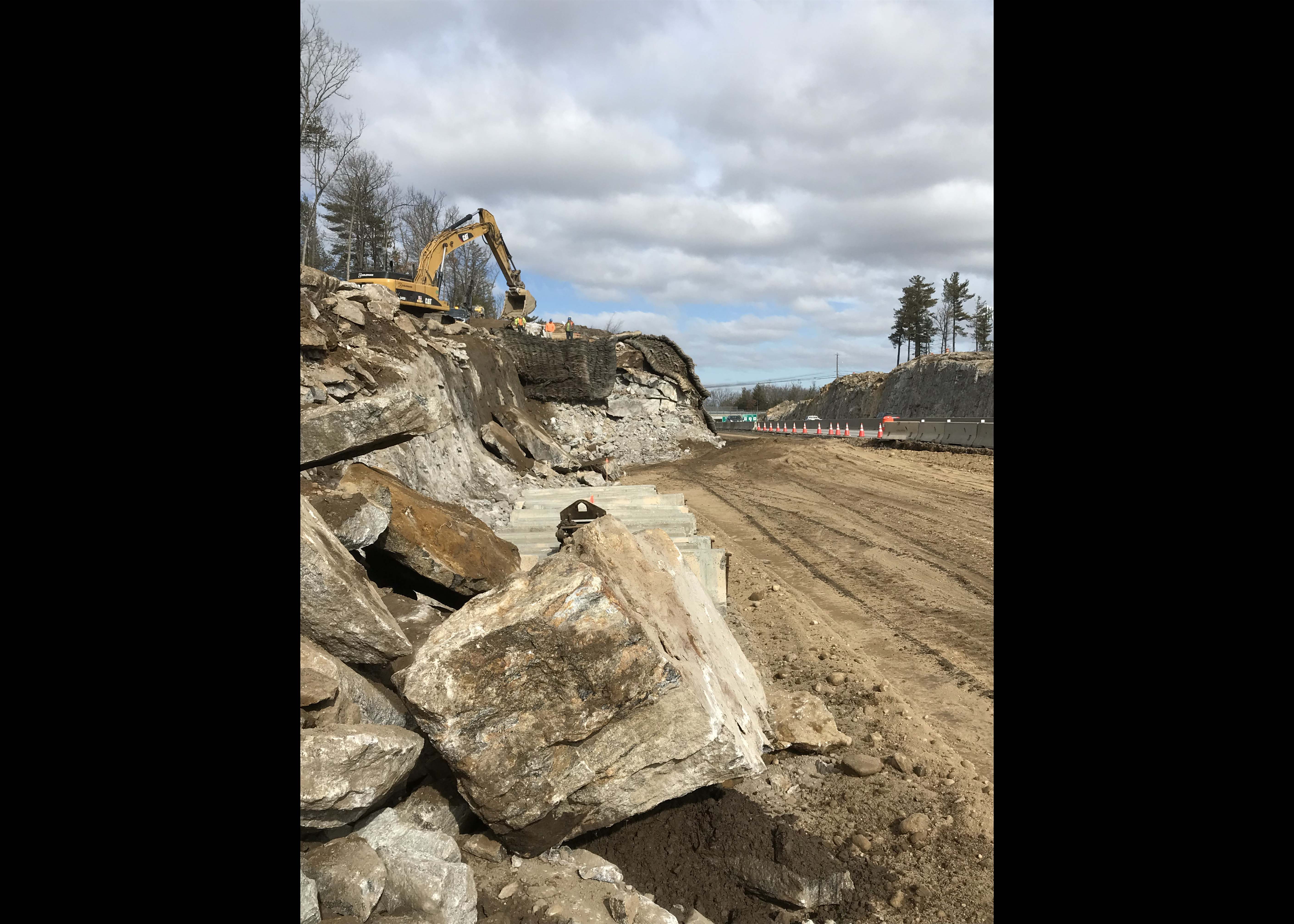

SB Rock Excavation Work – February 2023

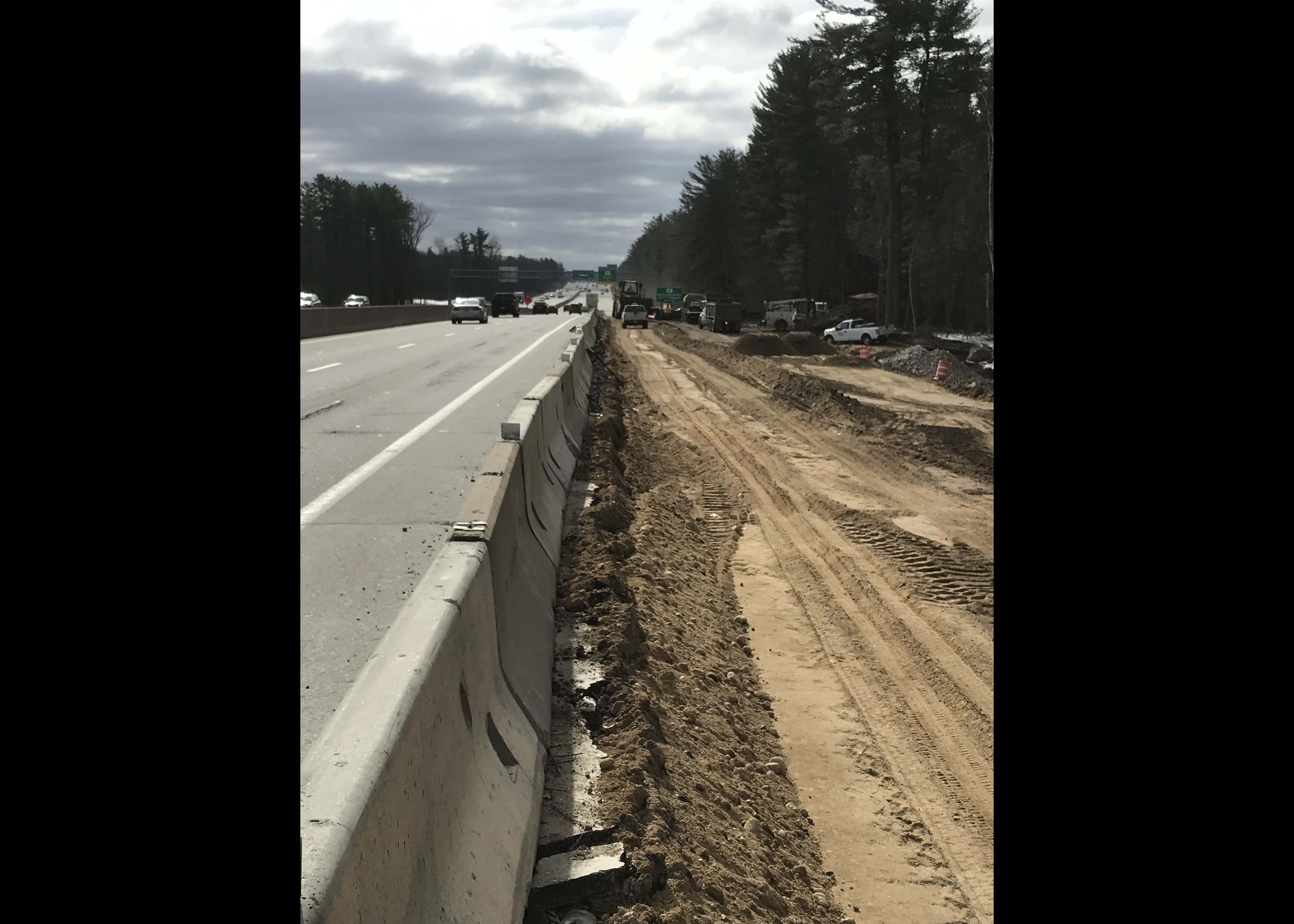

SB Embankment Work – February 2023
SB Drainage Structure Installation – February 2023

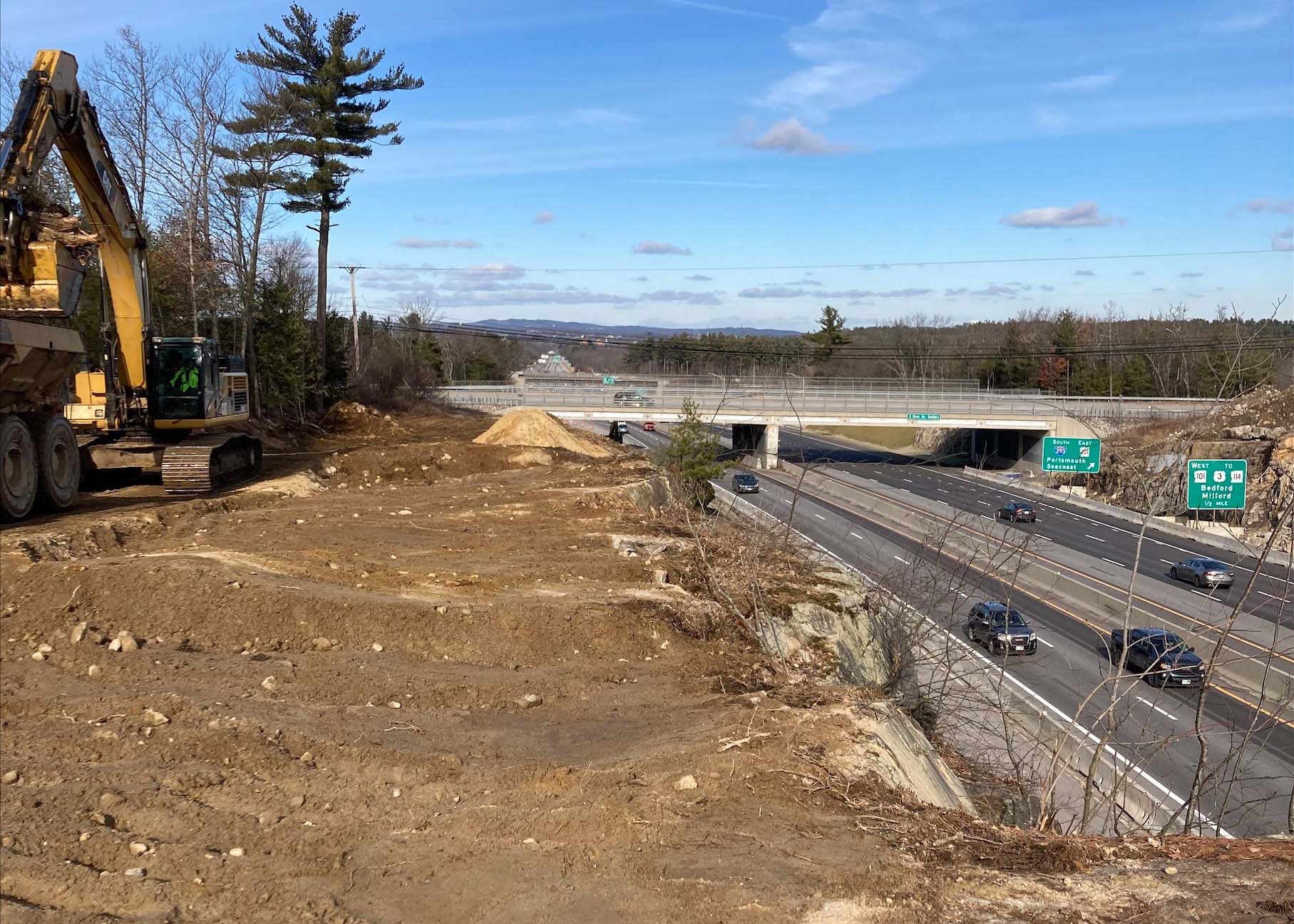

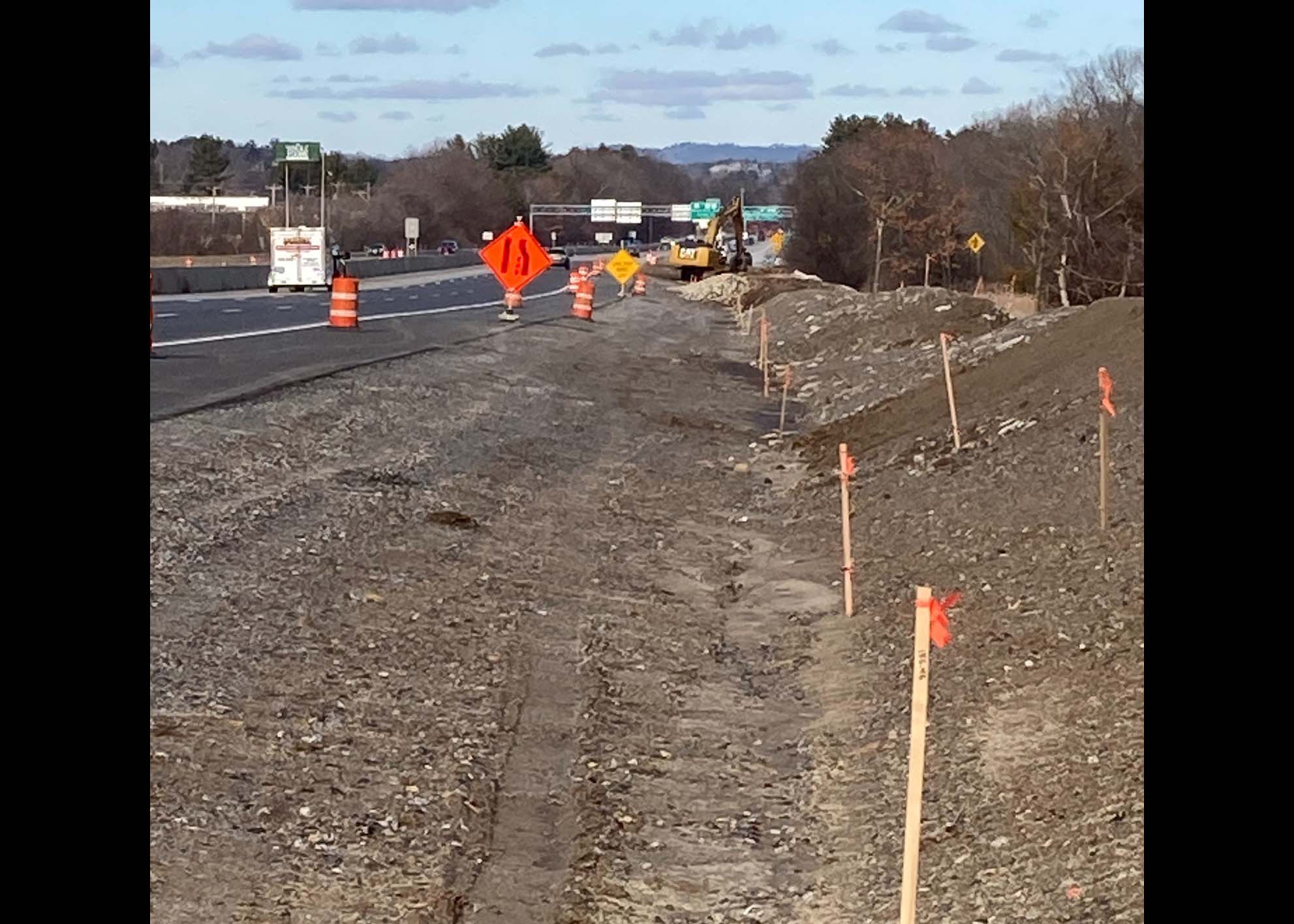

Roadway Select Materials Adjacent to NB Travel Lanes – January 2023
Guardrail on NH 101 EB On-Ramp to NB Mainline – January 2023

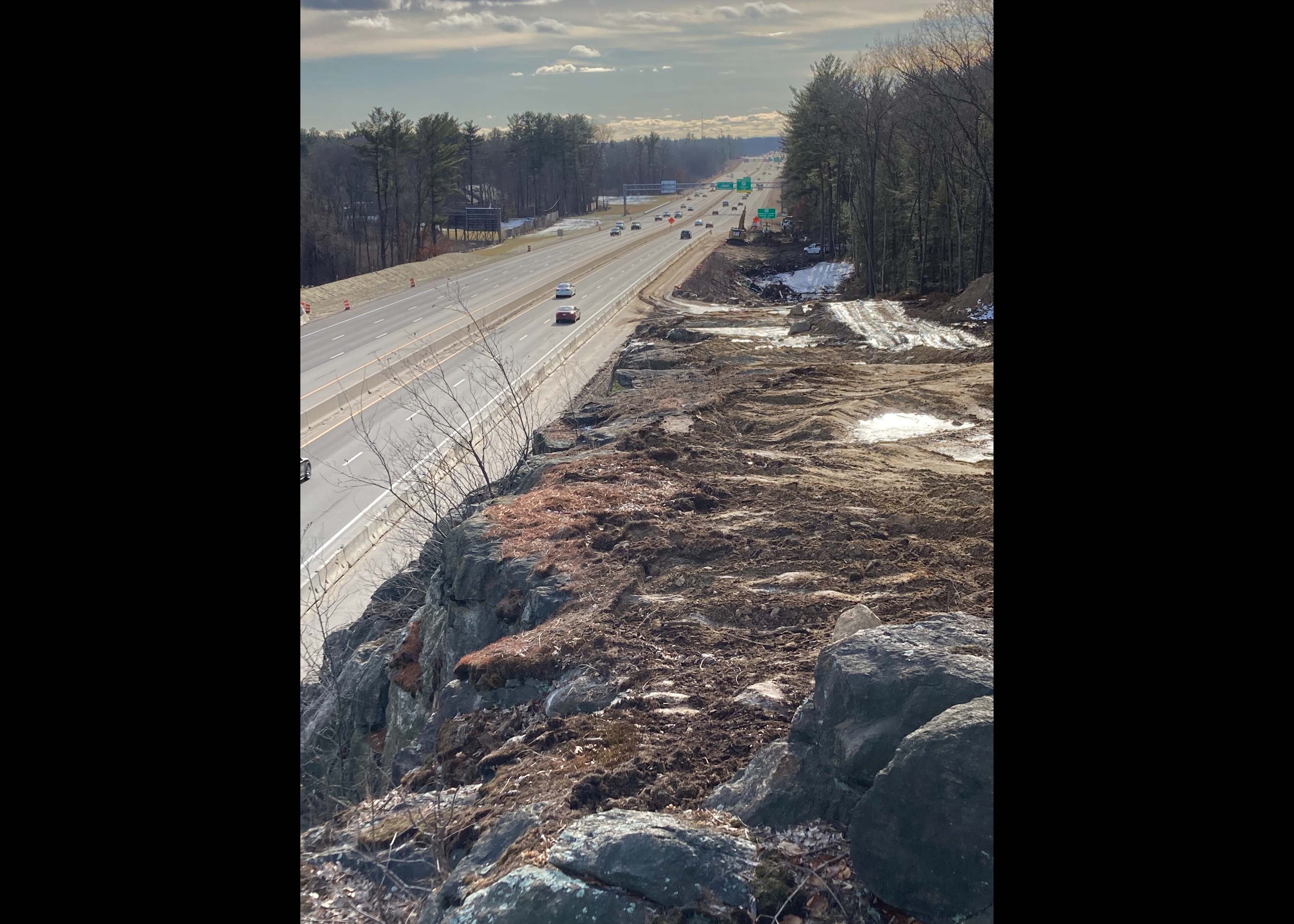

SB Ledge Excavation Work – January 2023
SB Ledge Excavation Work – January 2023
SB Ledge Excavation Work – January 2023

Paving NB Travel Lanes – December 2022

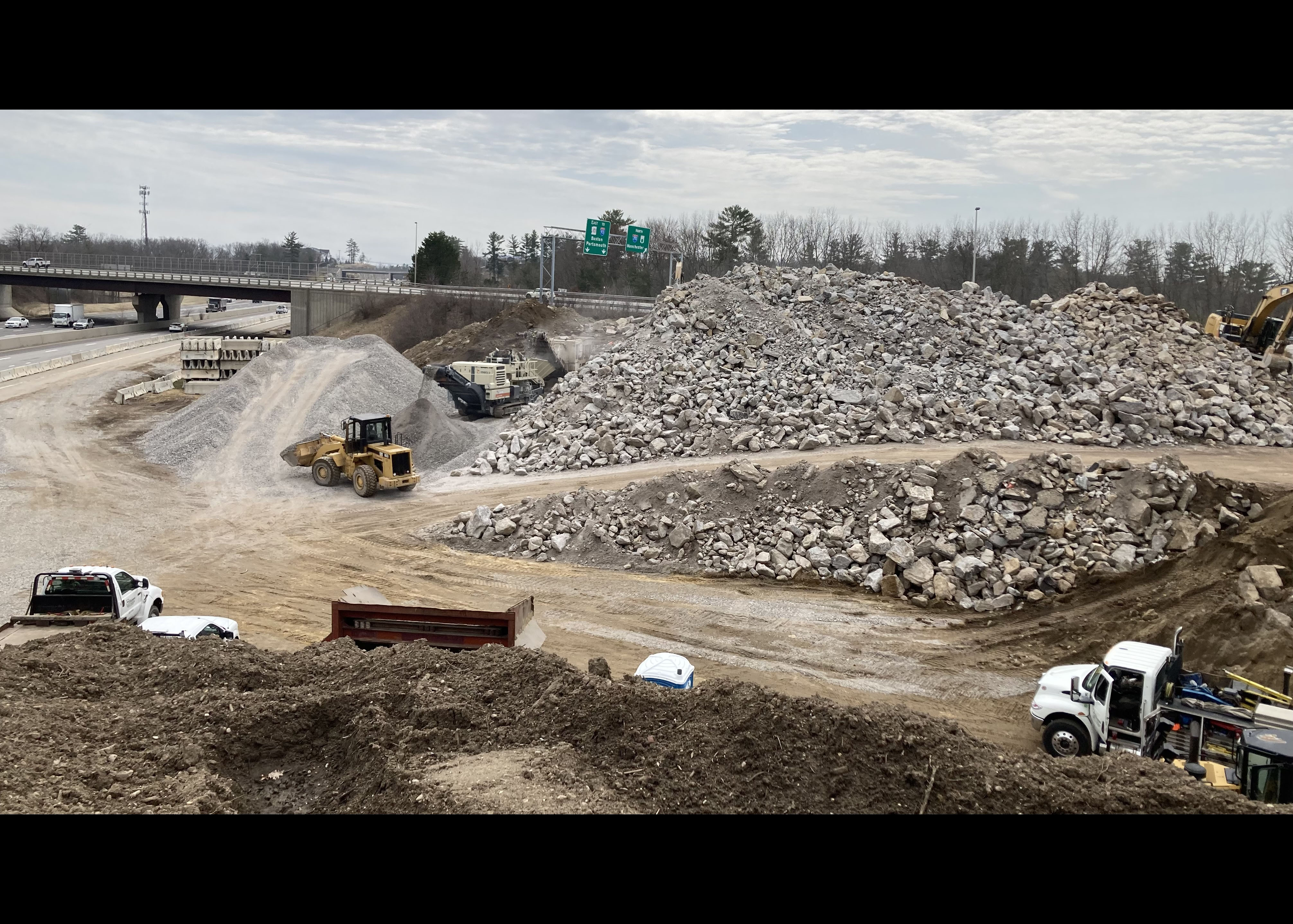

Rock Crushing to Select Materials – December 2022

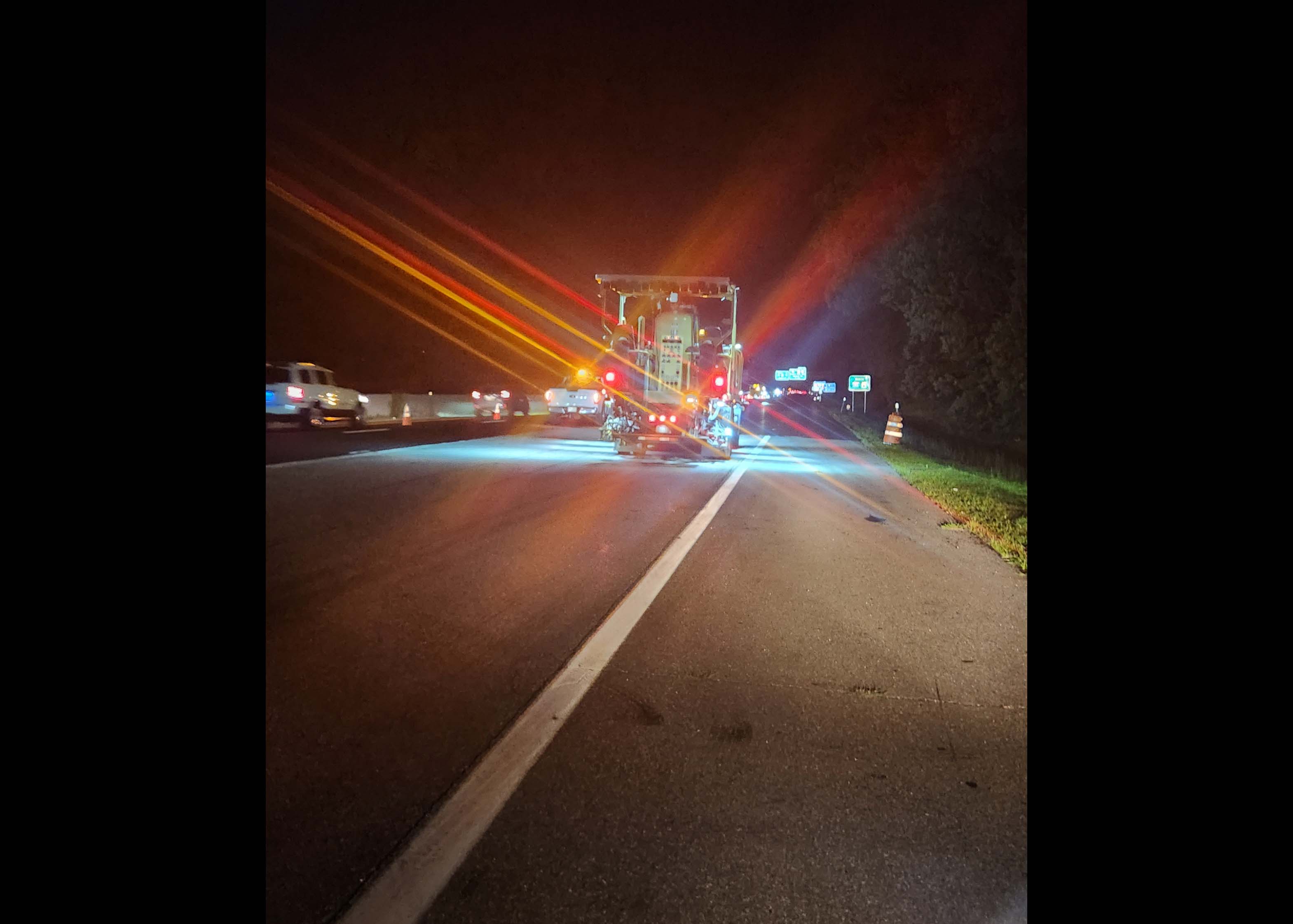

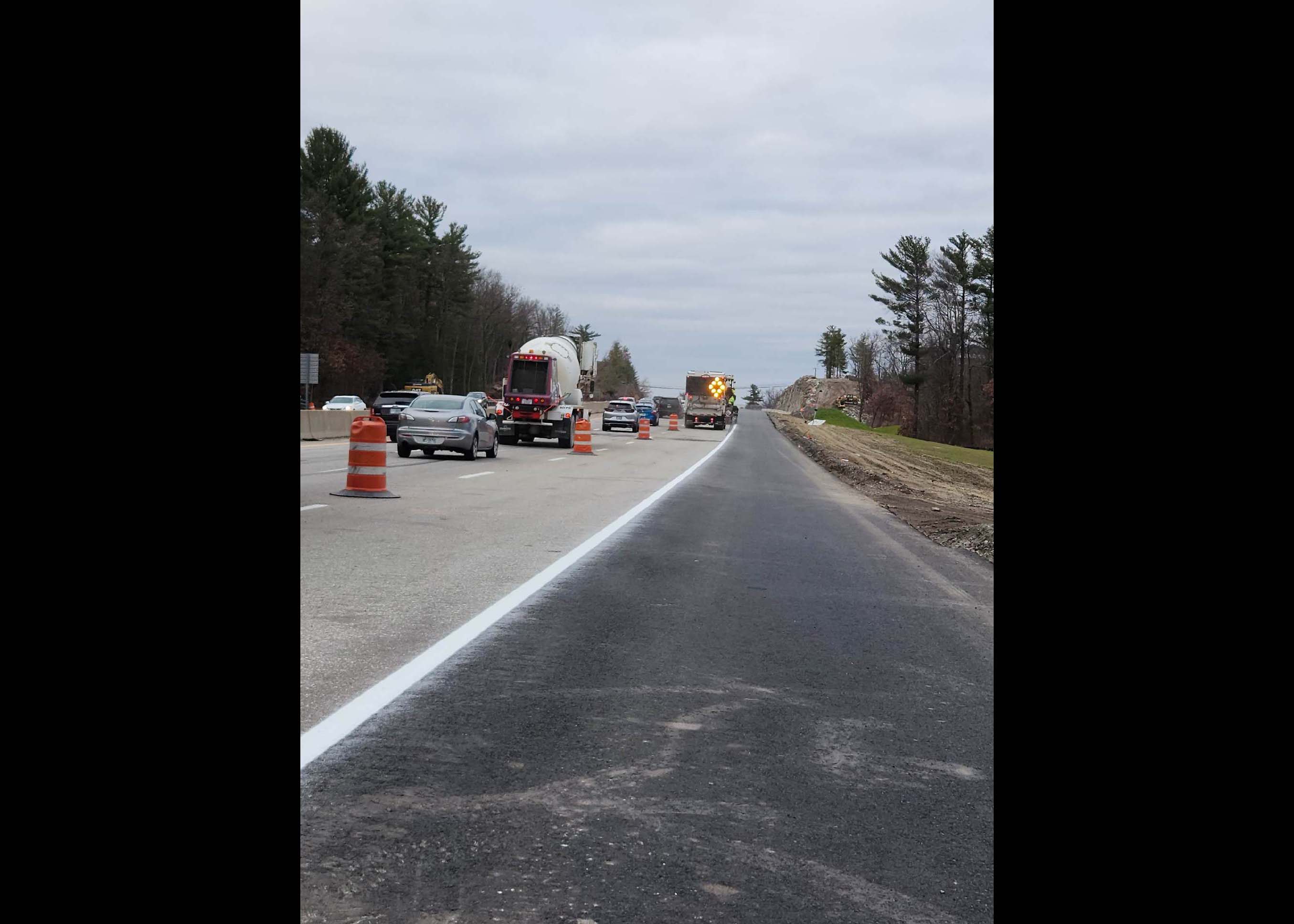

Pavement Markings on NB Travel Lanes – December 2022

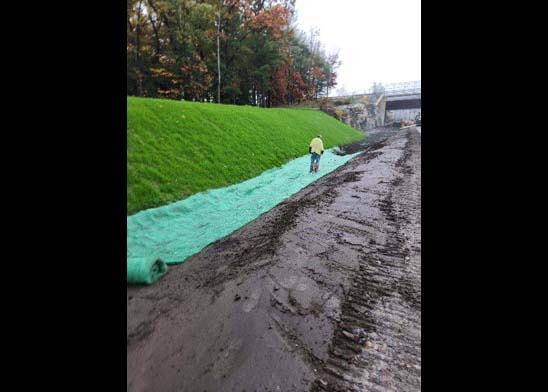

Installing Channel Matting Adjacent to NB Travel Lanes – November 2022
Rock Crushing to Select Materials – November 2022

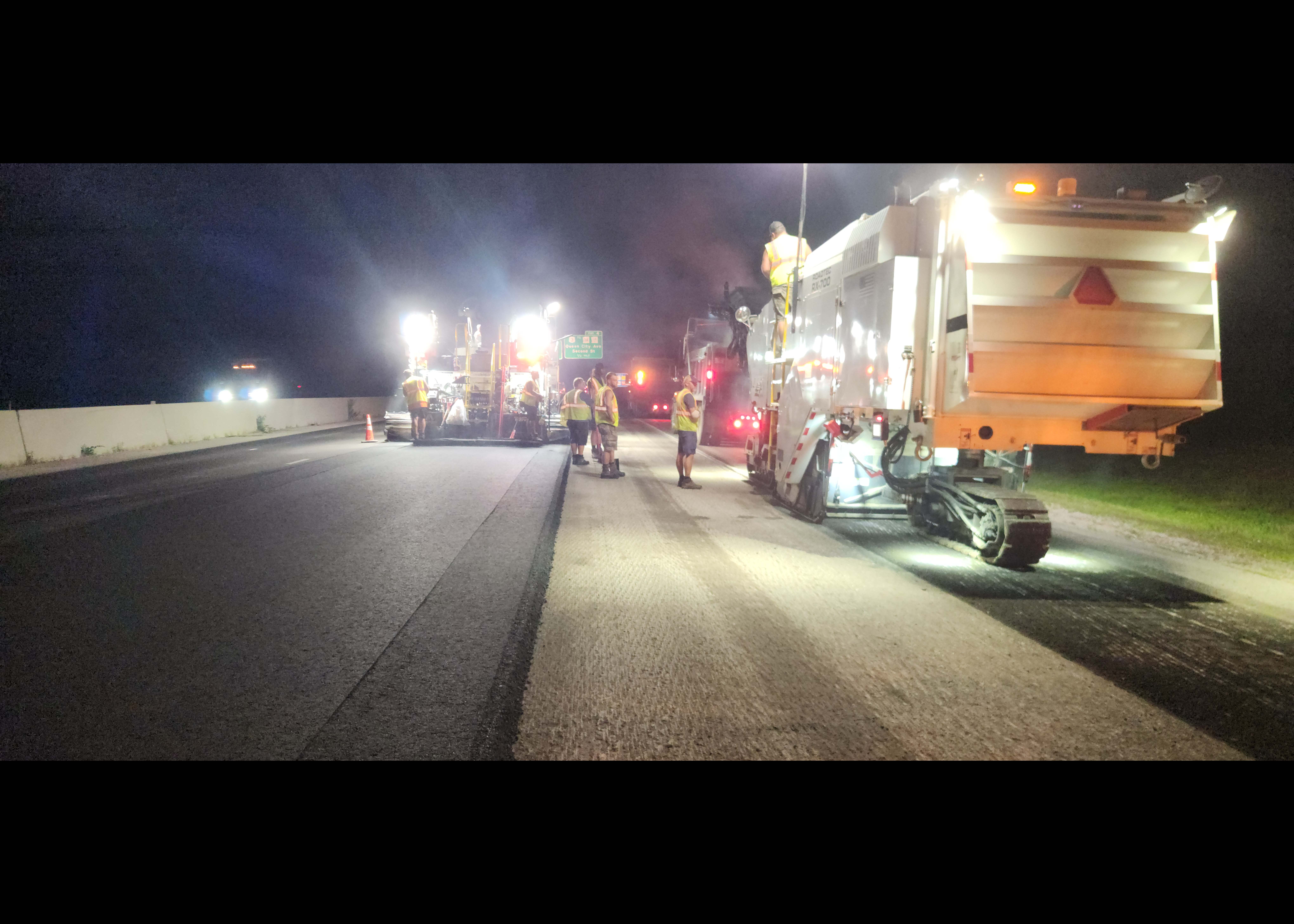

Nighttime Milling Operations on NB Travel Lanes – November 2022

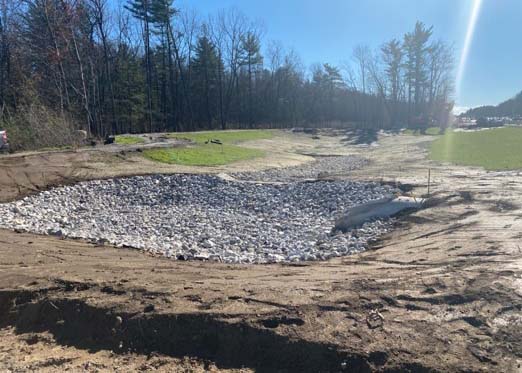

Stormwater Treatment Basin – November 2022

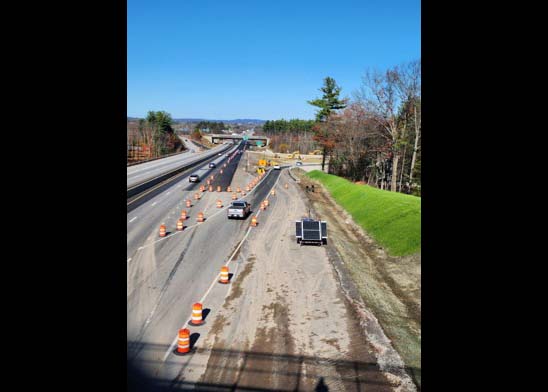

Temporary NH 101 EB Off-Ramp – November 2022

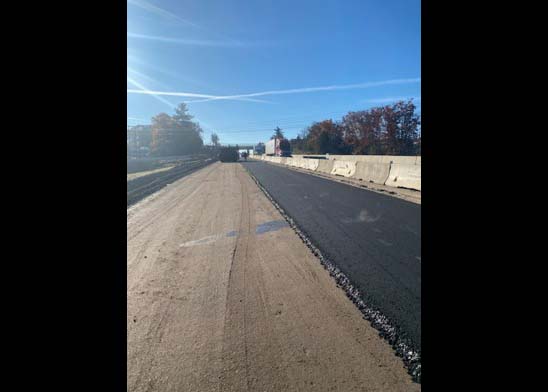

NB Pavement Operations – November 2022

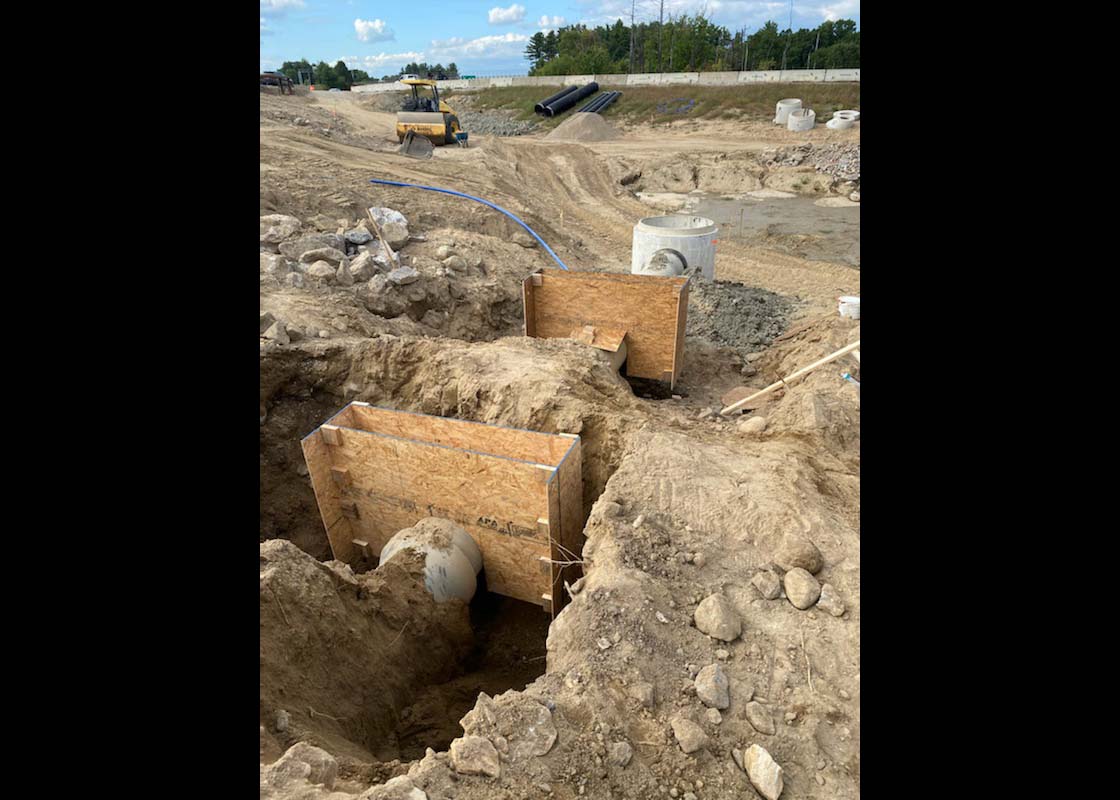

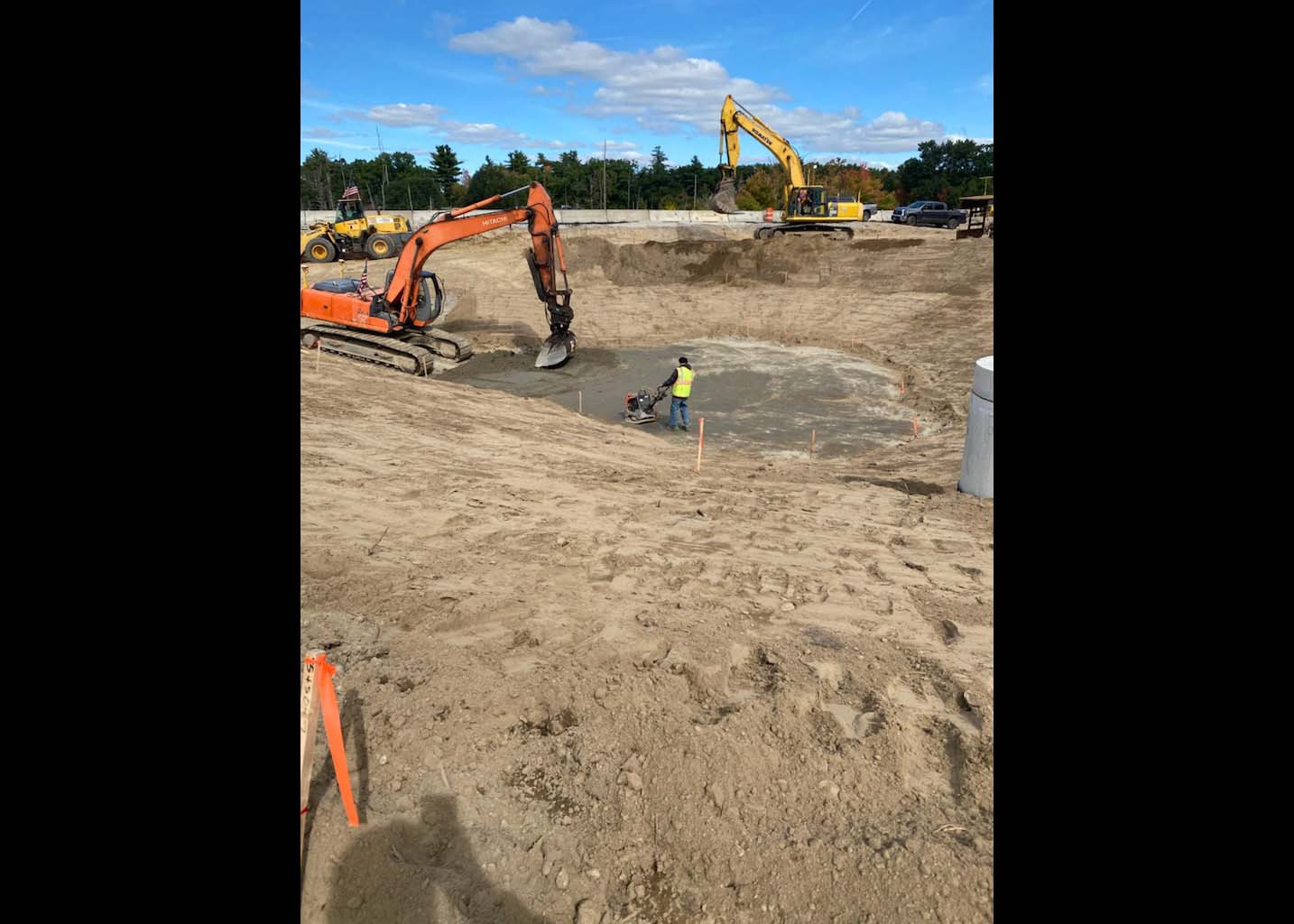

Installing Anti-Seep Collars Within Stormwater Treatment Basin – October 2022
Placing Low-Permeability Fill Within Stormwater Treatment Basin – October 2022

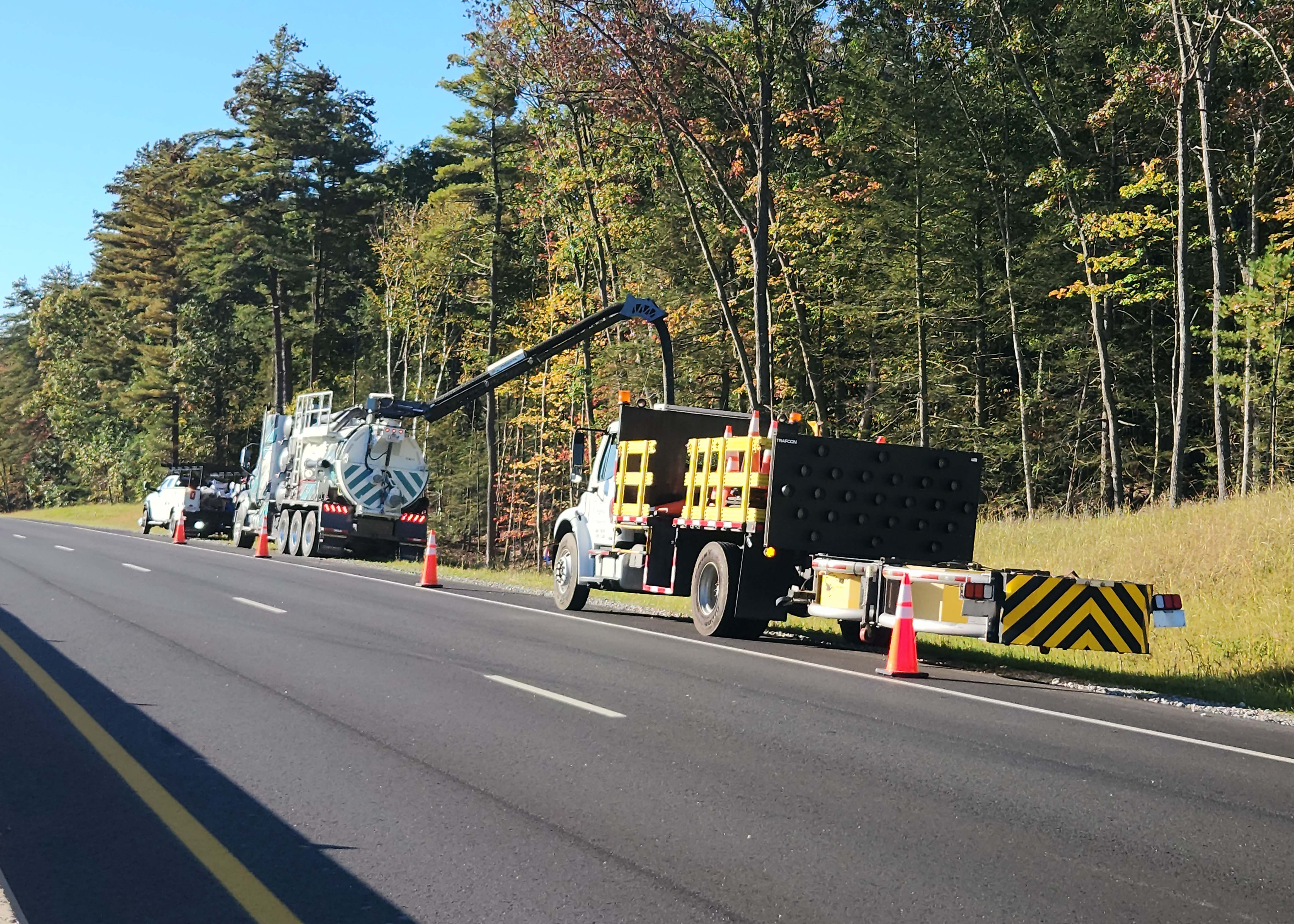

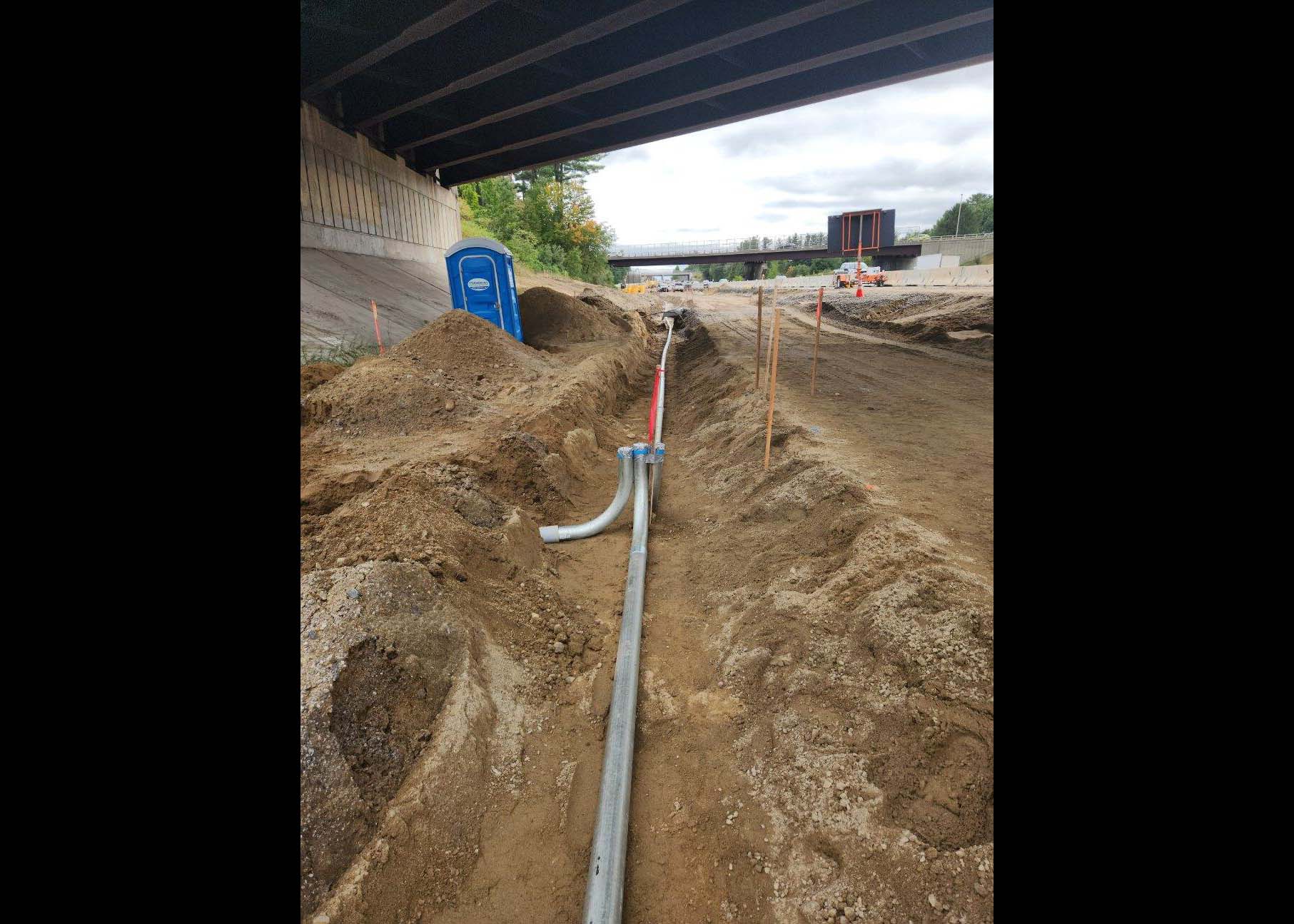

Installation of Conduit for Highway Lighting Adjacent to NB Travel Lanes – October 2022

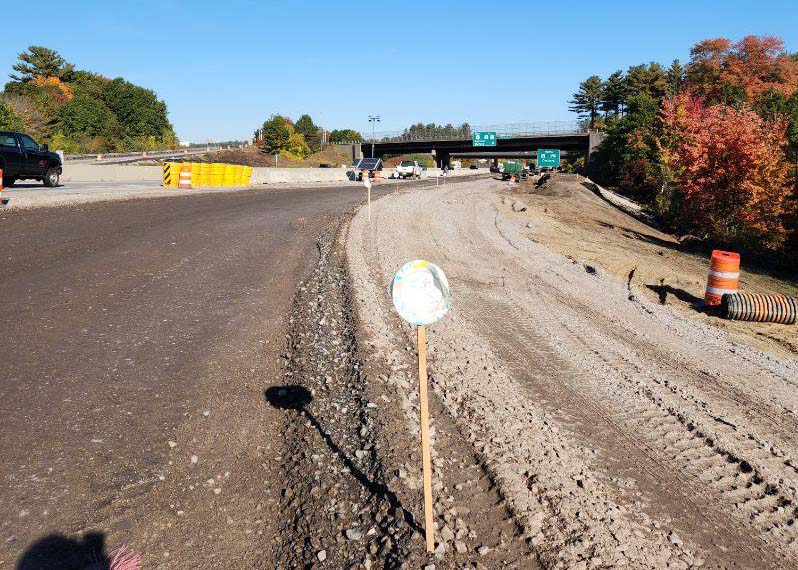

Fine Grading Adjacent to NB Travel Lanes – October 2022

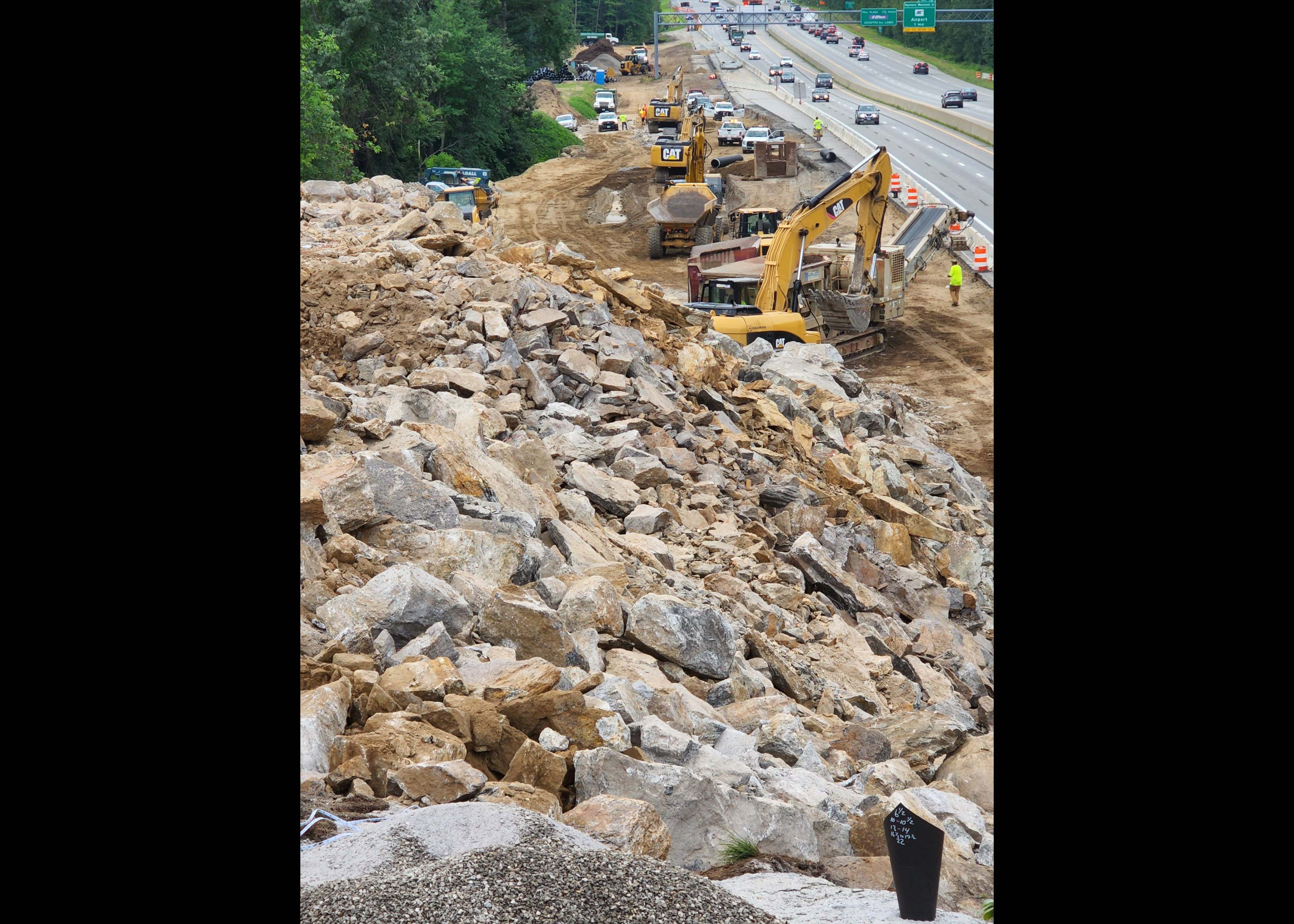

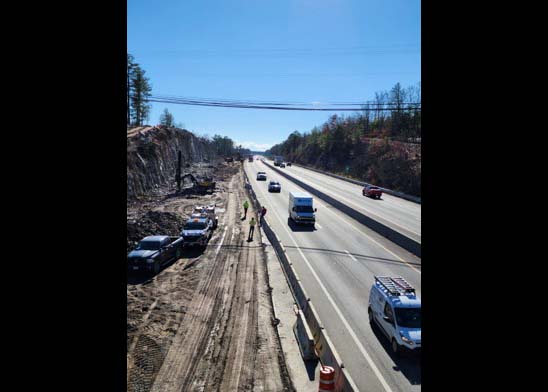

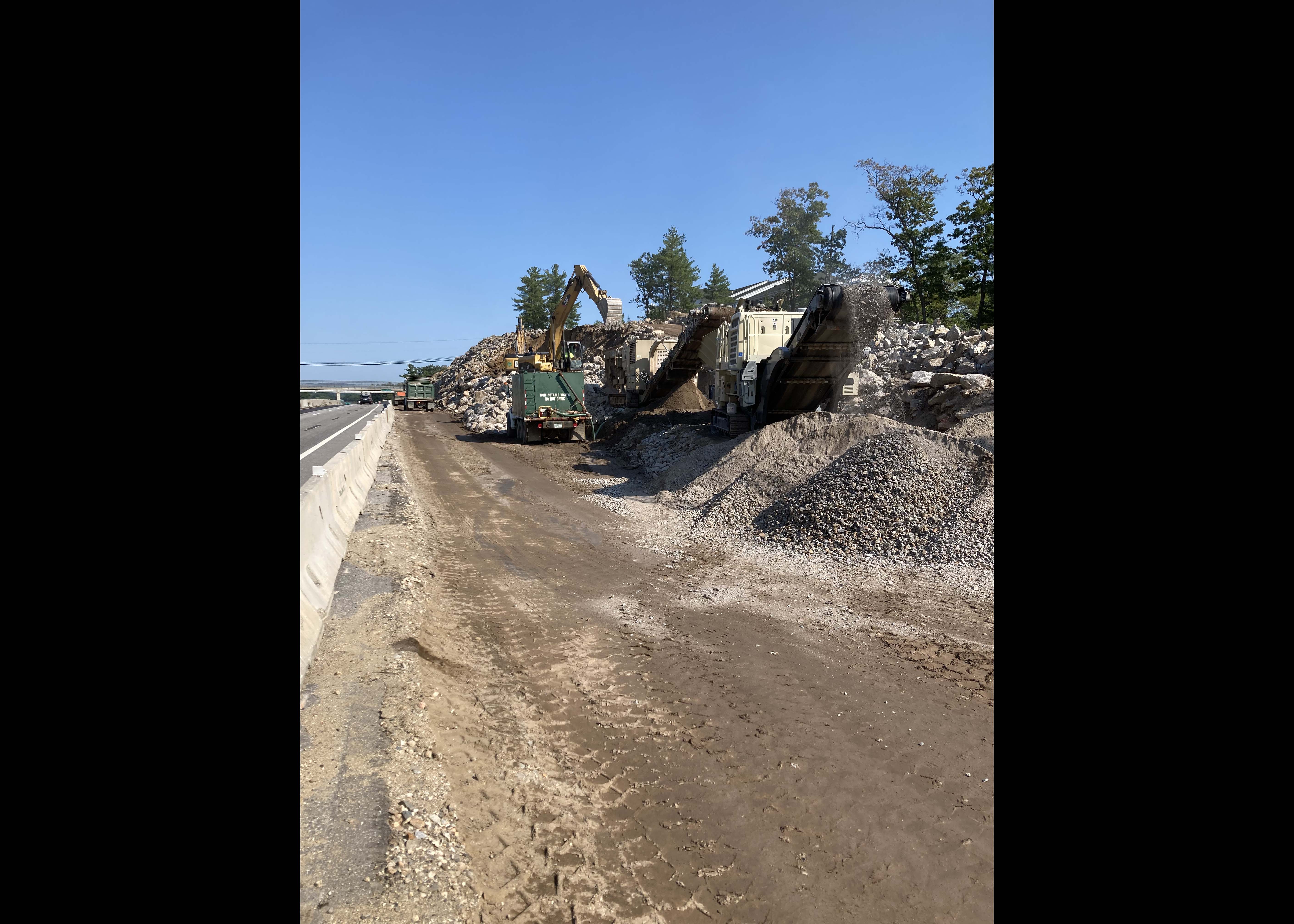

Rock Crushing to Select Materials – October 2022

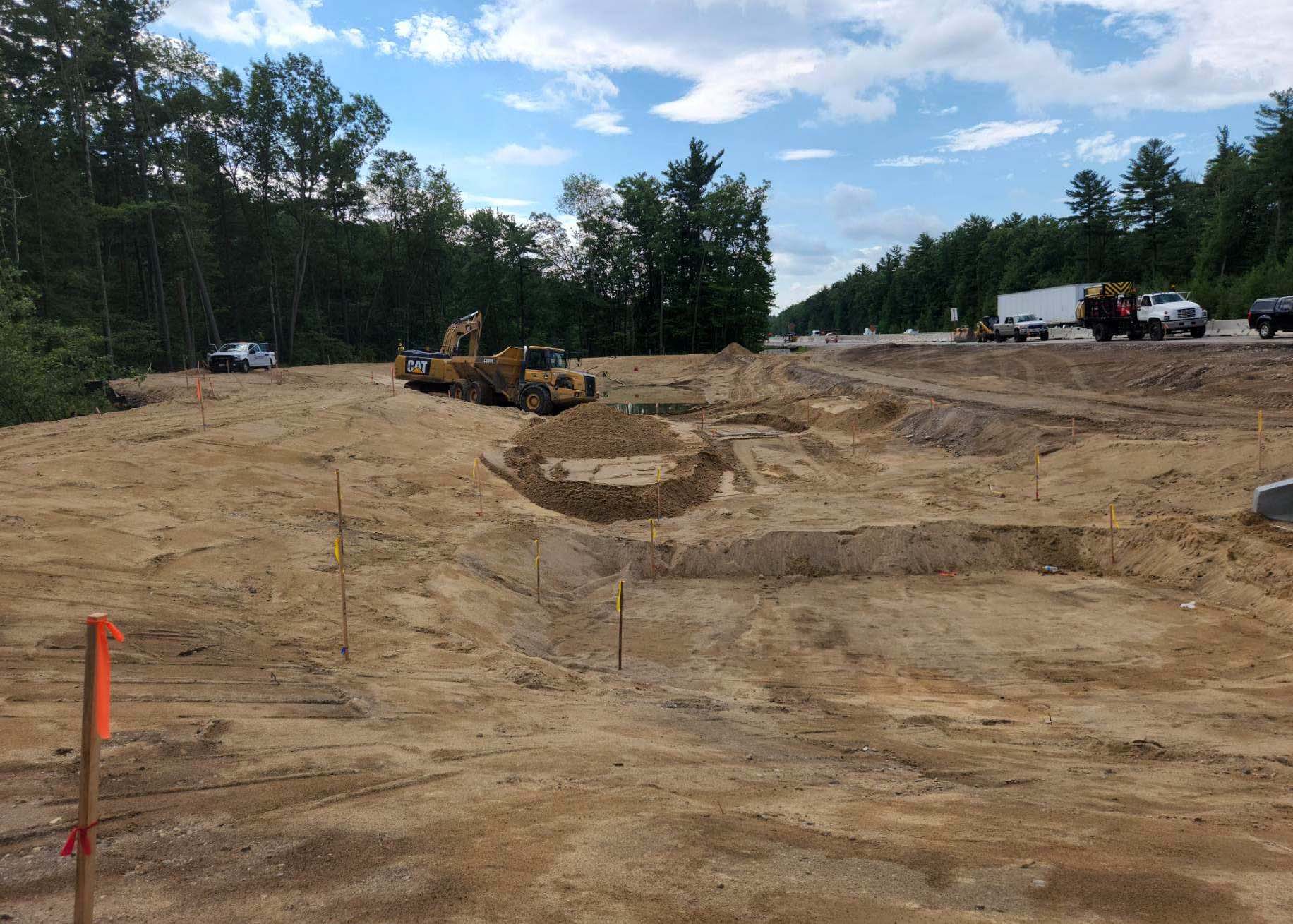

Stormwater Treatment Basin - August 2022

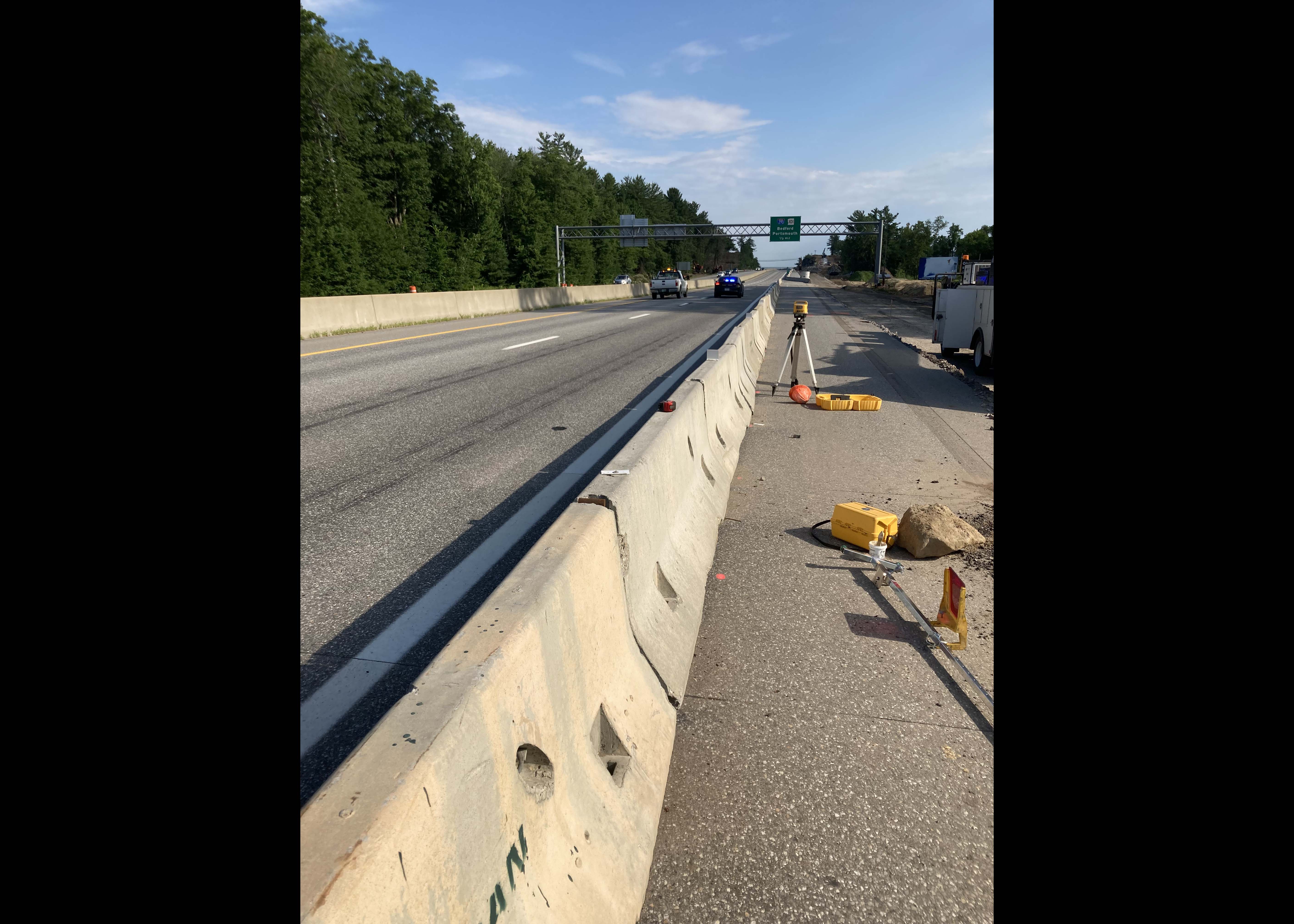

Drainage installation Adjacent to NB Travel Lanes - August 2022

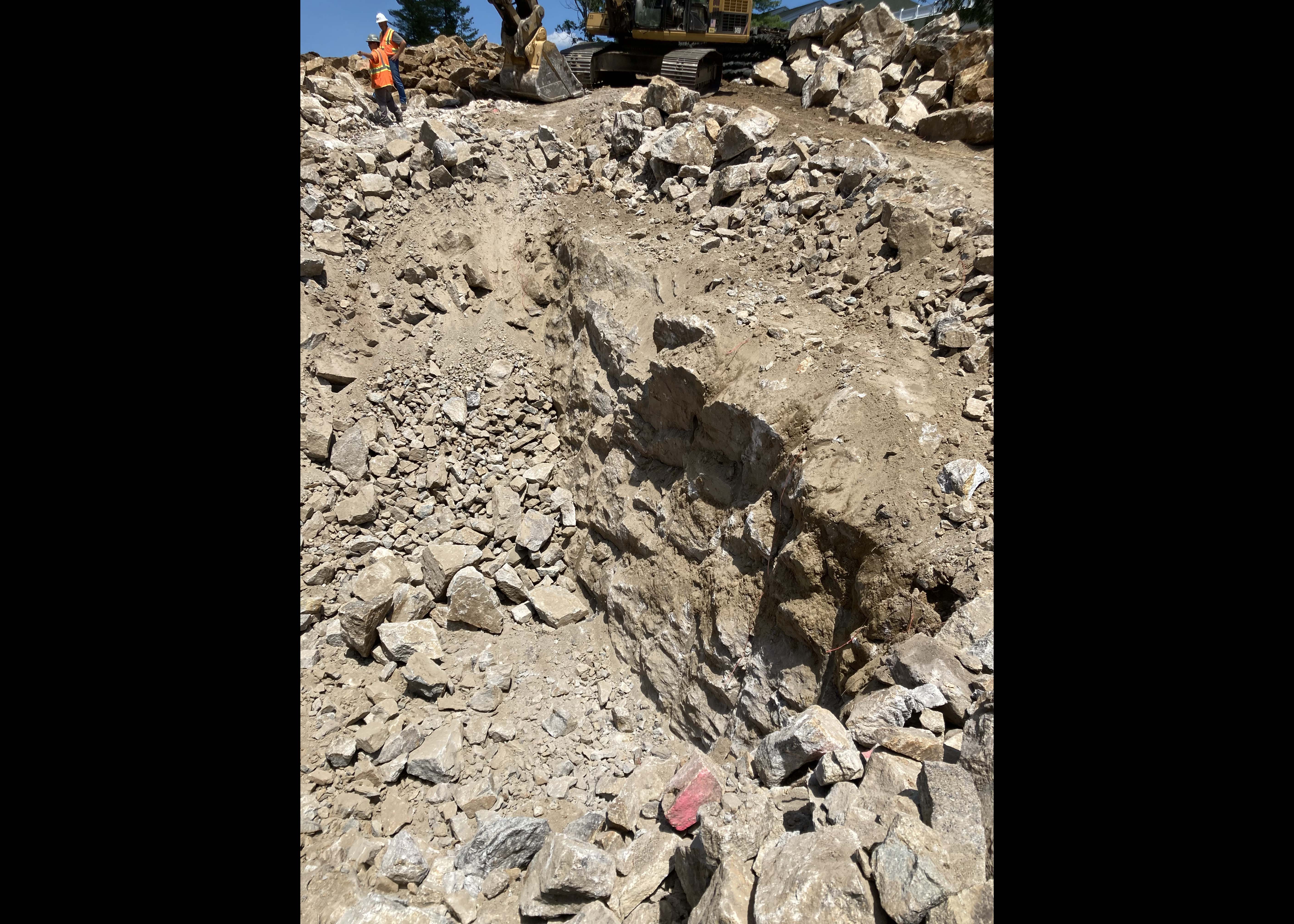

Blasting Operations (pre-split wall) to Remove Ledge Adjacent to NB Travel Lanes - August 2022

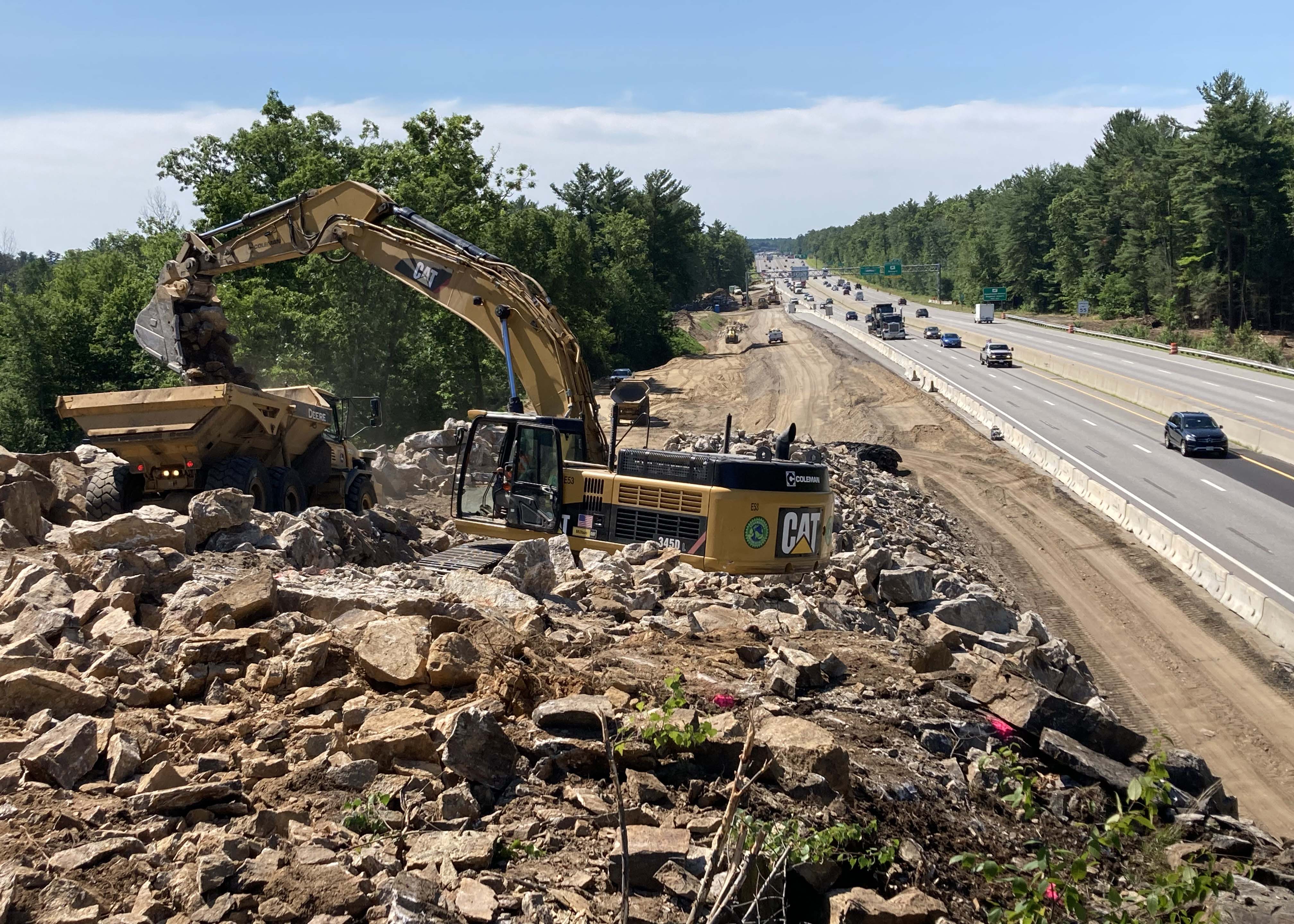

Rock Removal Adjacent to NB Travel Lanes - August 2022

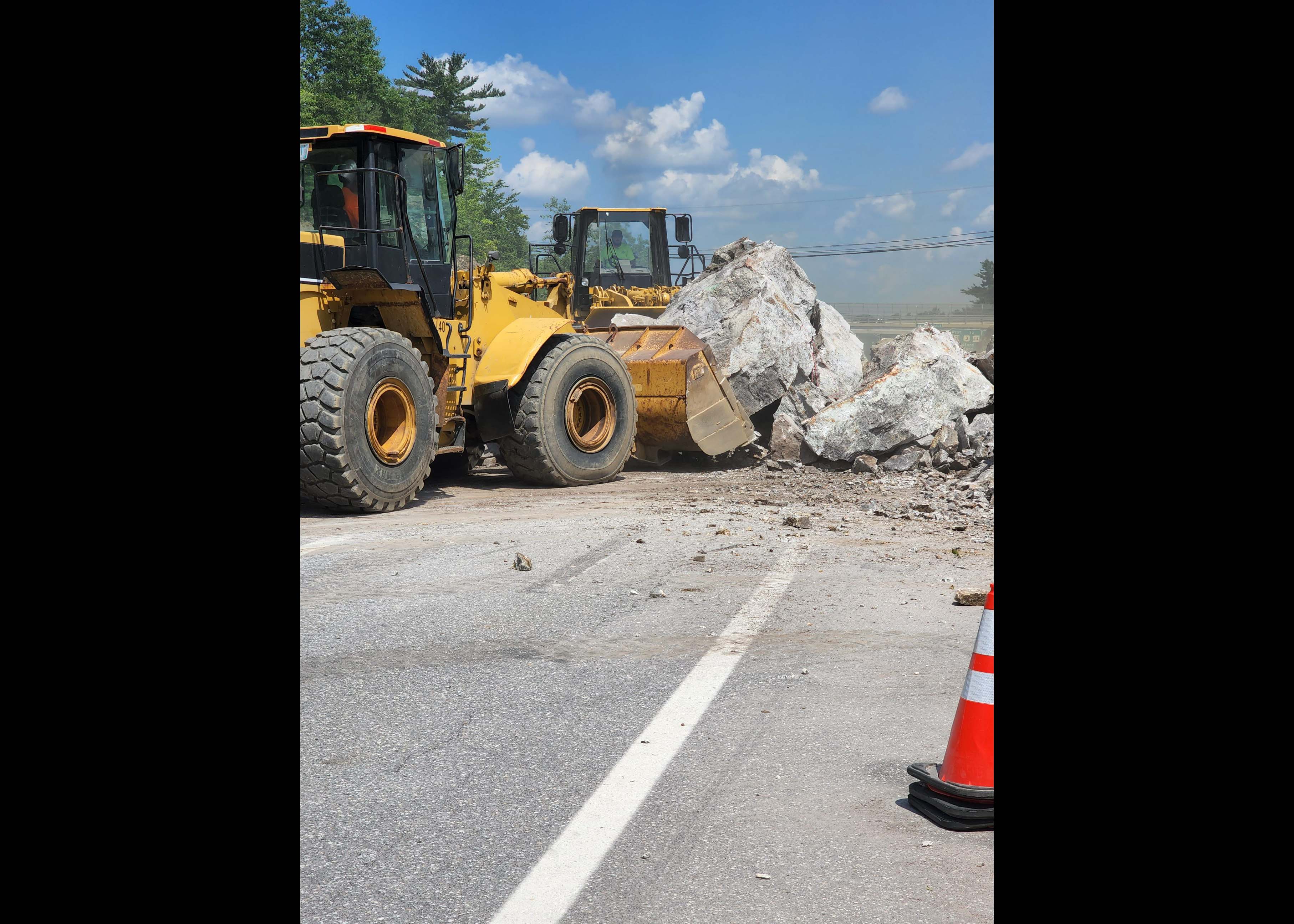

Rock being removed from the road after a blast - August 2022
Rock crushing to select materials - August 2022

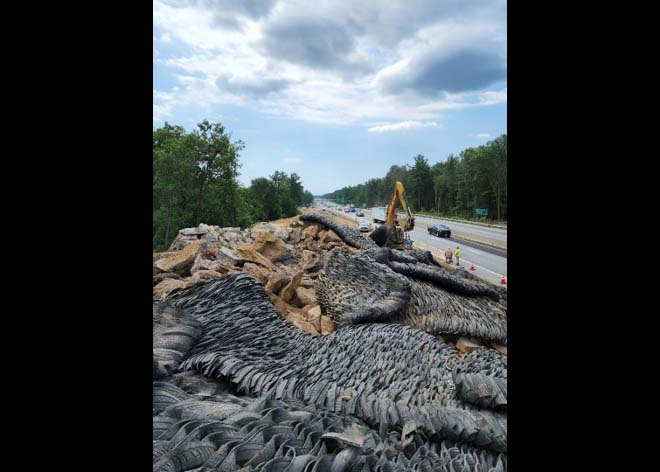

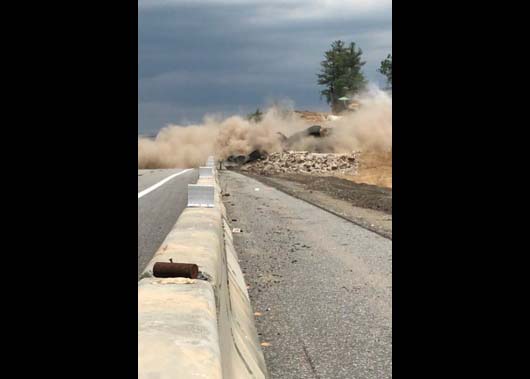

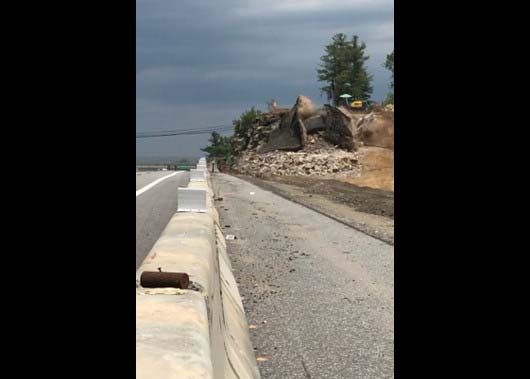

Blasting Operations to Remove Ledge Adjacent to NB Travel Lanes - July 2022
Blasting Operations to Remove Ledge Adjacent to NB Travel Lanes - July 2022
Blasting Operations to Remove Ledge Adjacent to NB Travel Lanes - July 2022

Overhead sign structure removal on F.E. Everett Turnpike south of US Rt.3 bridge - June 2022

Temporary ramp and drainage installation on NH 101 on-ramp to Southbound F.E. Everett Turnpike - June 2022

Tree clearing along Northbound F.E. Everett Turnpike south of US Rt.3 bridge - June 2022
